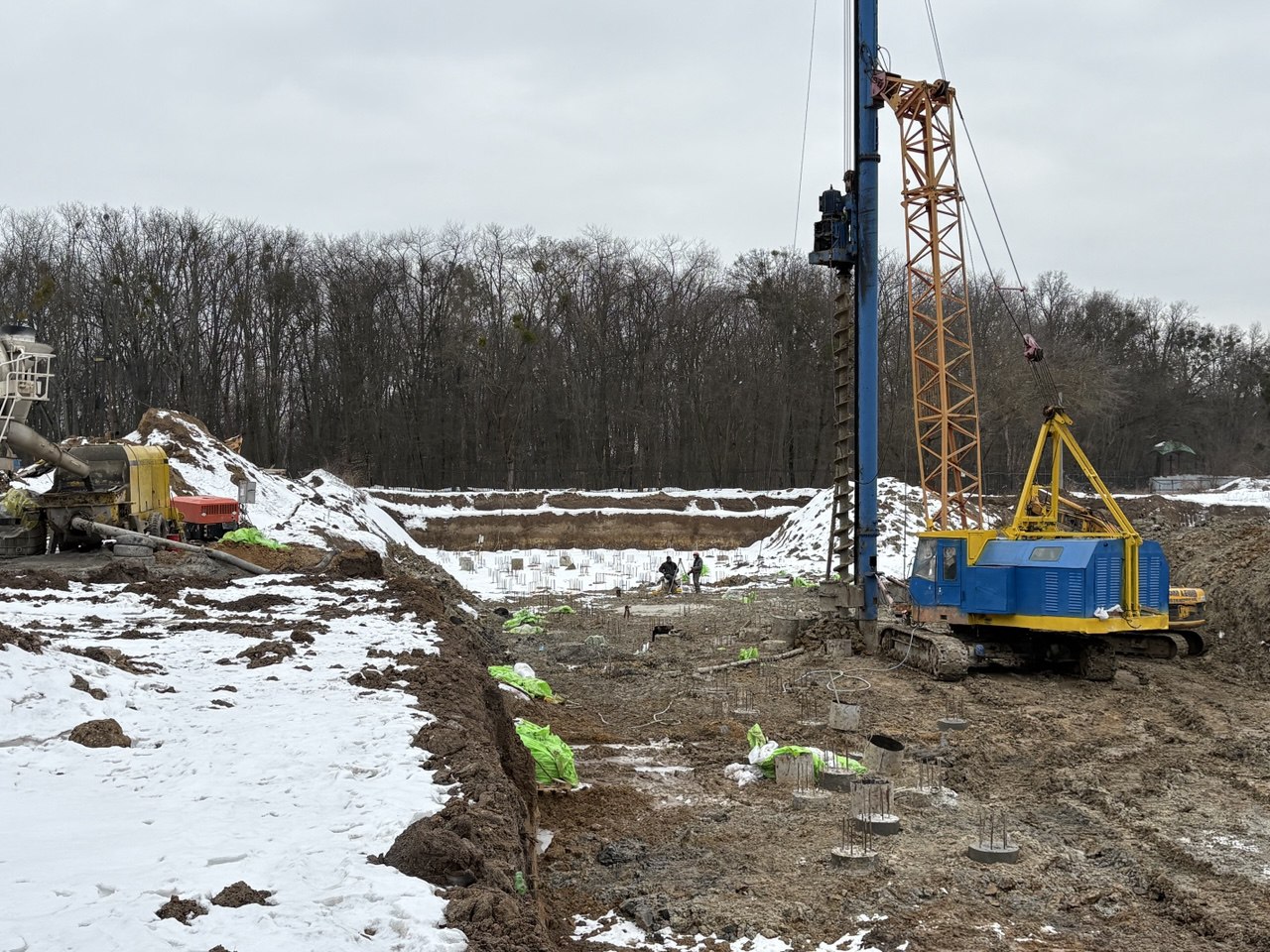

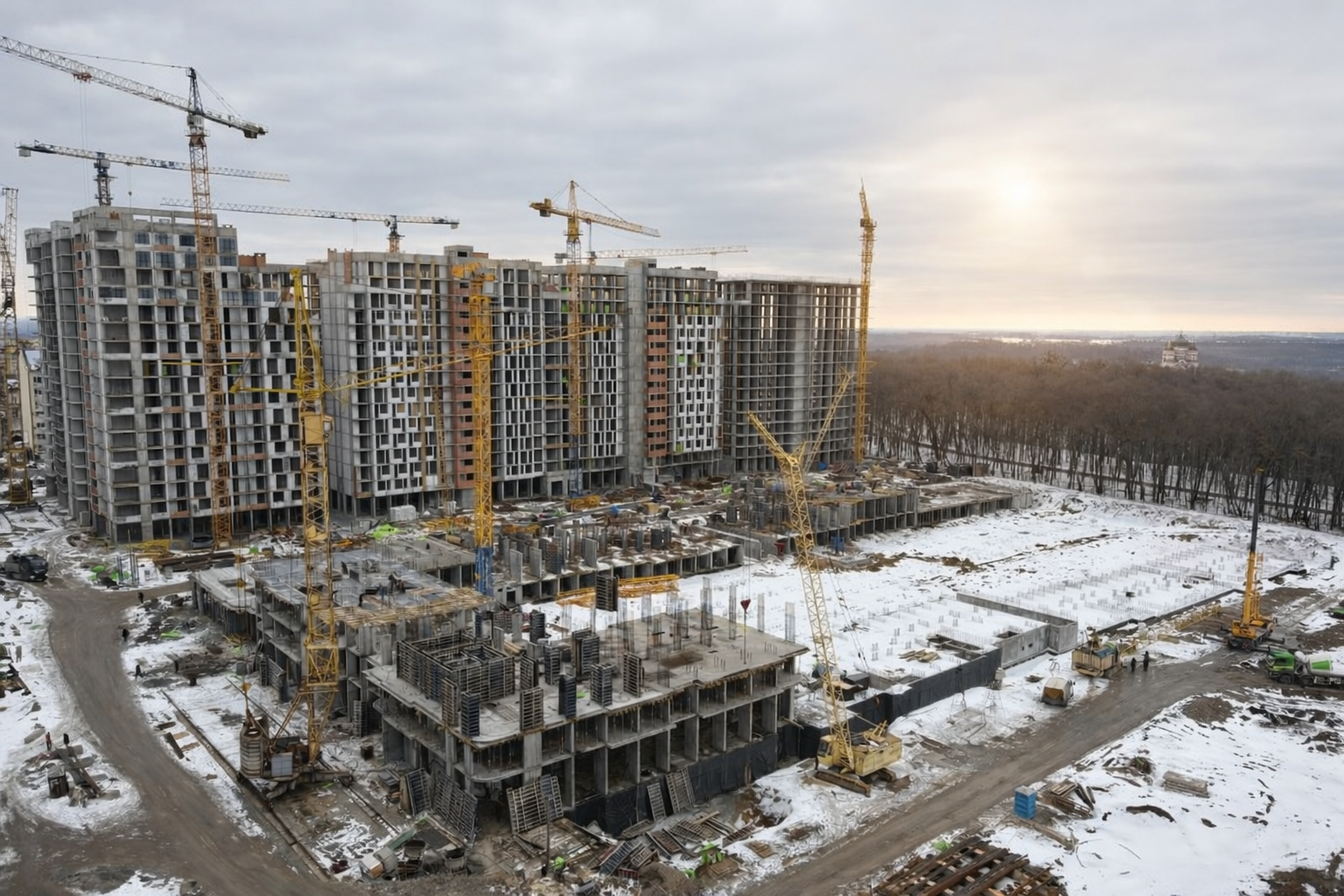

Construction progress

Construction progress

January 2026

We are pleased to share our first construction progress update of the new year:

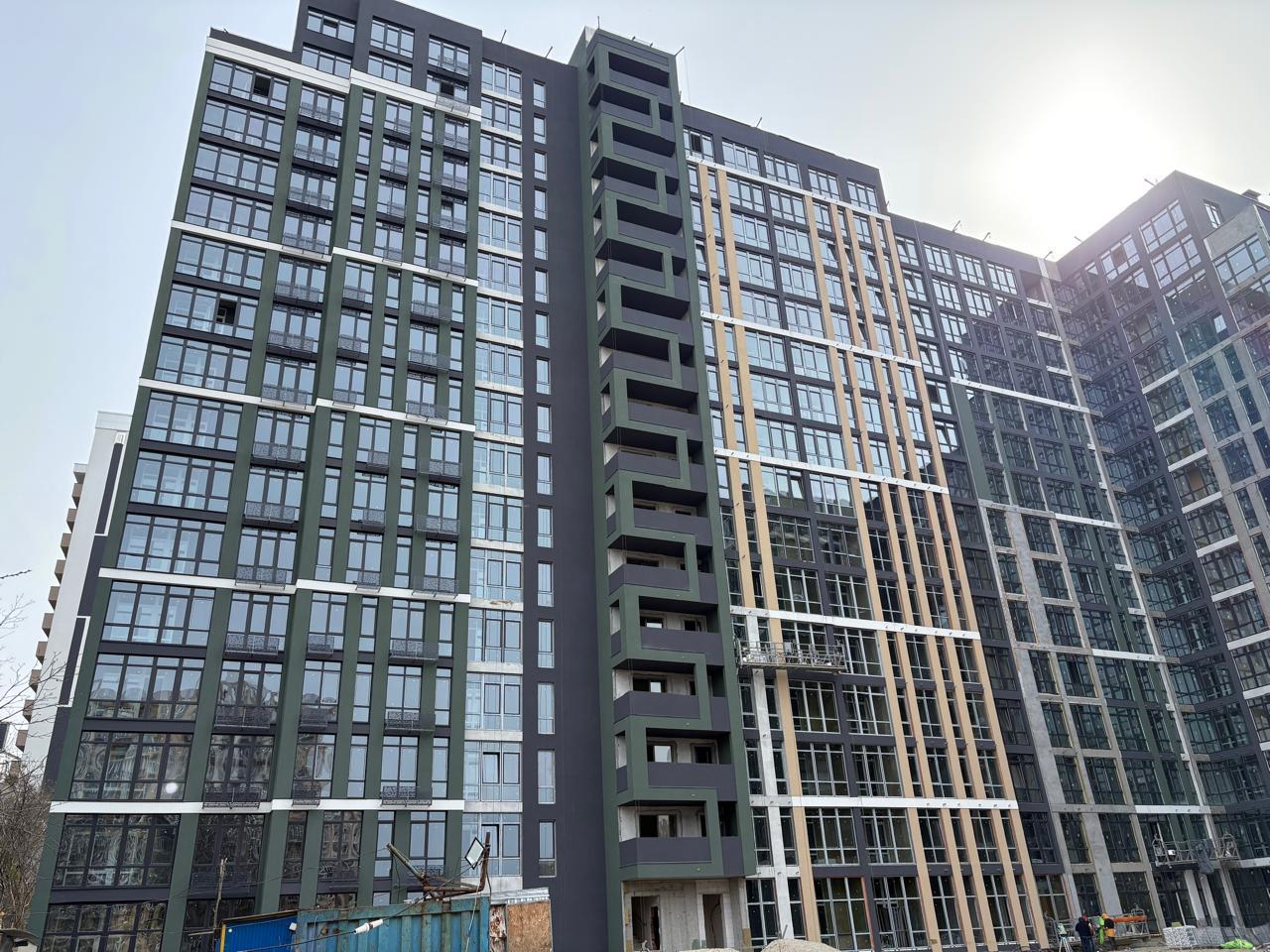

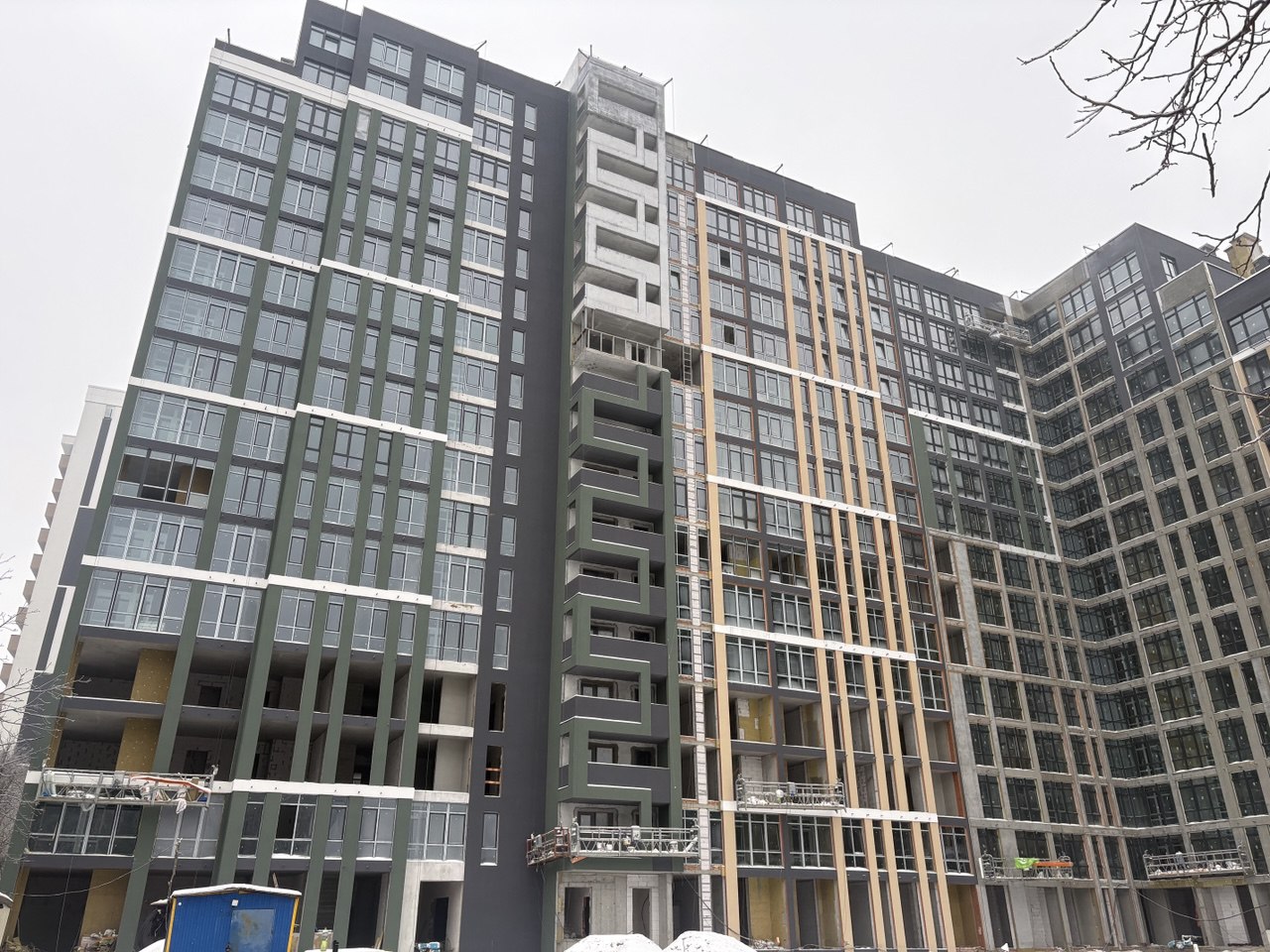

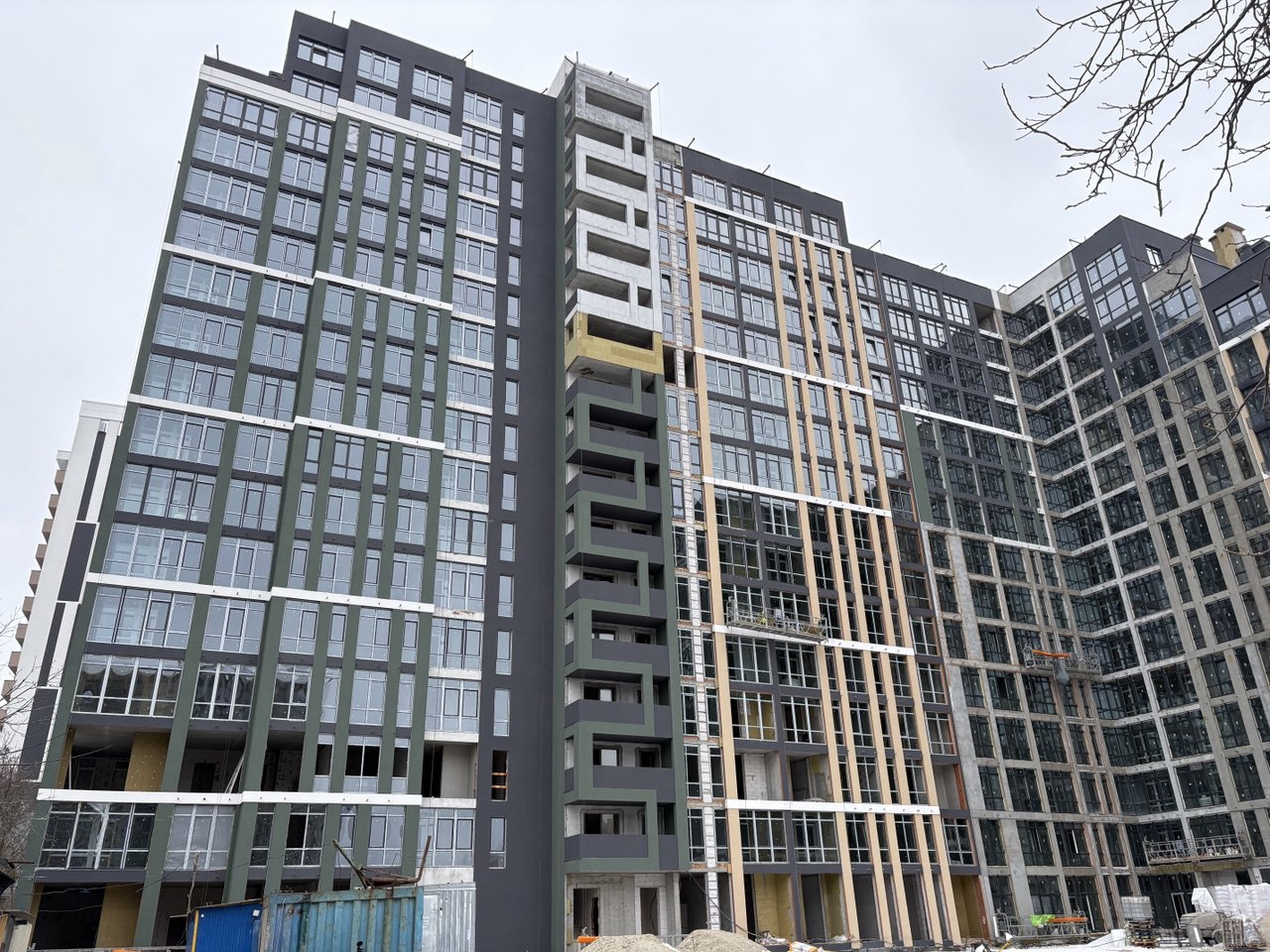

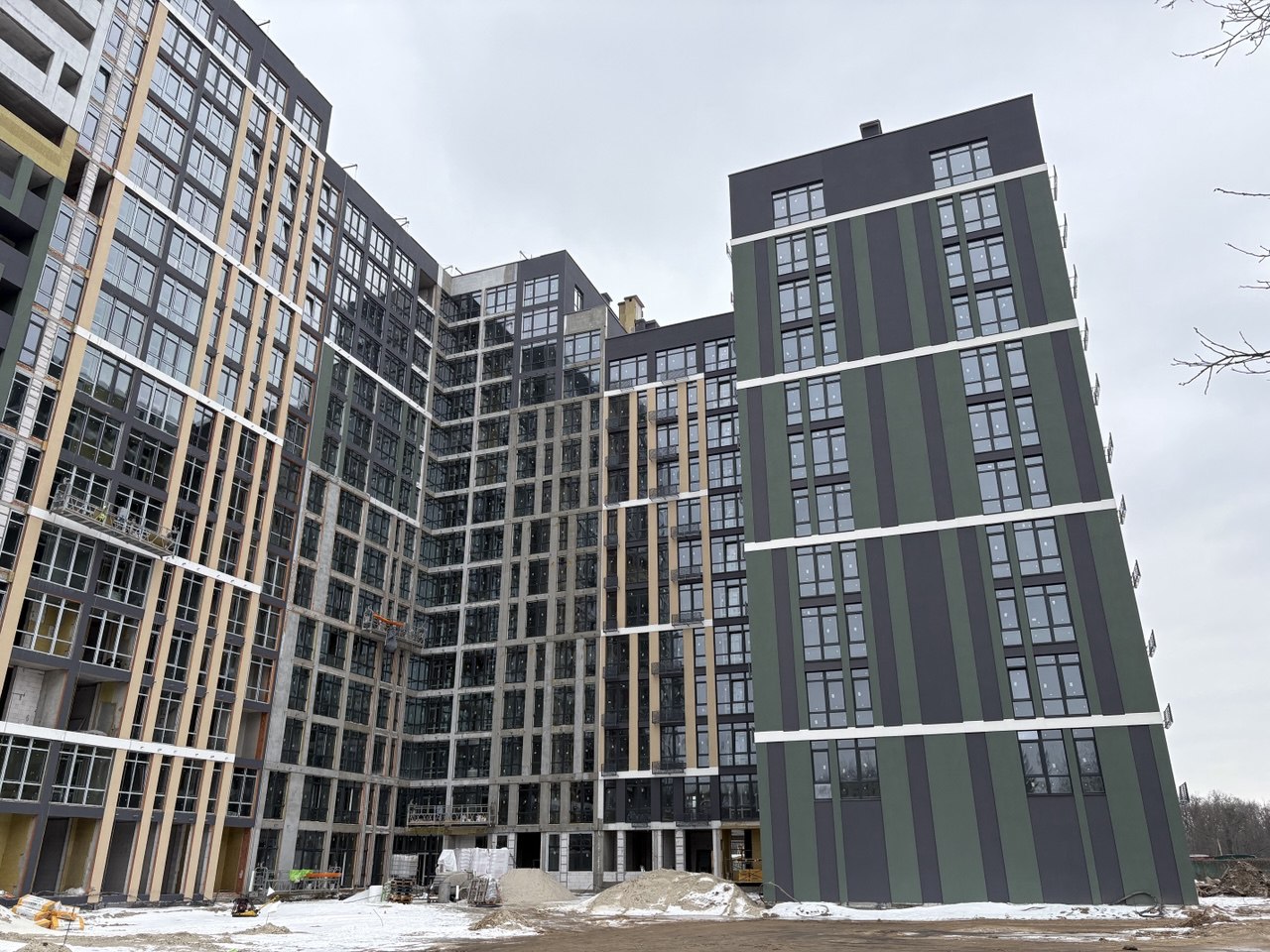

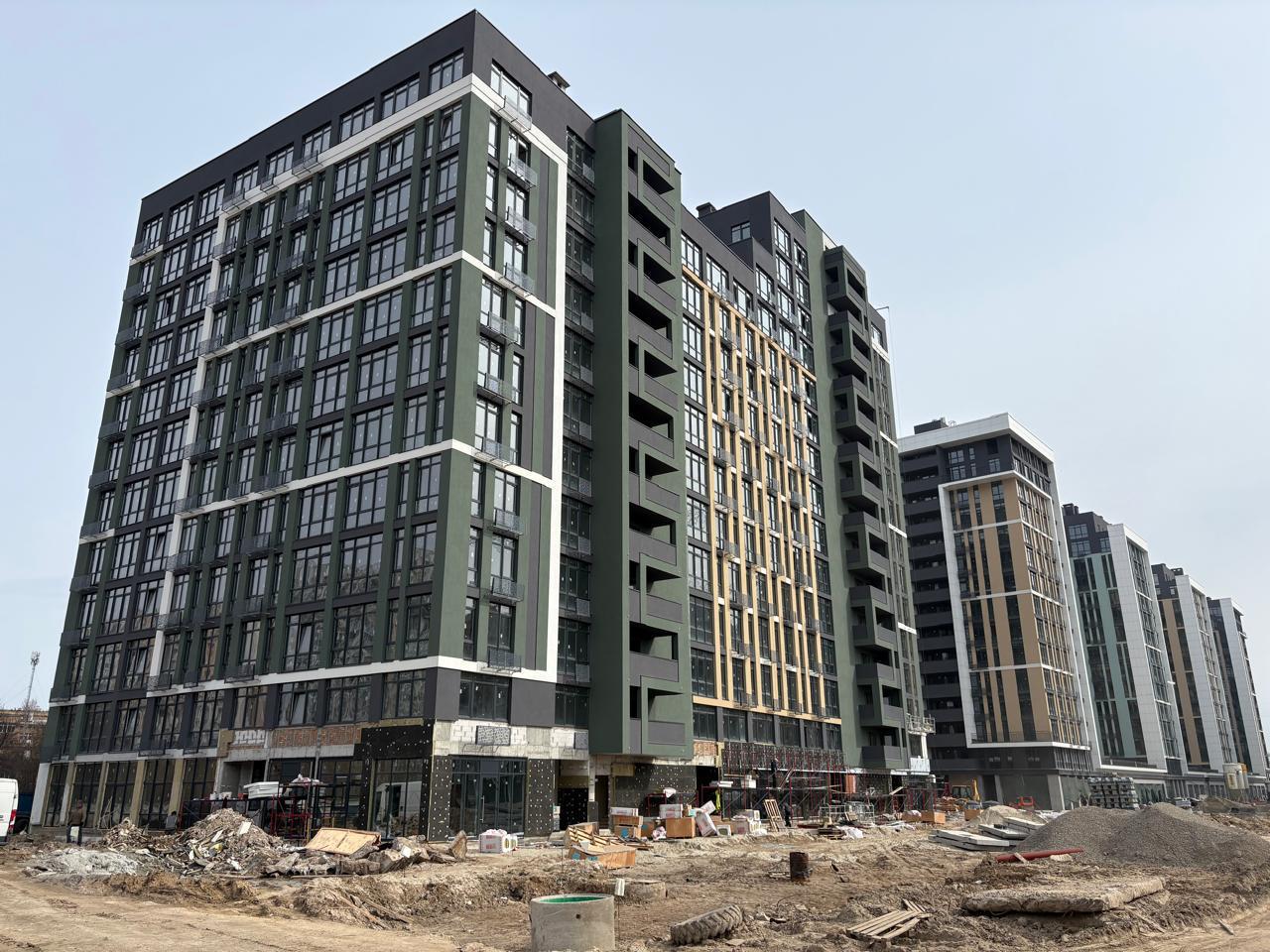

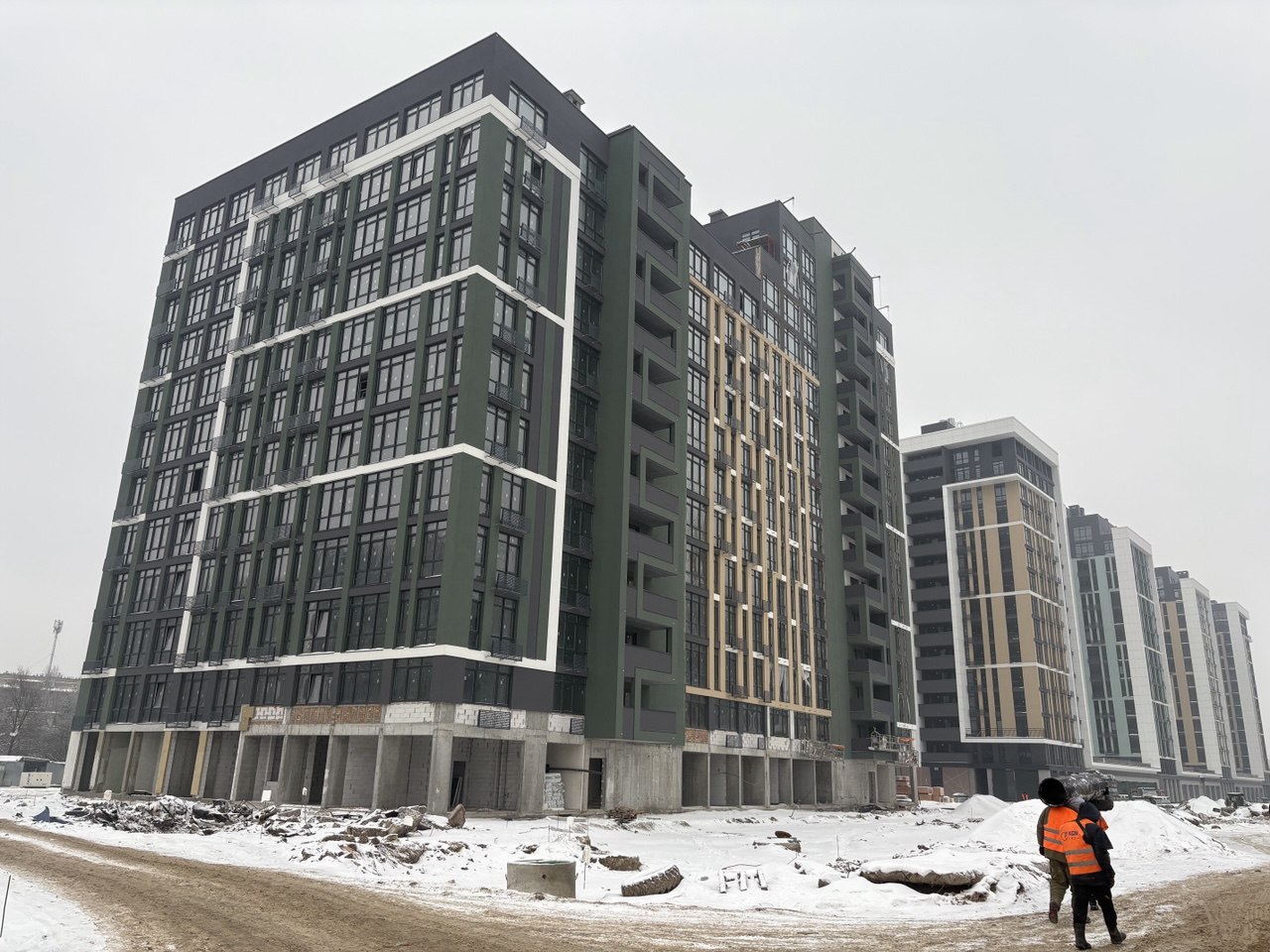

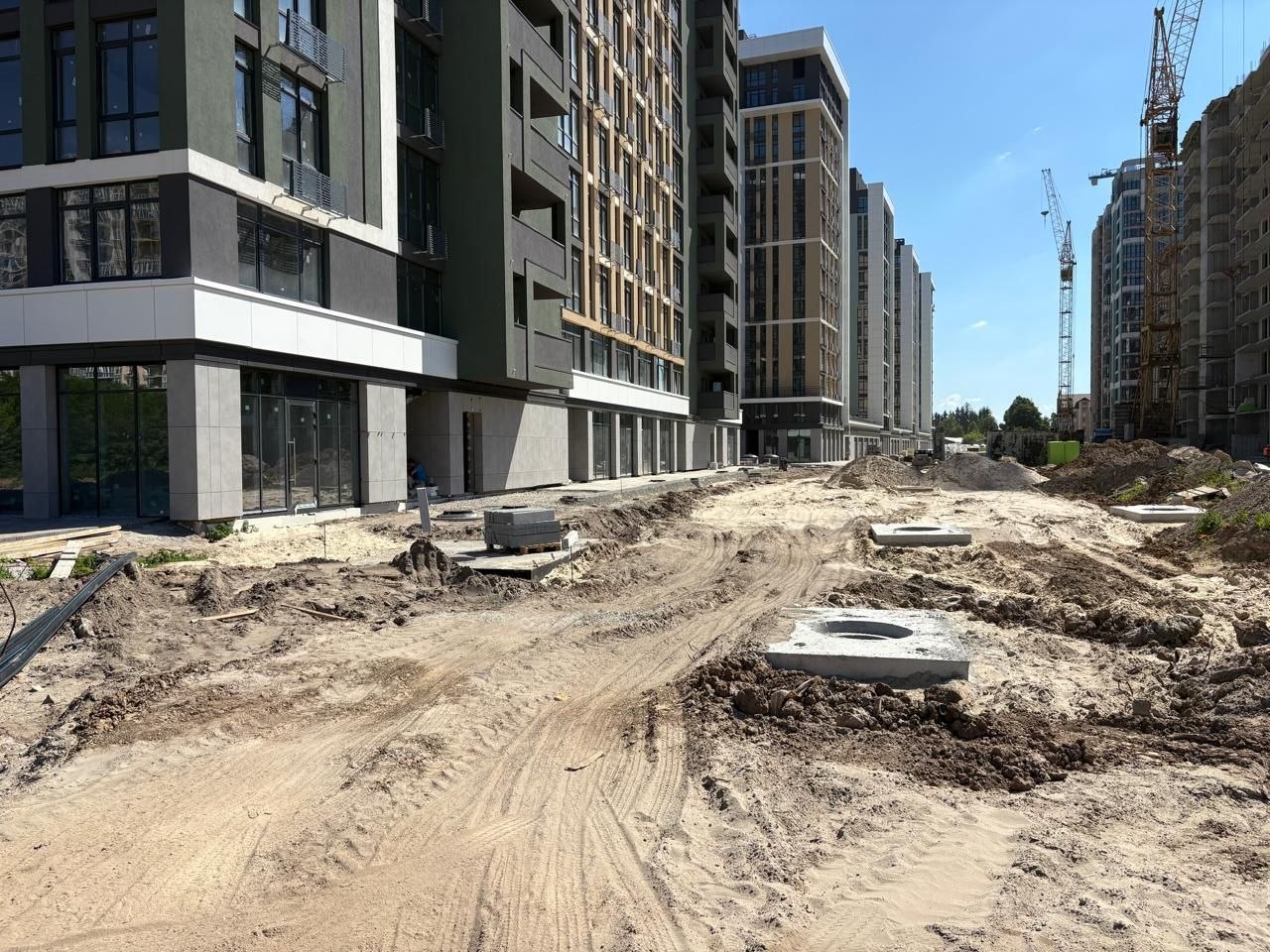

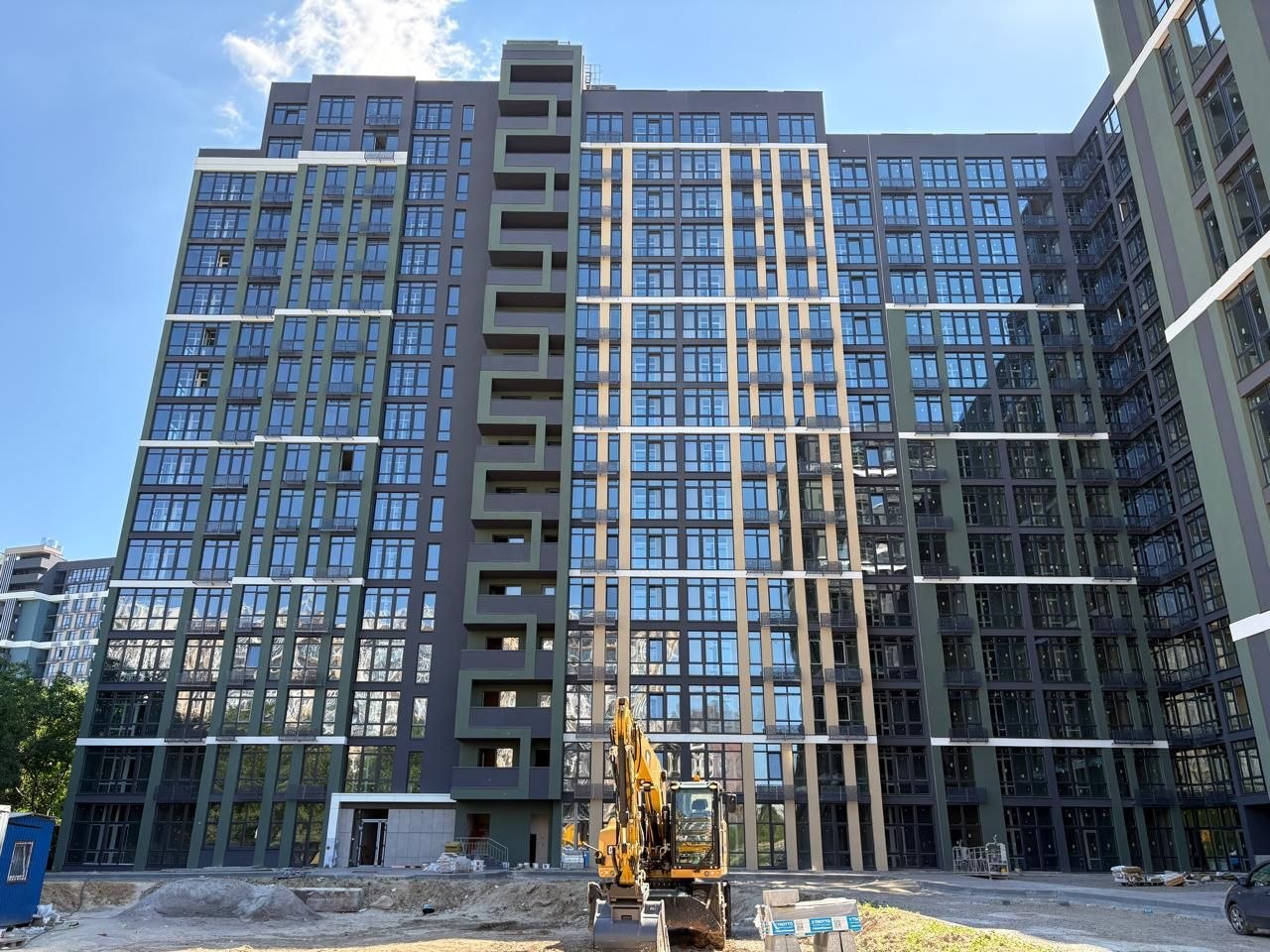

  • BUILDING 2

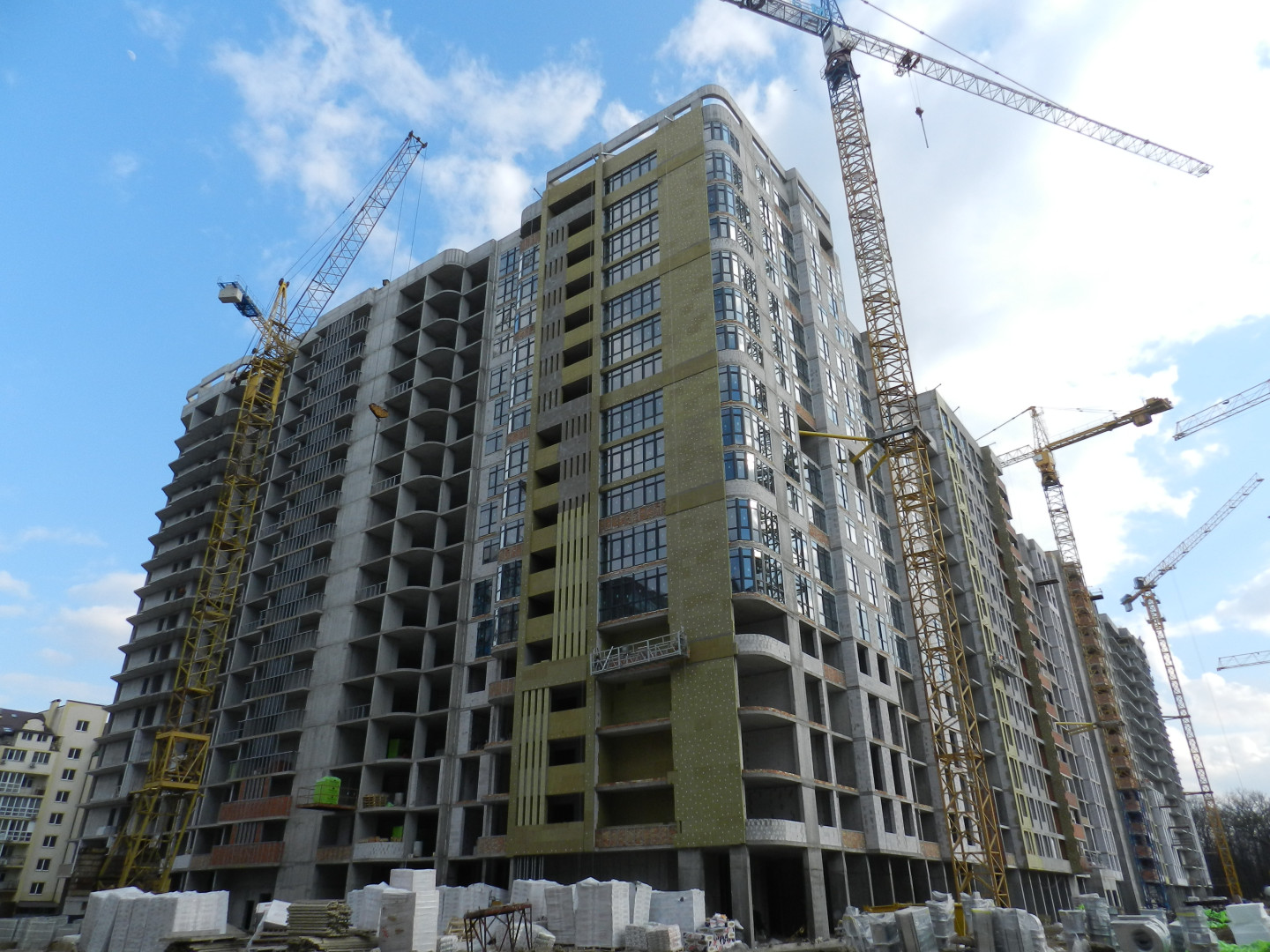

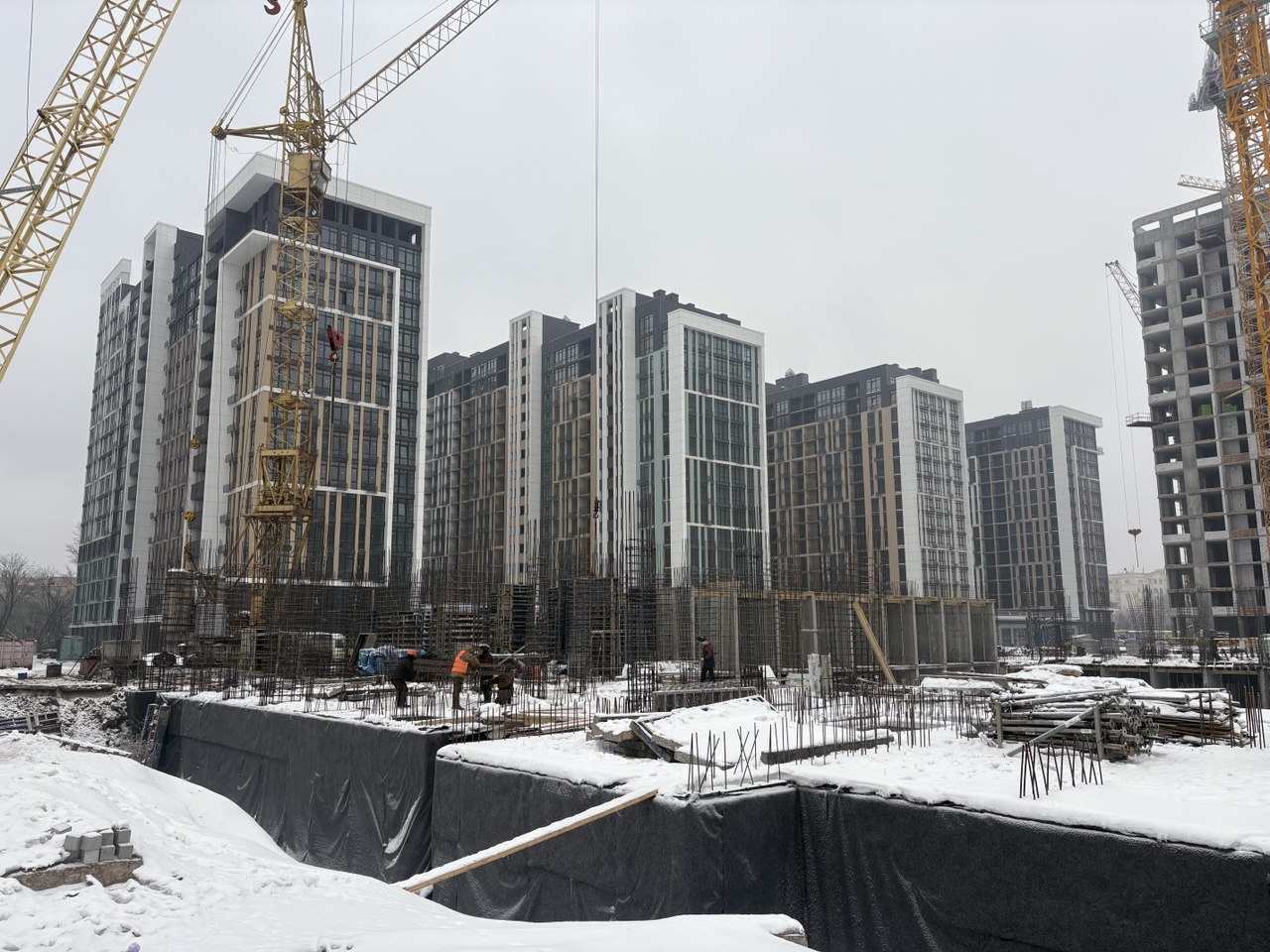

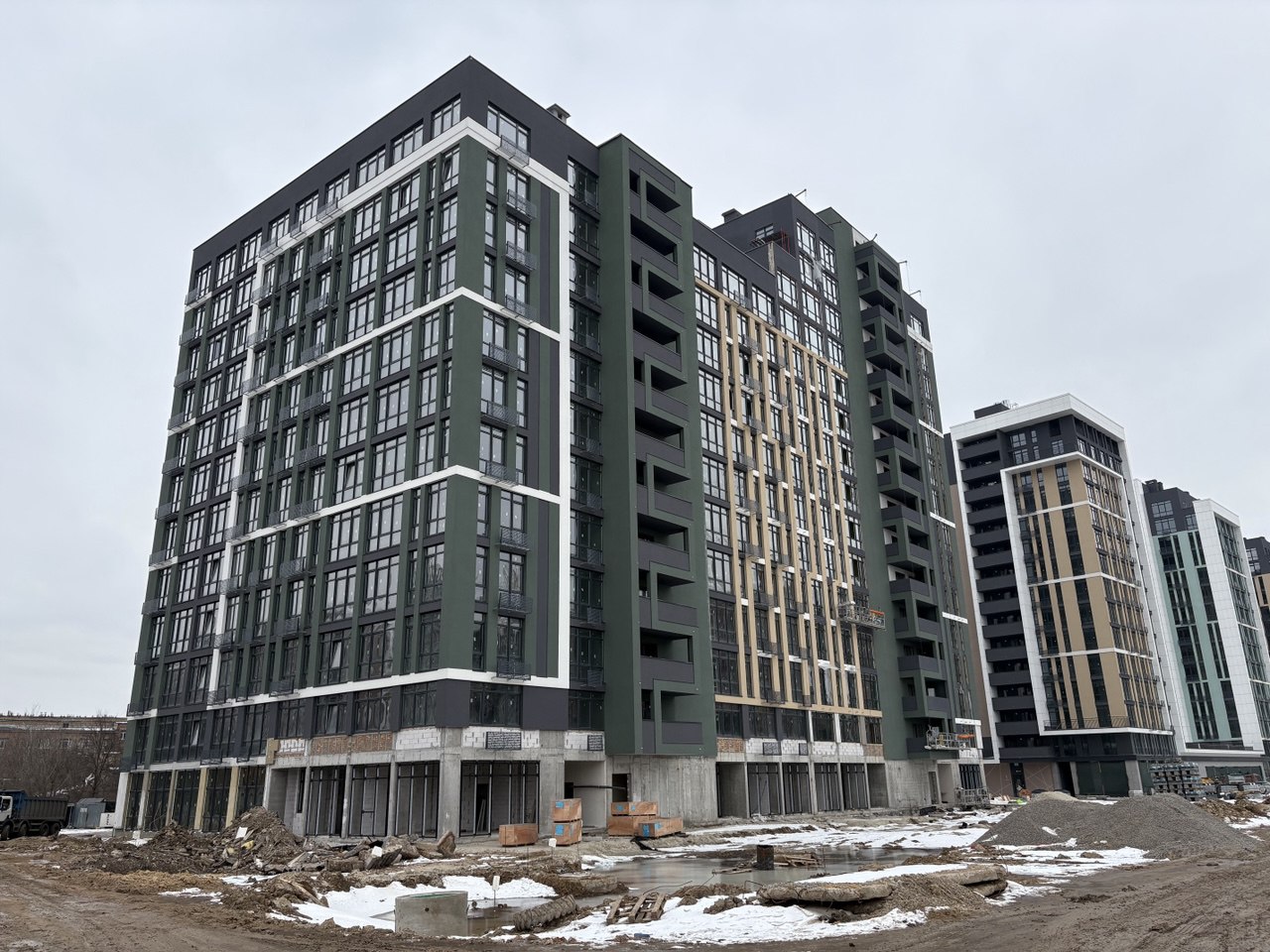

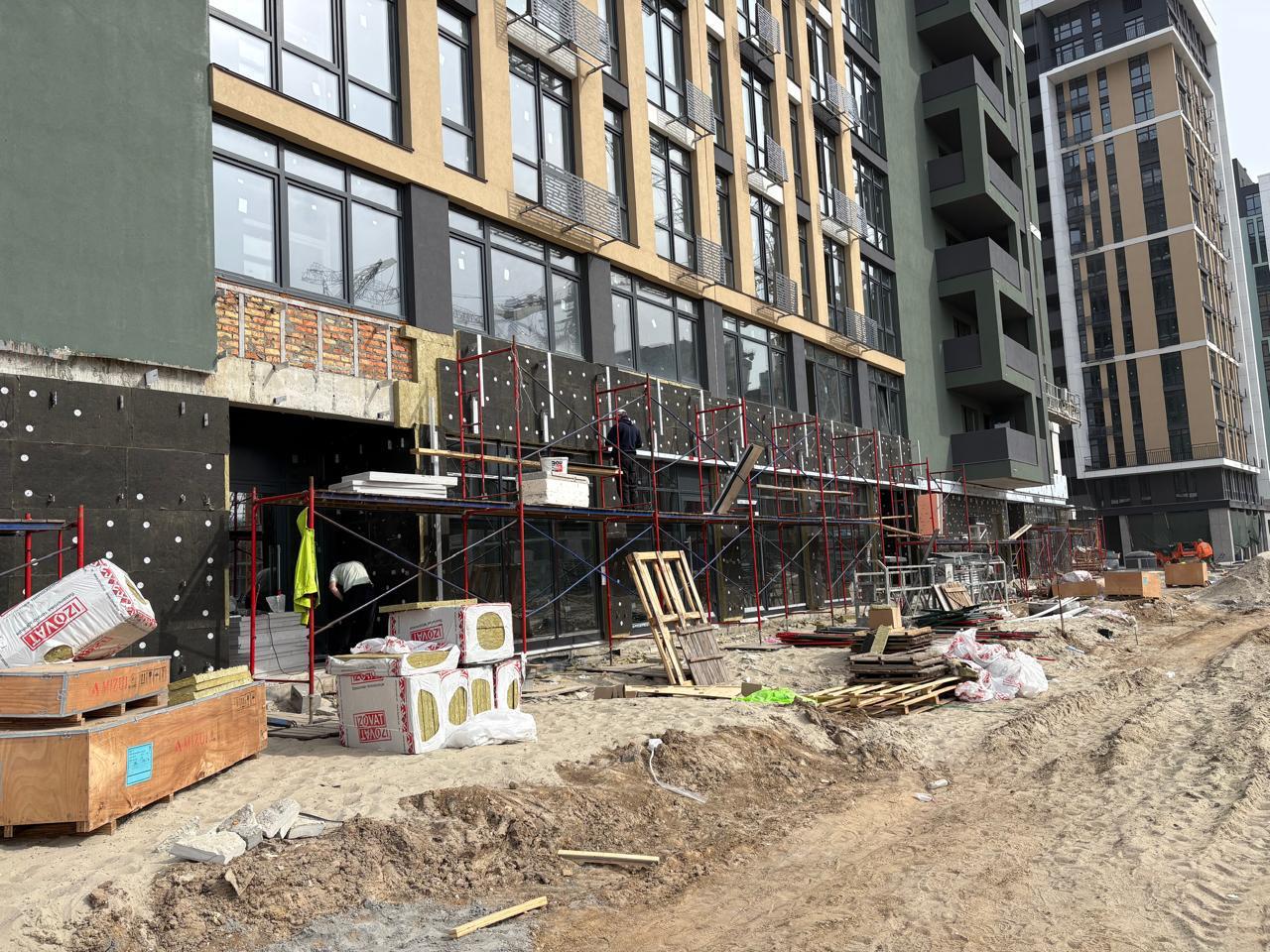

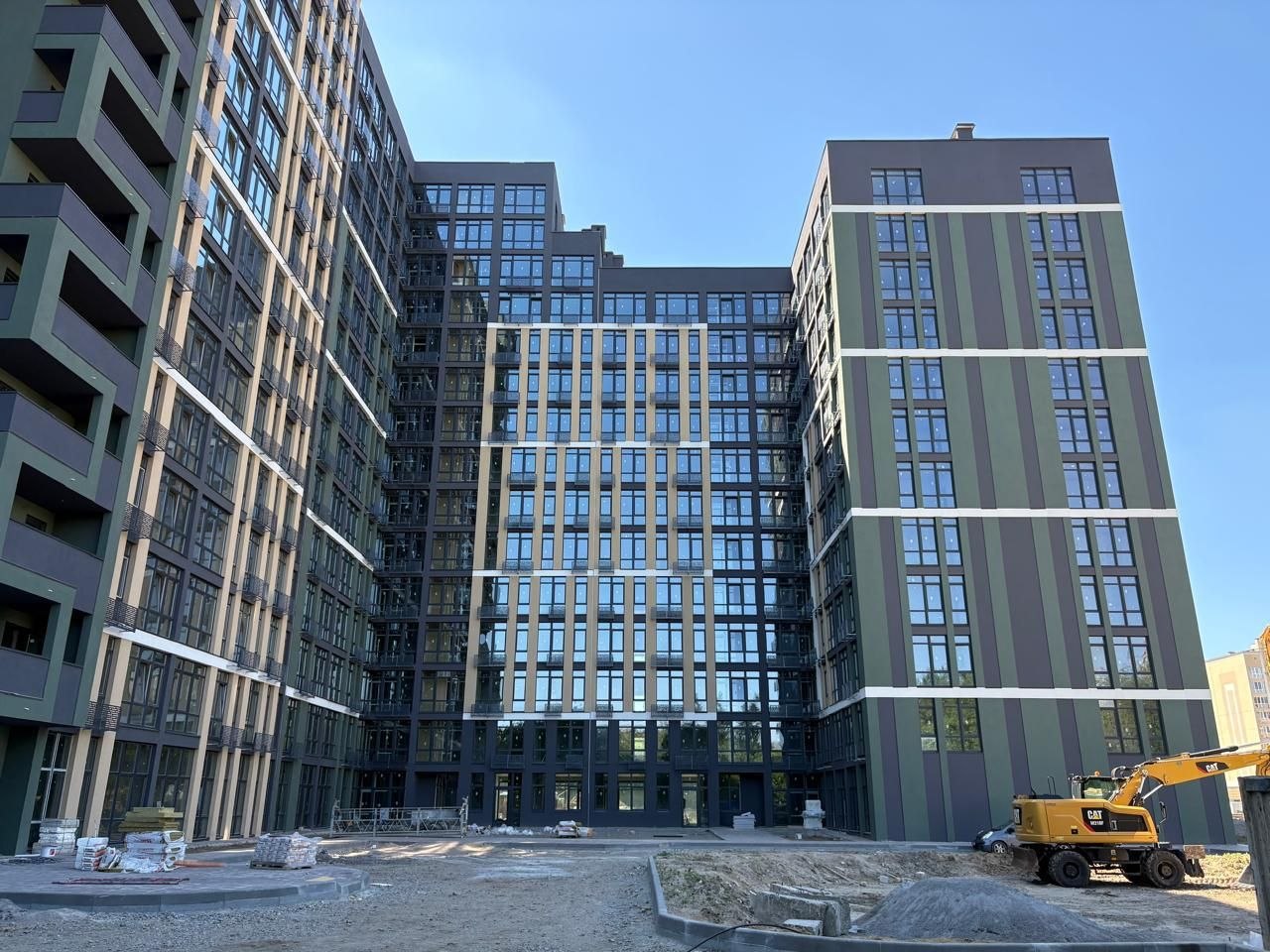

  • SECTION 1 - Fit-out works on the ground floor and installation of on-site utilities are underway.

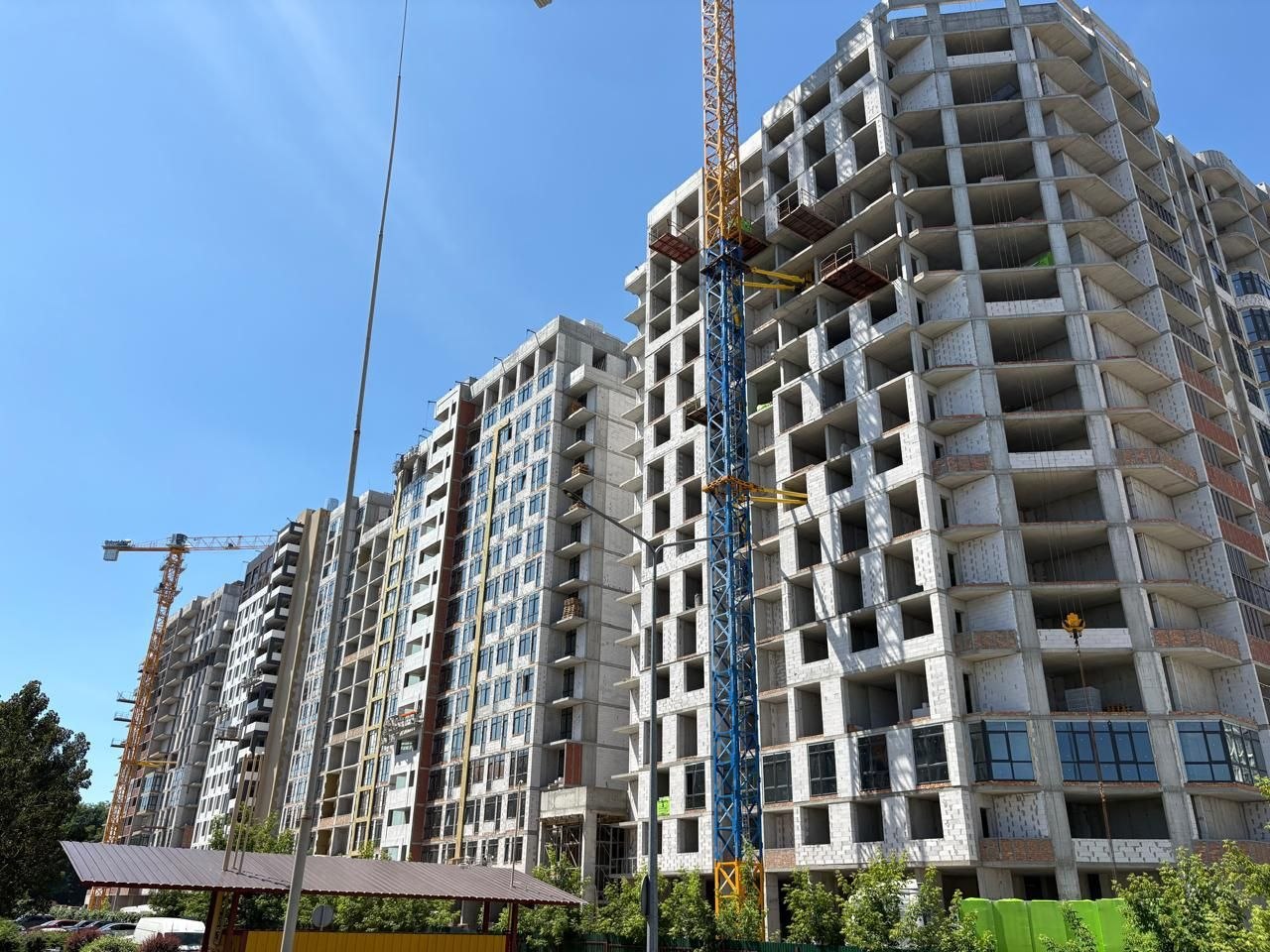

  • SECTION 2 - Glazing has been completed; façade painting and ground floor works are in progress.
  • SECTION 3 - Glazing of floors 2 and 5–16 completed; finishing façade painting and continuing ground floor works.

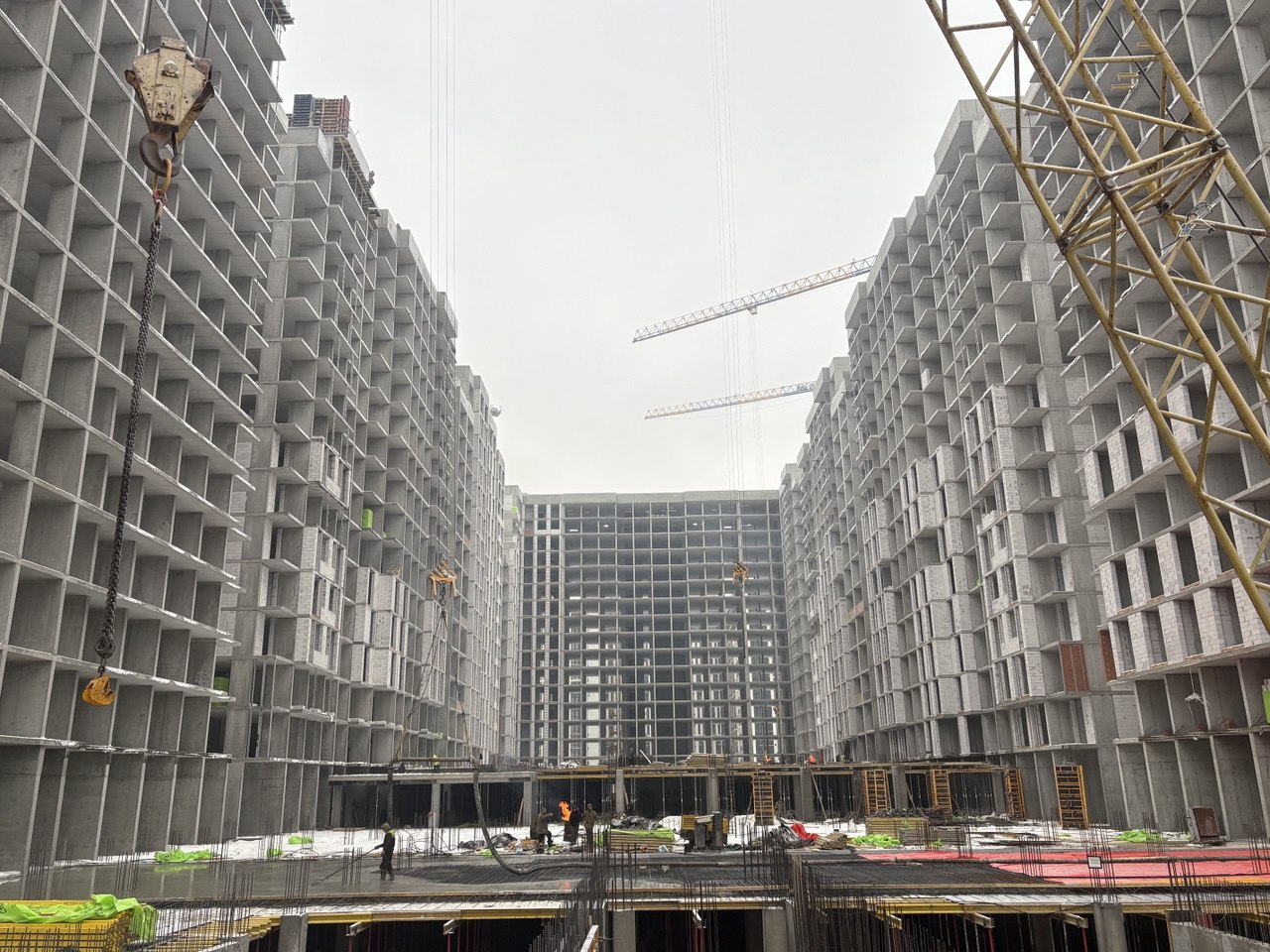

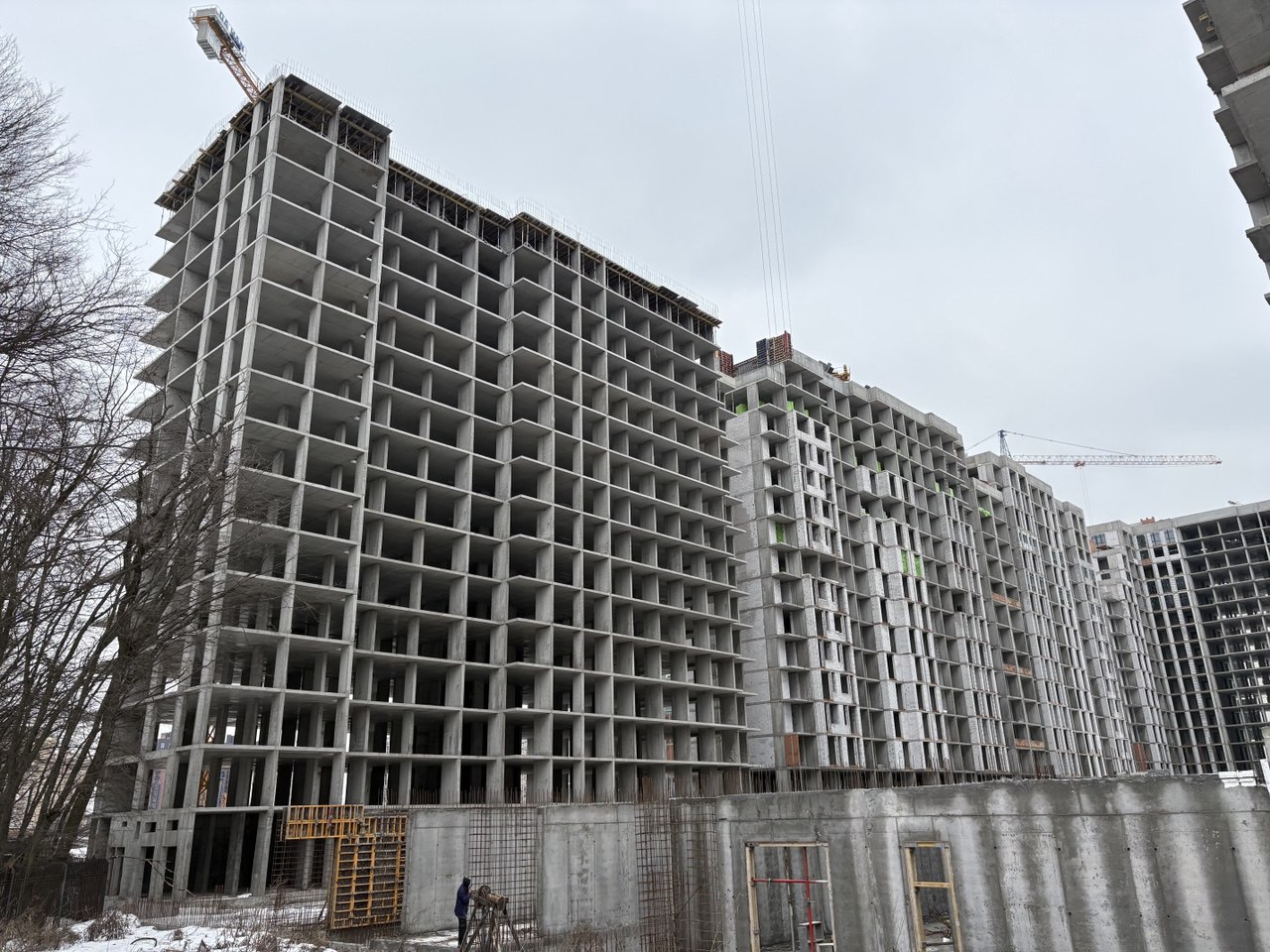

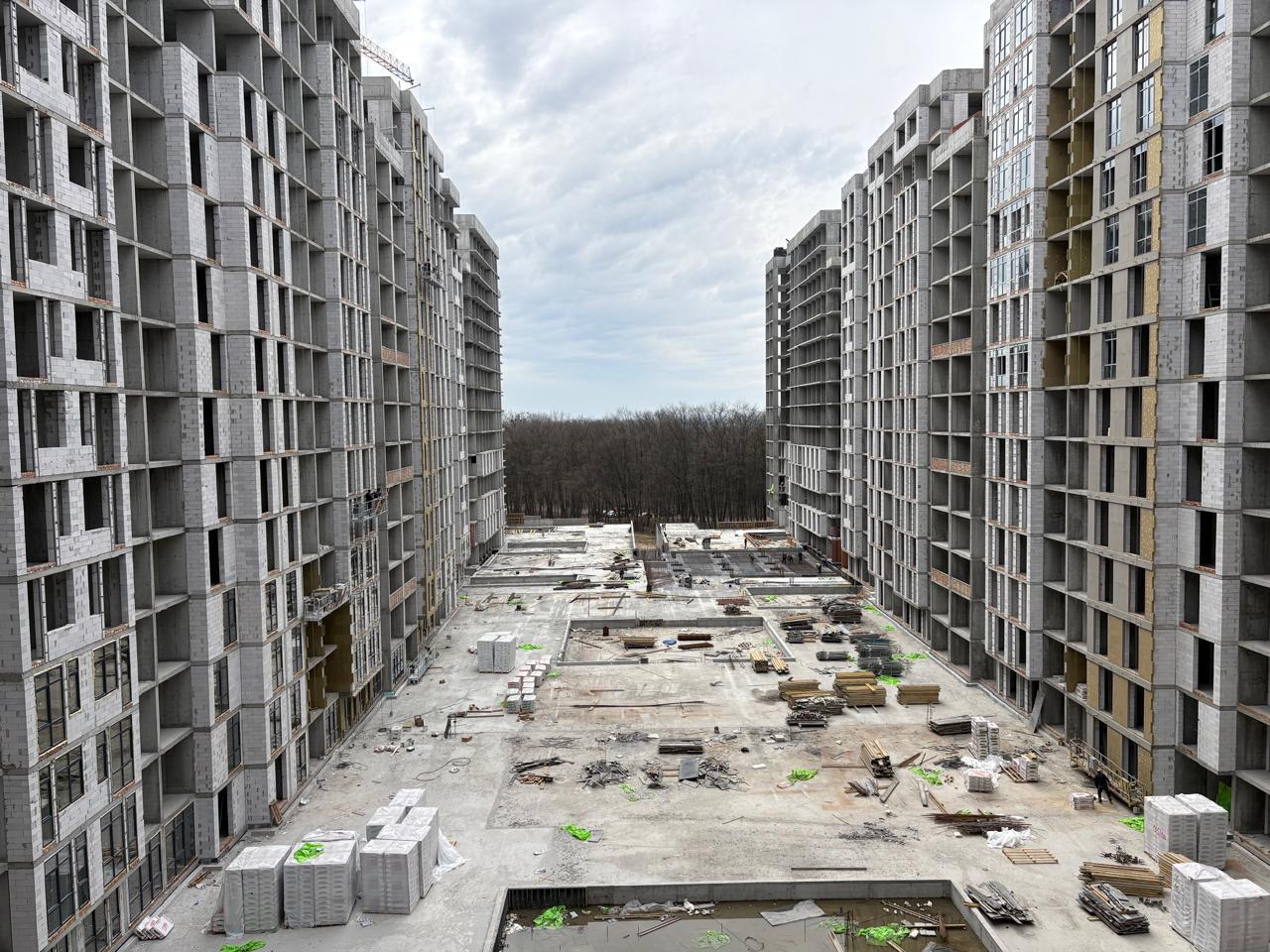

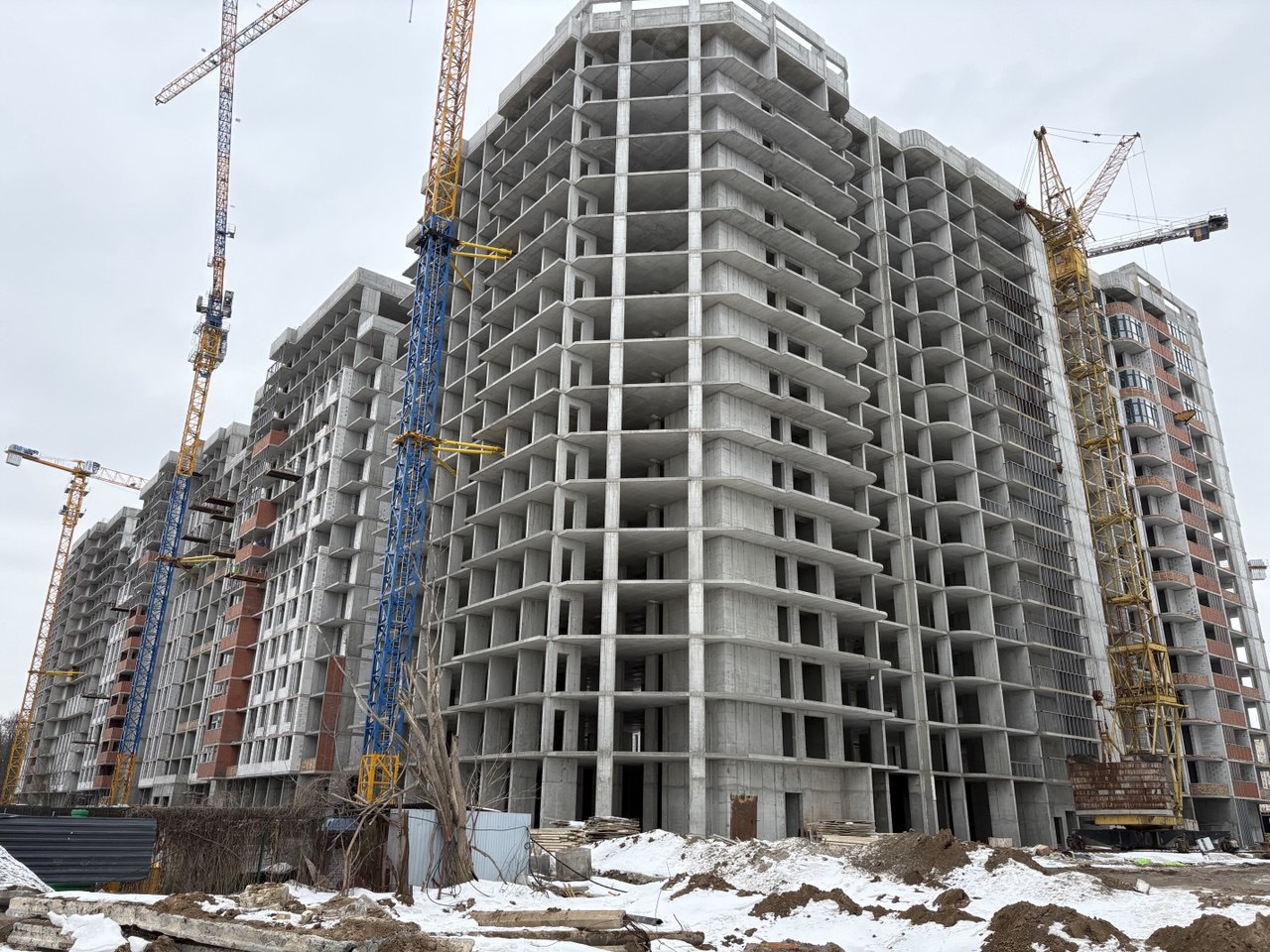

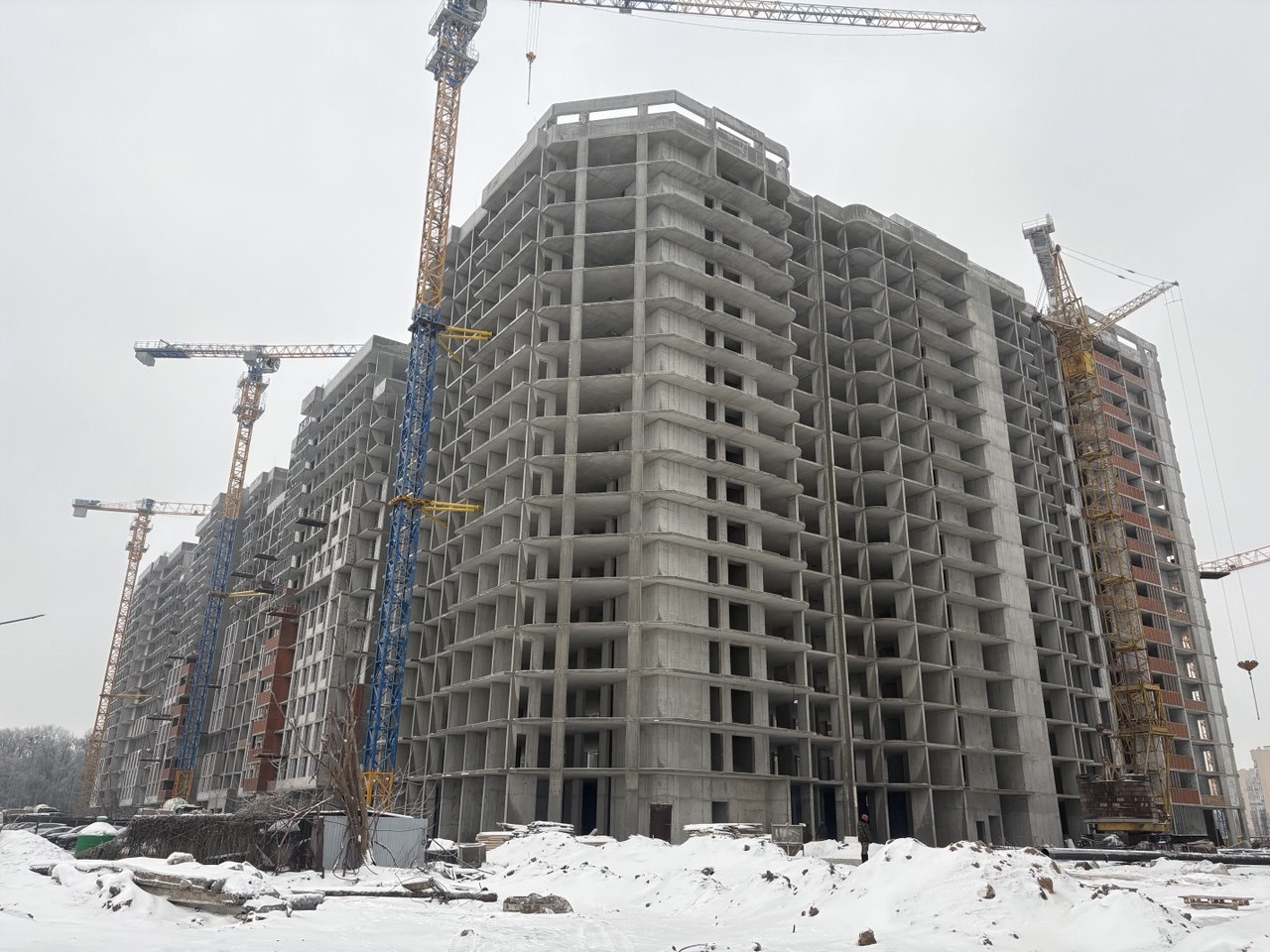

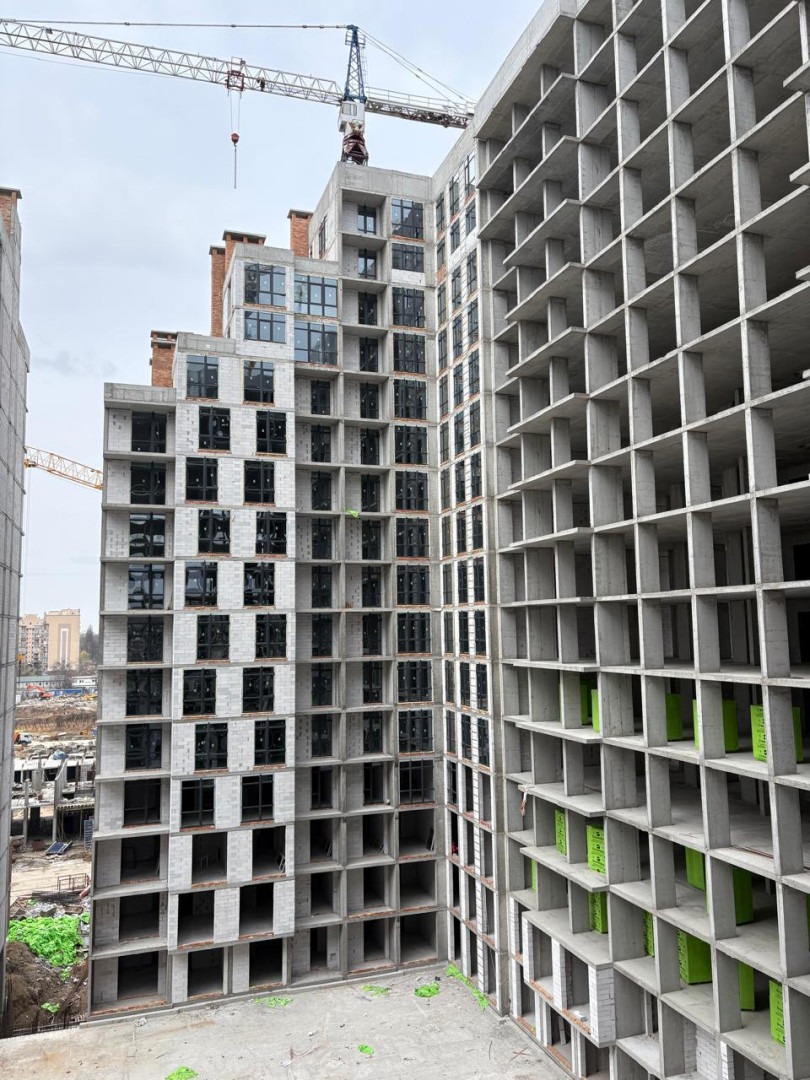

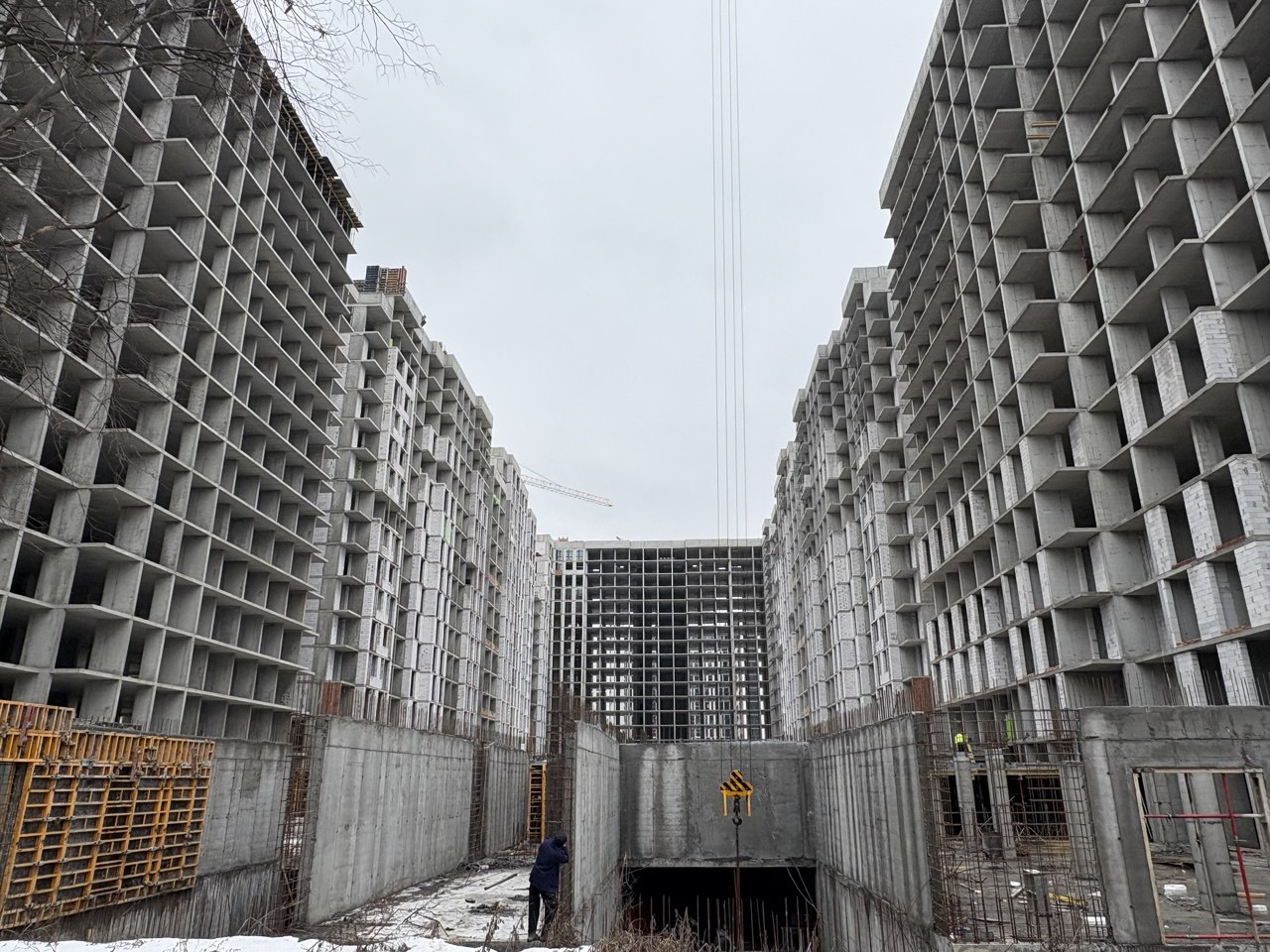

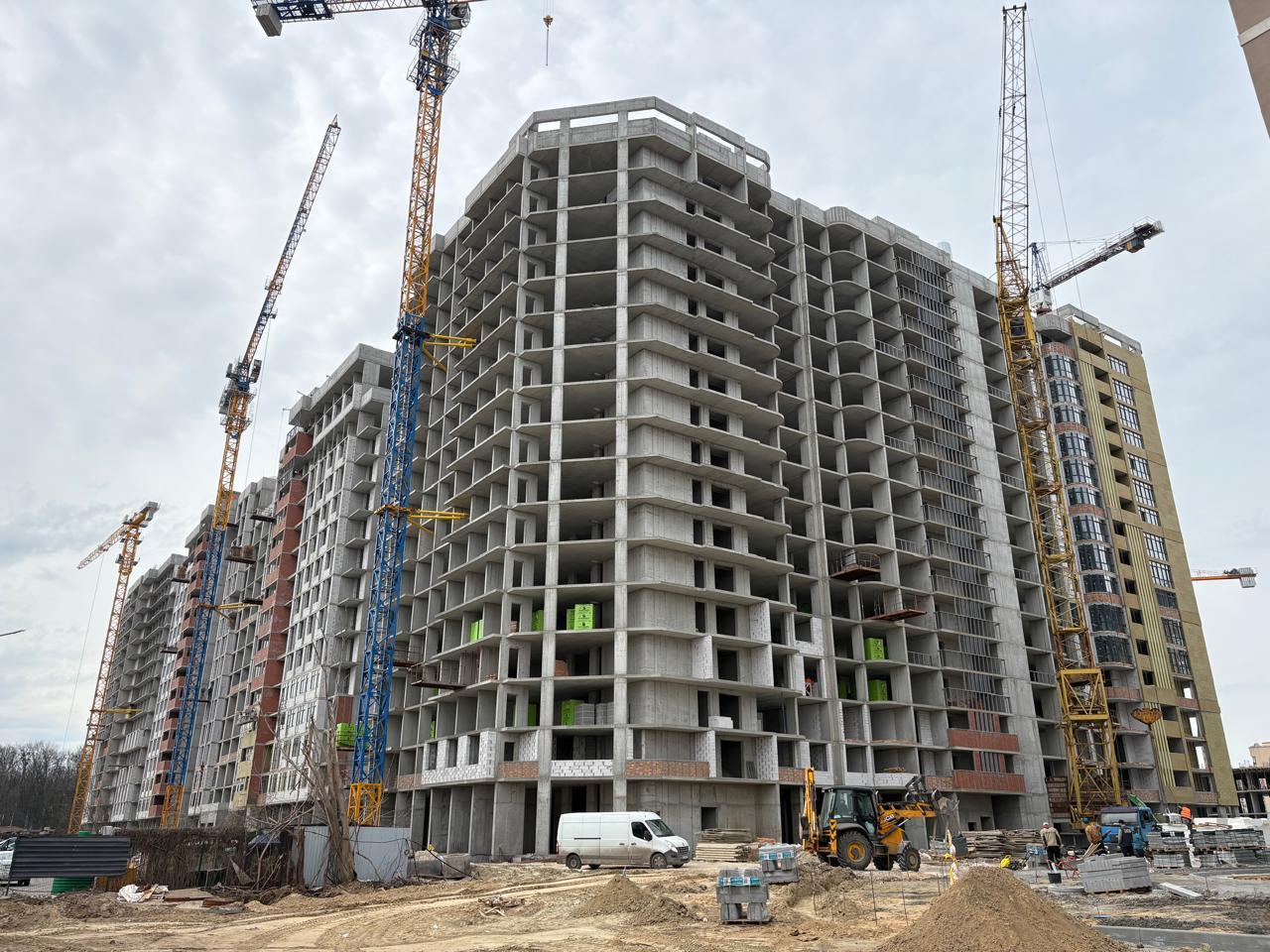

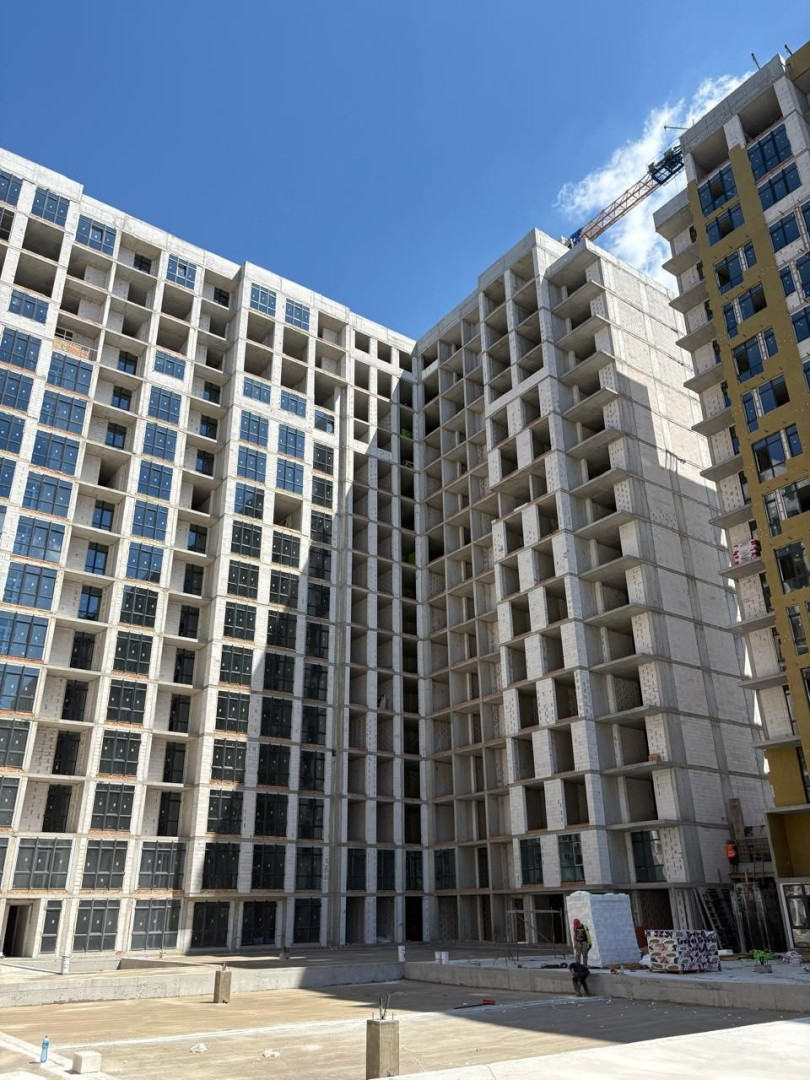

  • BUILDING 3

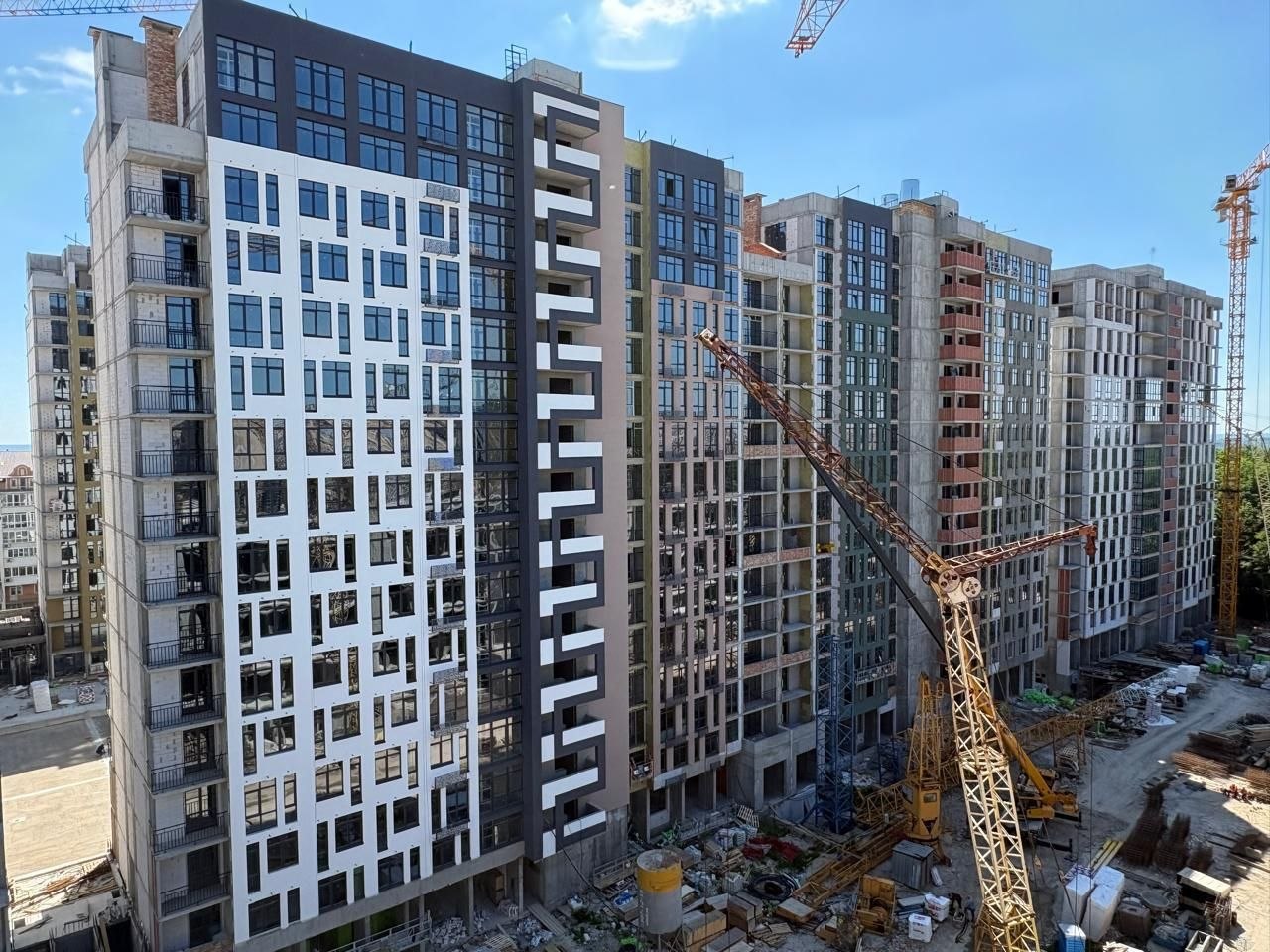

  • Completion of monolithic works on the stylobate between Sections 2–8; reinforcement and concreting of the basement floor slab of the stylobate between Sections 1 and 9.

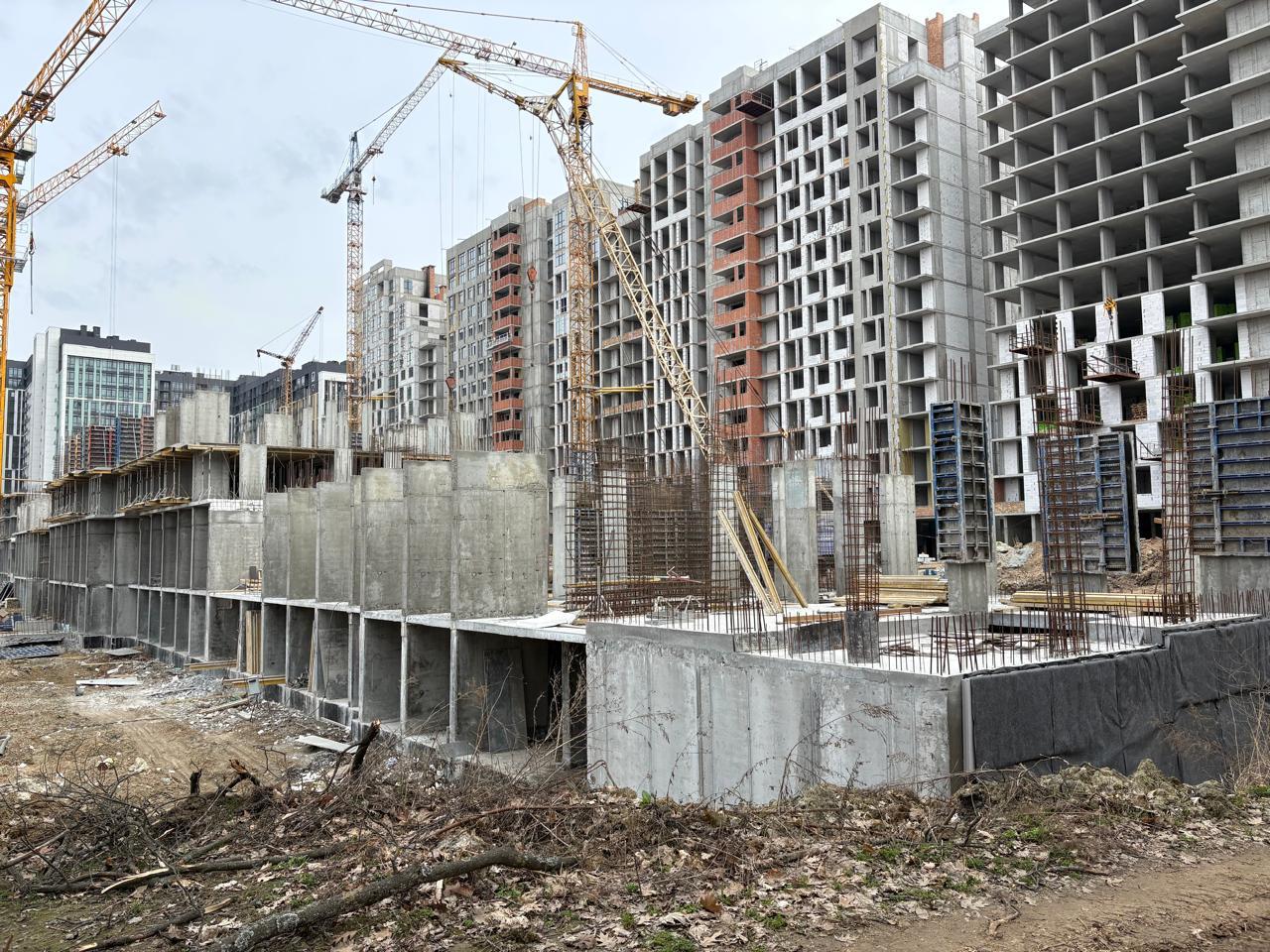

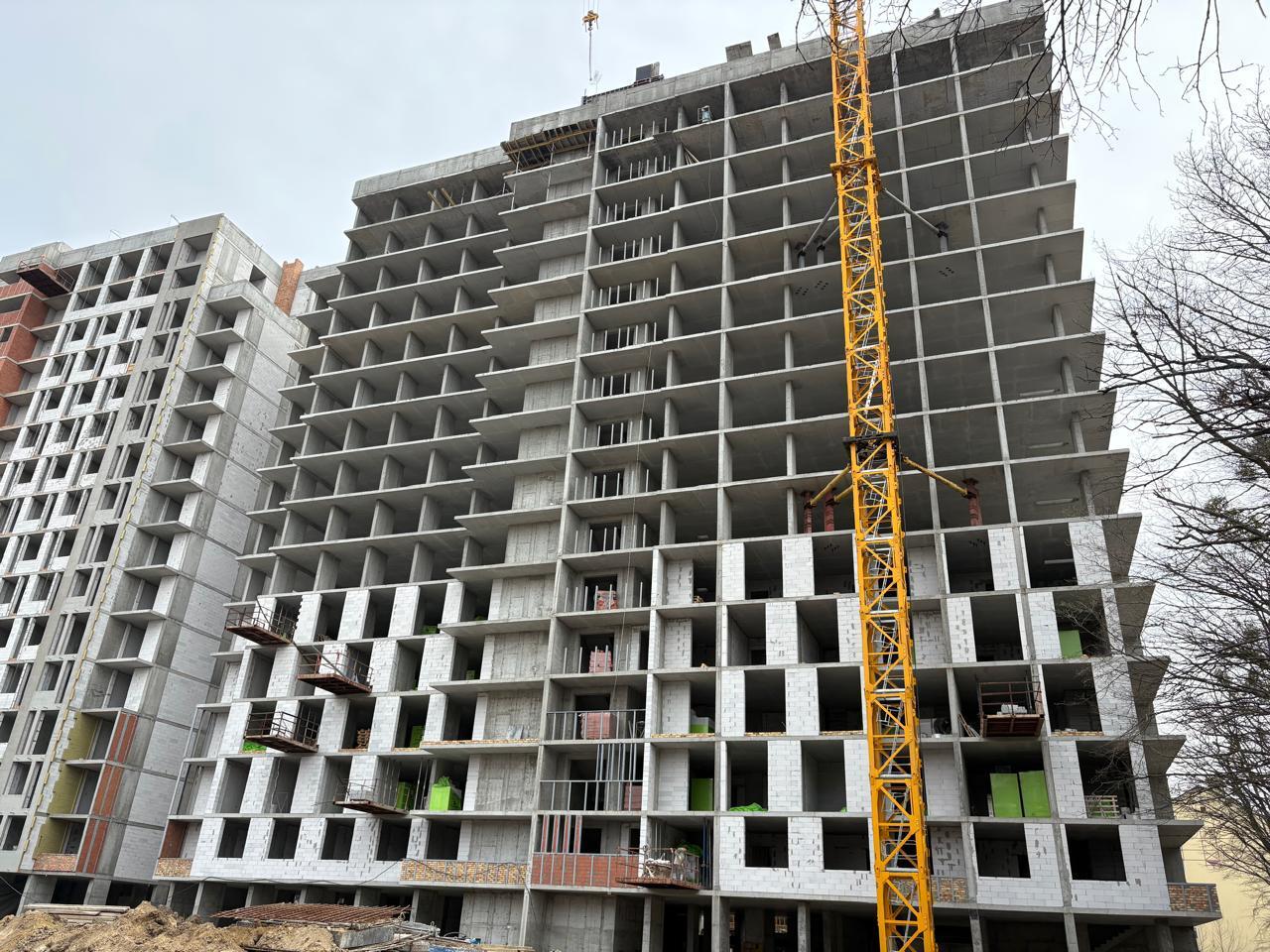

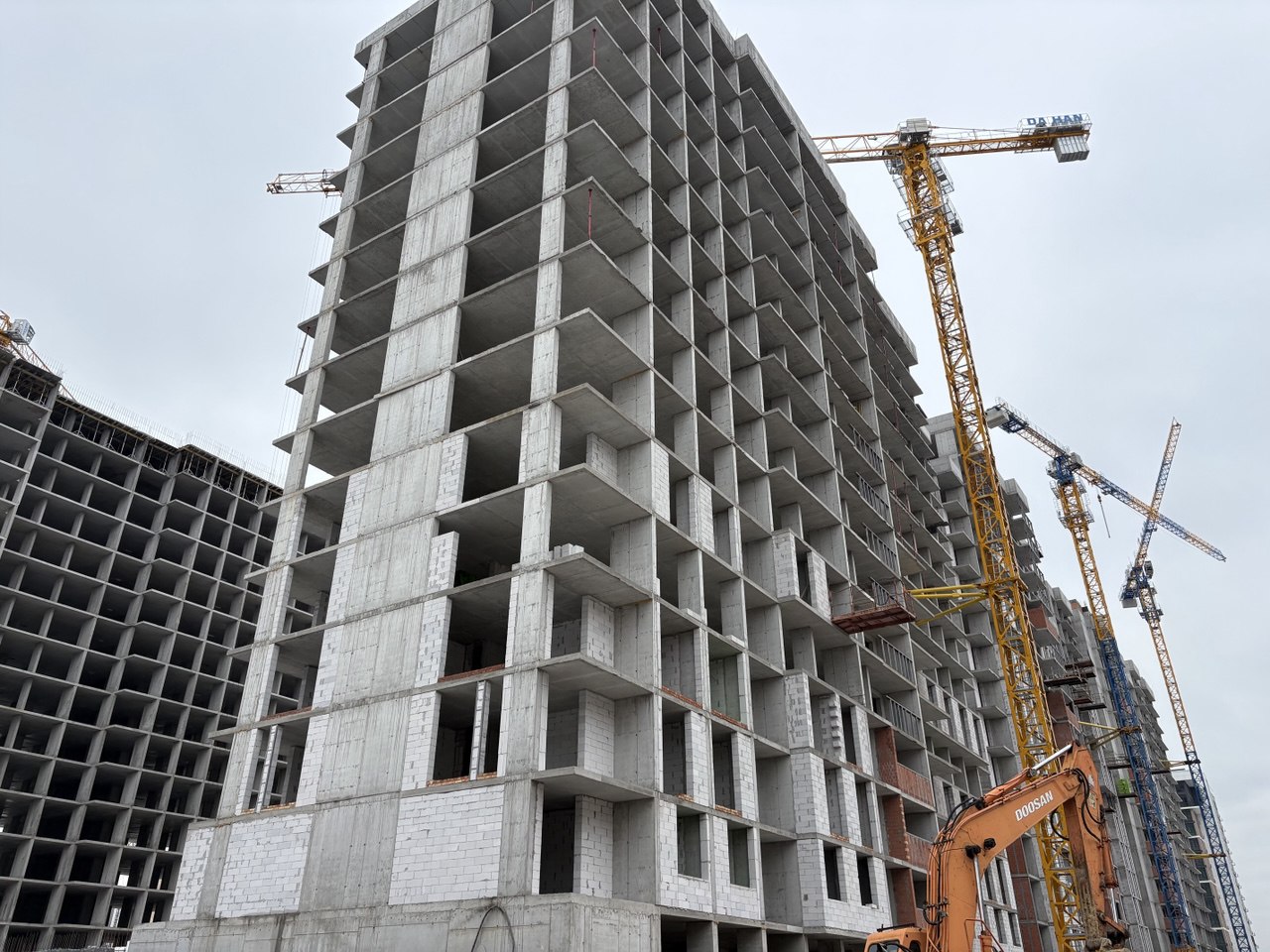

  • SECTION 1 - Reinforcement and concreting of the top floor slab and parapet.
  • SECTION 2 - Monolithic works completed; masonry works underway on floors 4–8.
  • SECTION 3 - Masonry works completed.
  • SECTION 4 - Monolithic and masonry works completed.
  • SECTION 5-6Monolithic works completed; masonry works starting.
  • SECTION 7-8 - Masonry works on floors 2–10.
  • SECTION 9 - Monolithic works completed; masonry works underway on floors 2–5.

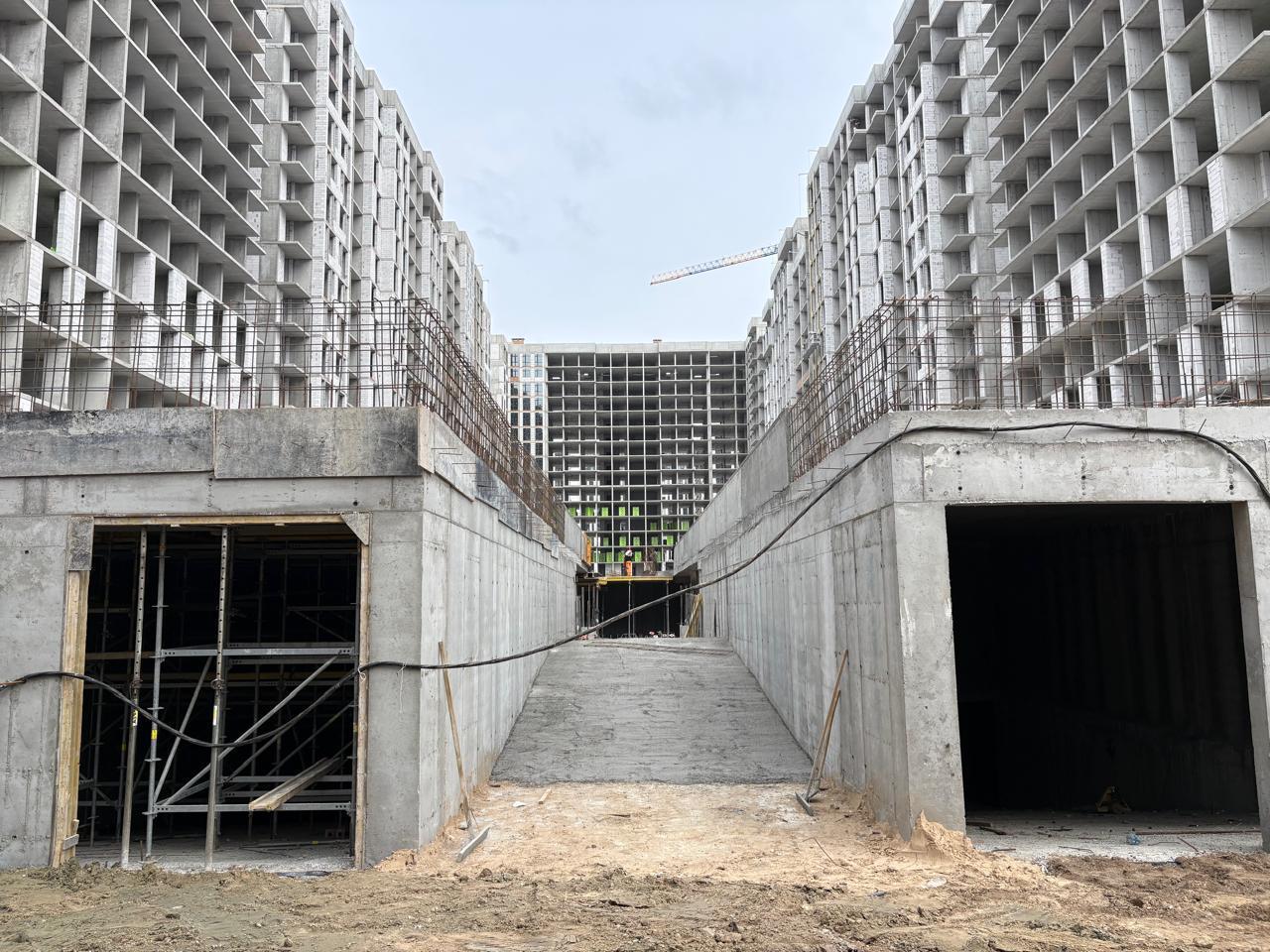

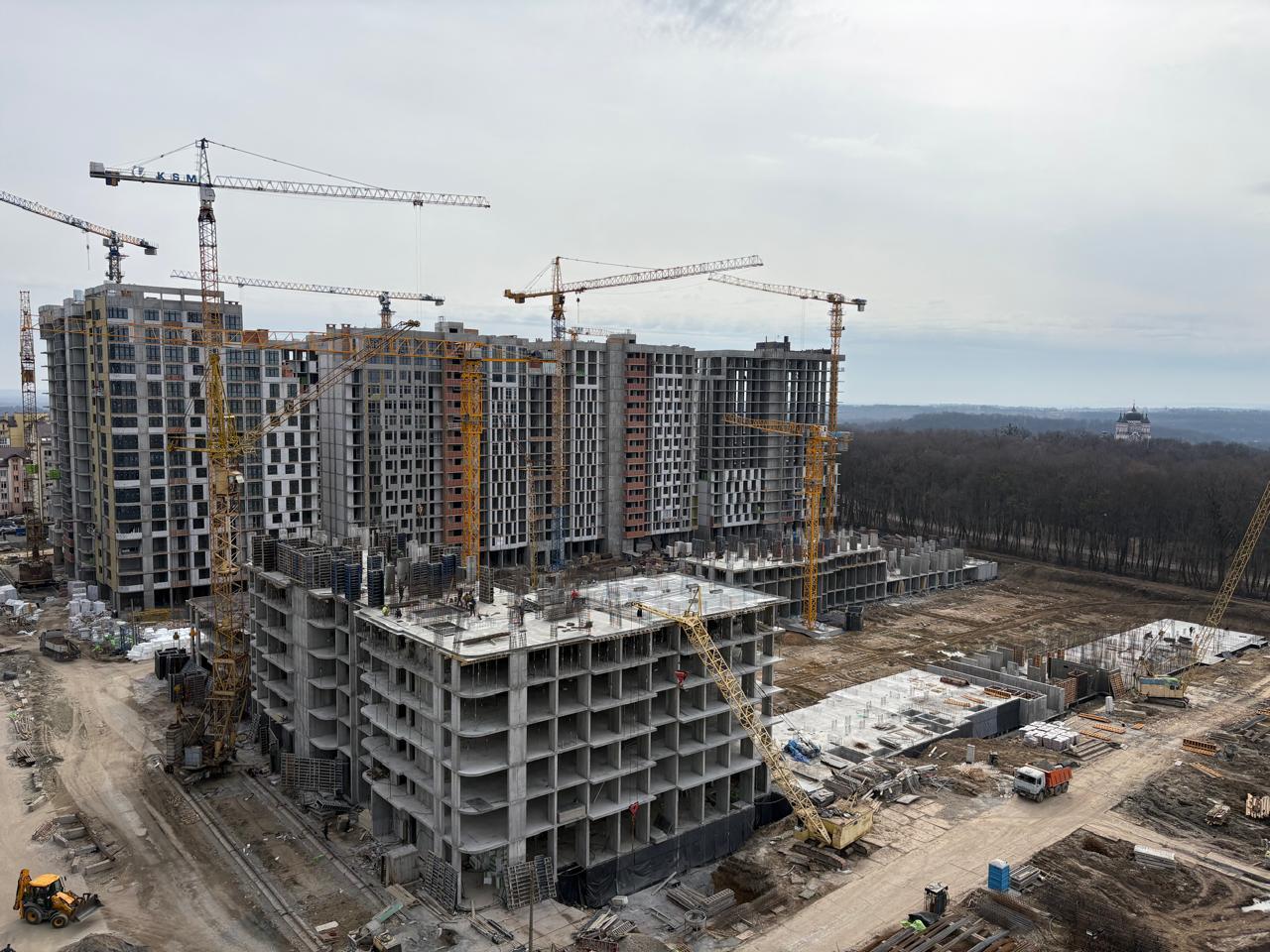

  • BUILDING 4

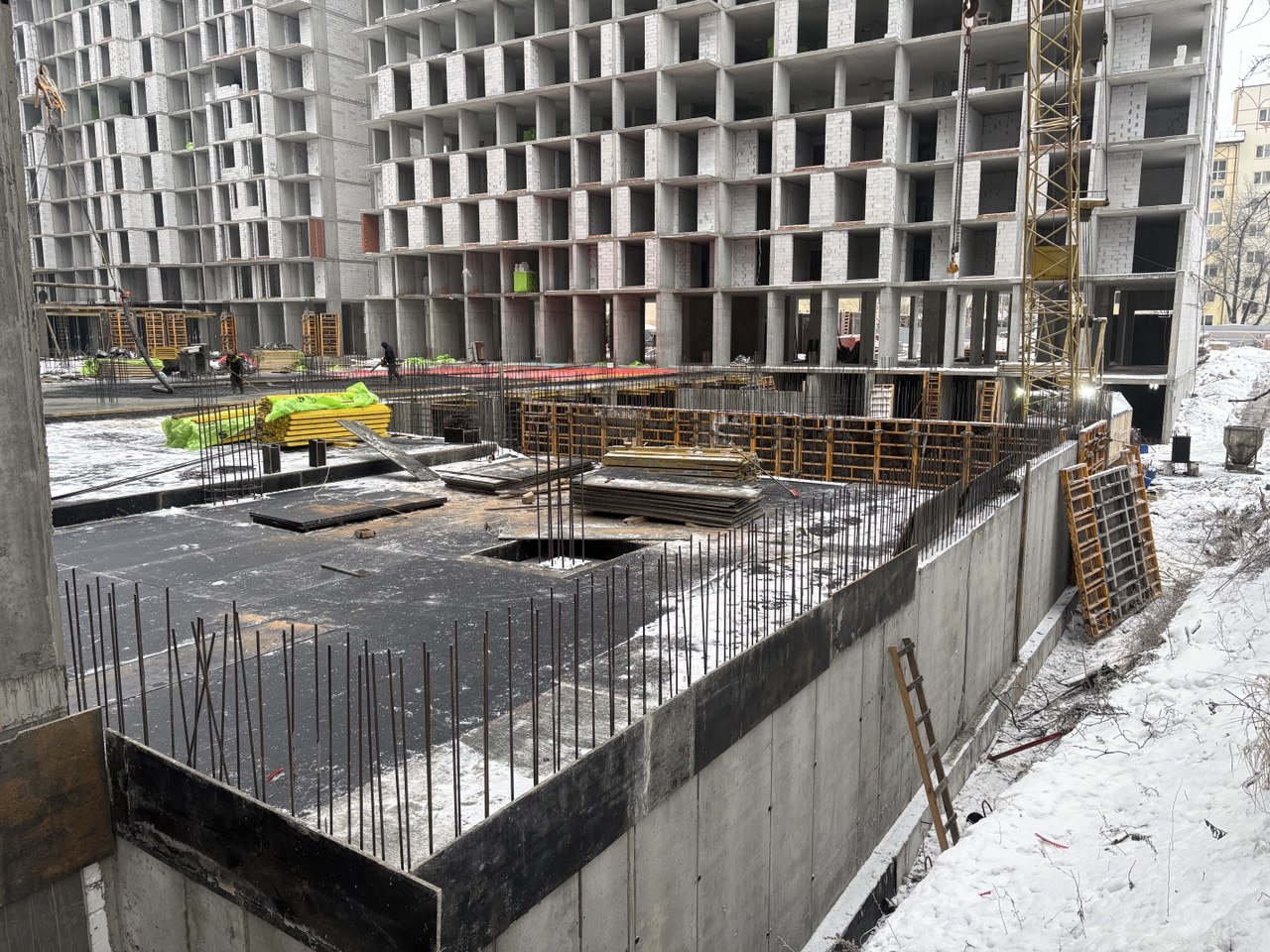

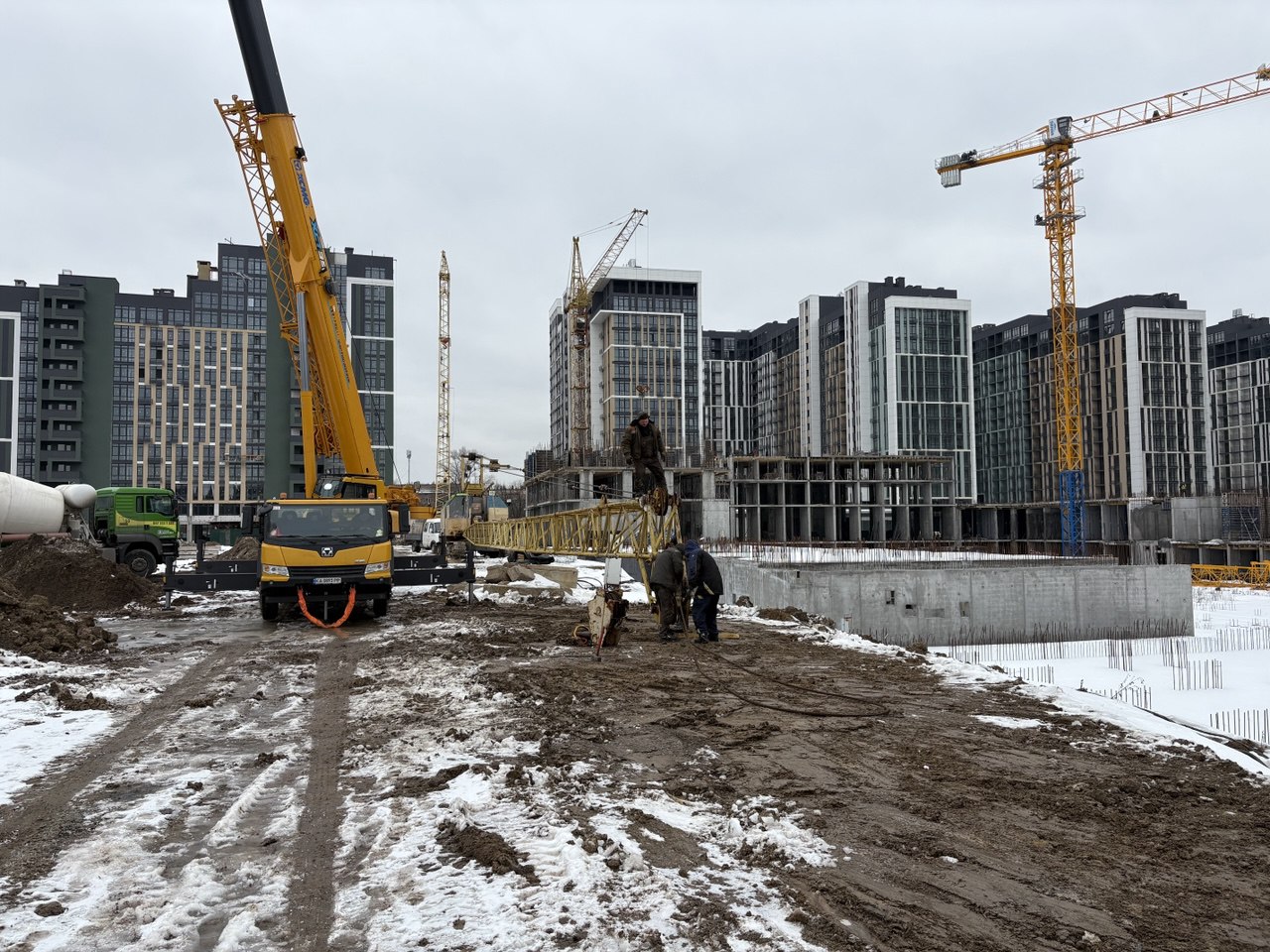

  • SECTION 1-2 - Reinforcement of basement vertical structures.
  • SECTION 3 - Concreting of the basement floor slab completed.
  • SECTION 4 - Reinforcement of first-floor vertical structures.
  • SECTION 5Reinforcement of the first-floor slab.
  • SECTION 6 - Reinforcement of first-floor vertical structures.
  • SECTION 7 - Concreting of the basement floor slab completed.
  • SECTION 8-9 - Concreting of basement vertical structures.

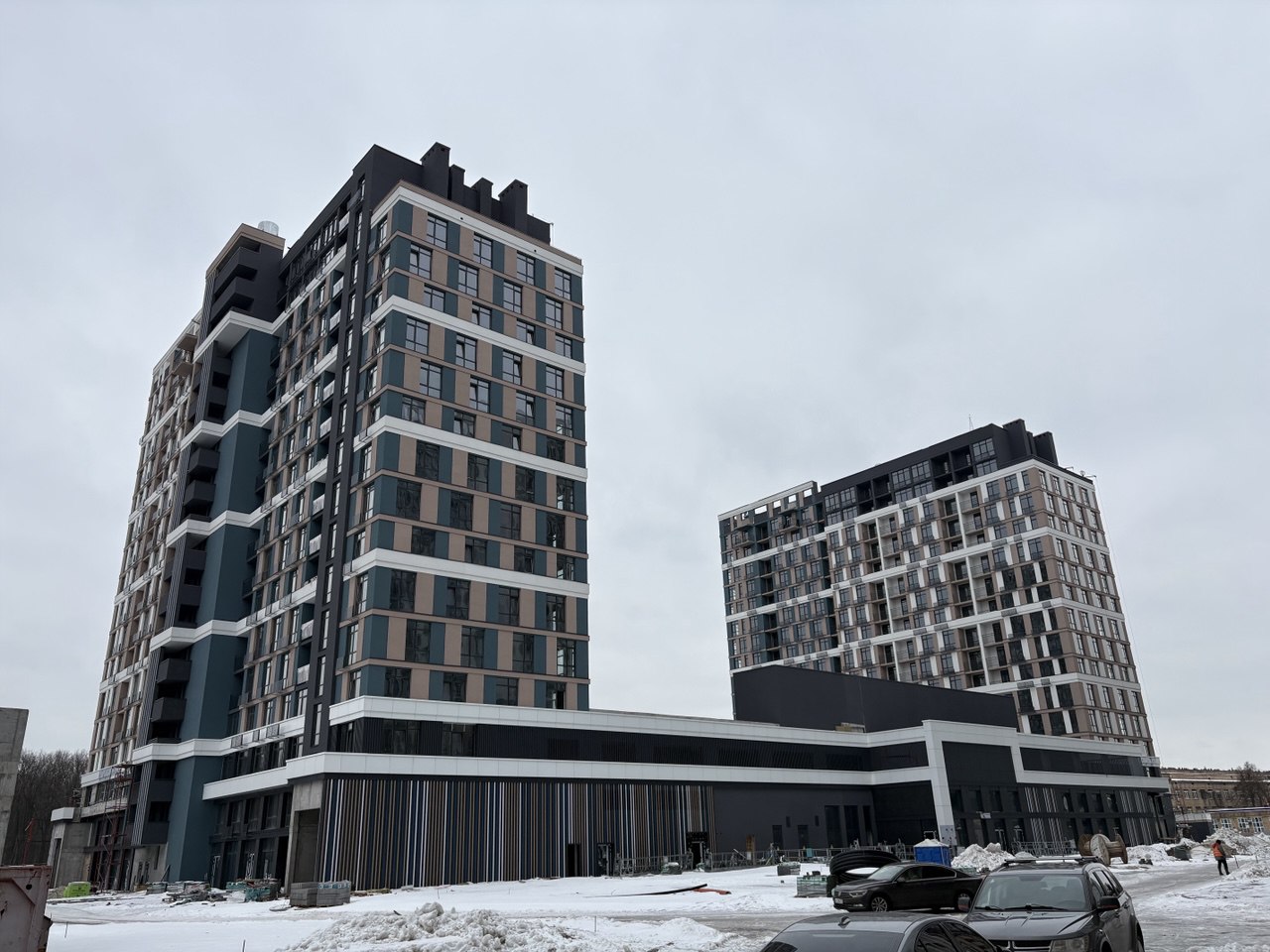

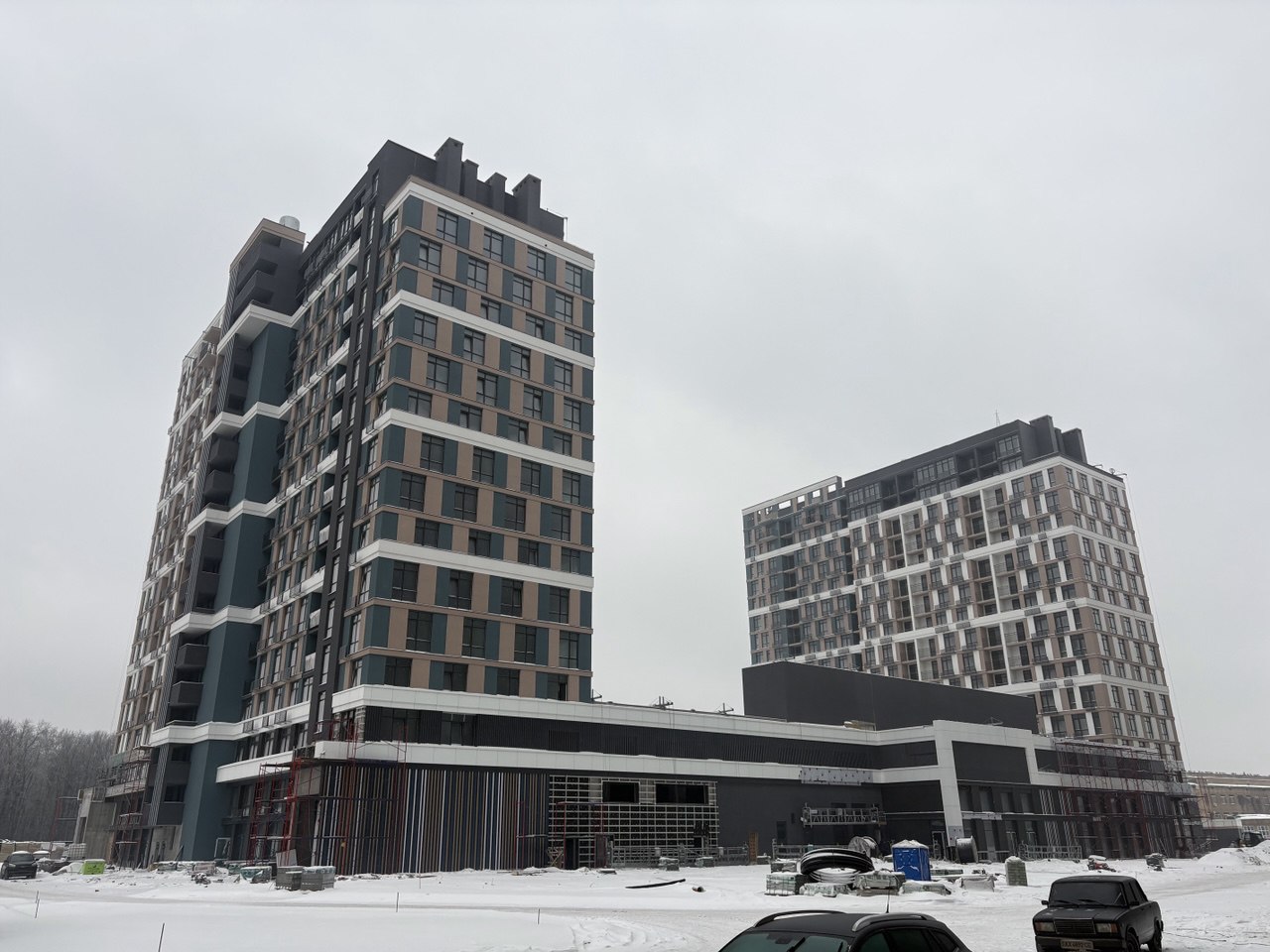

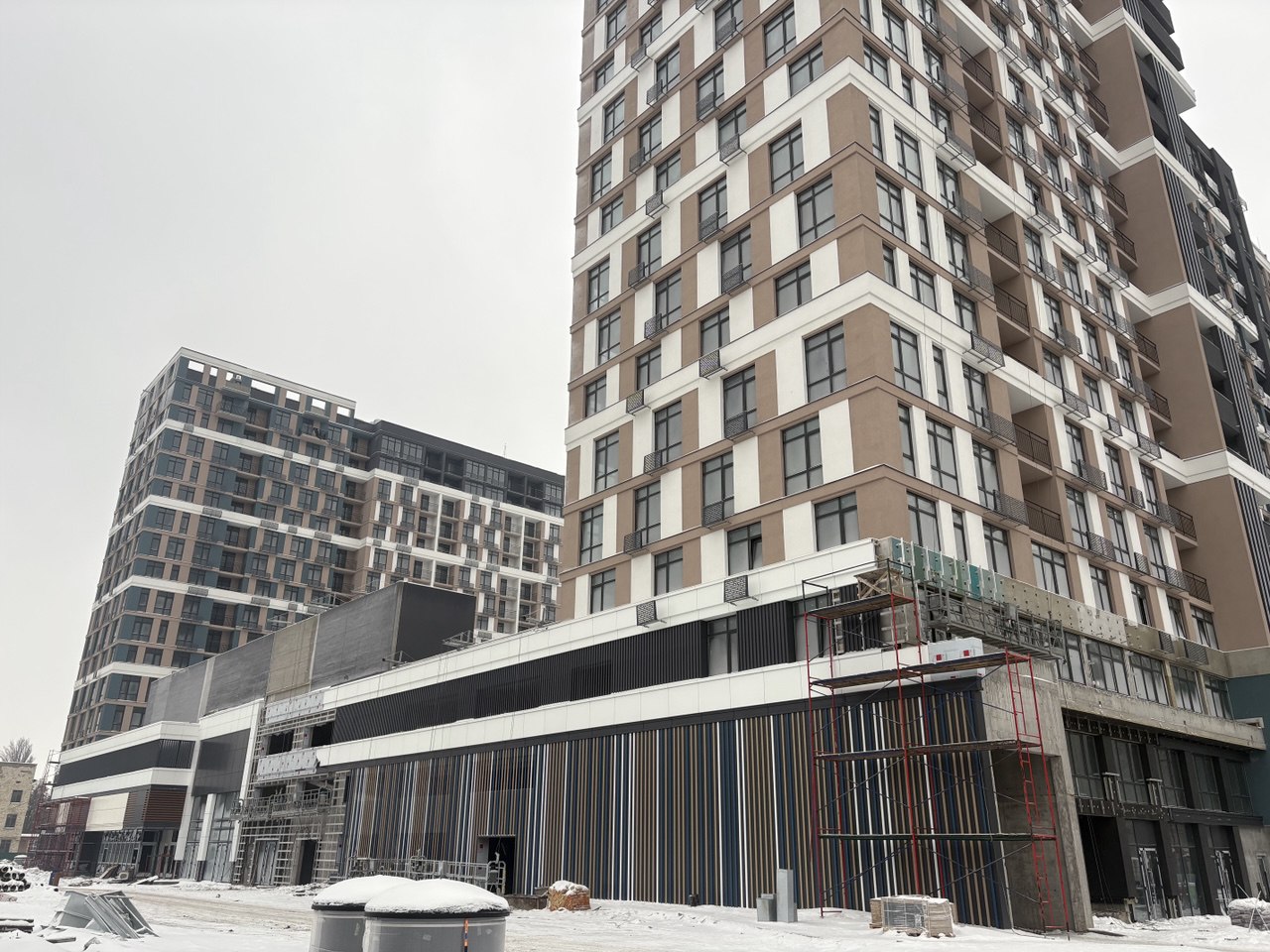

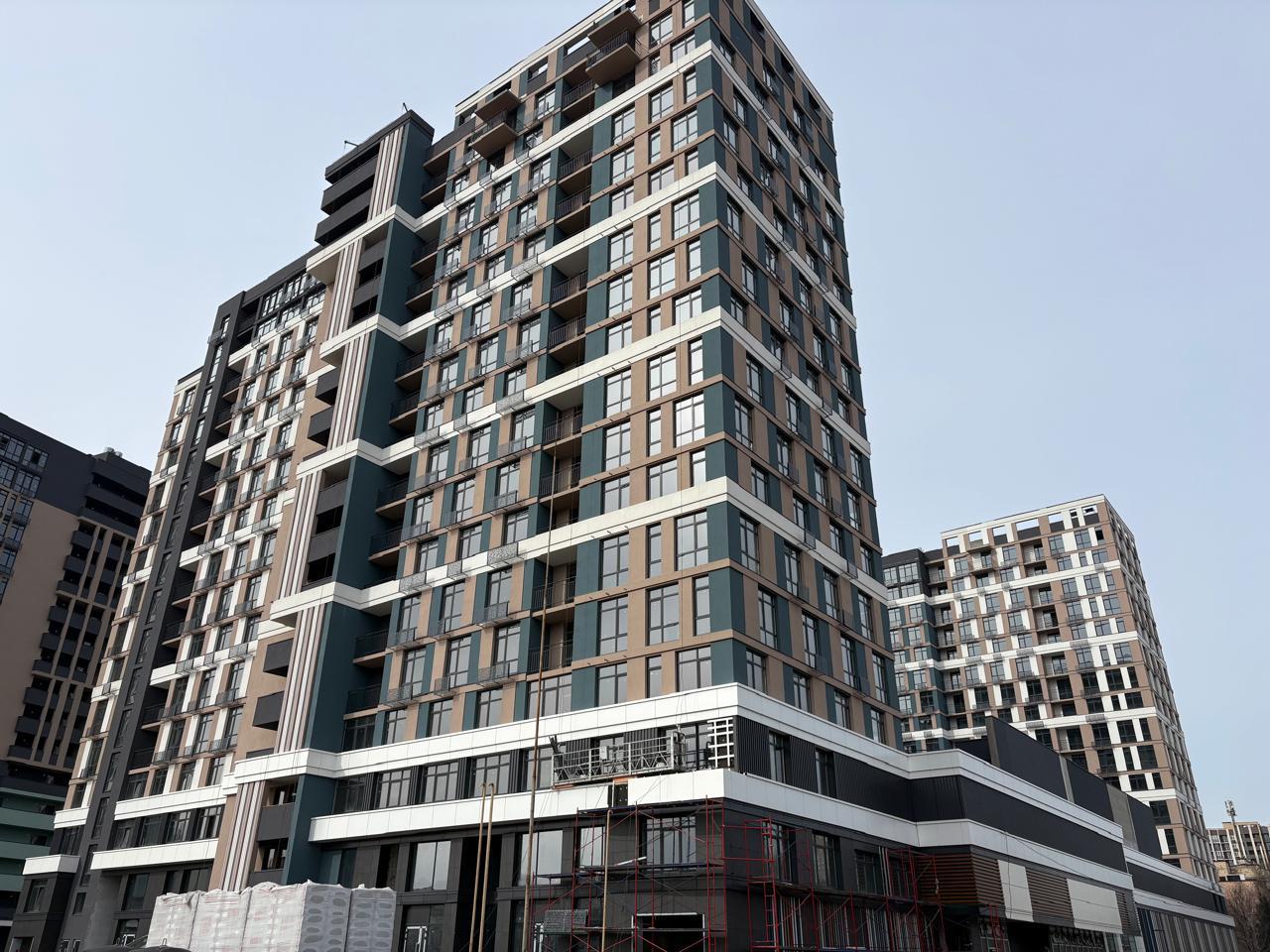

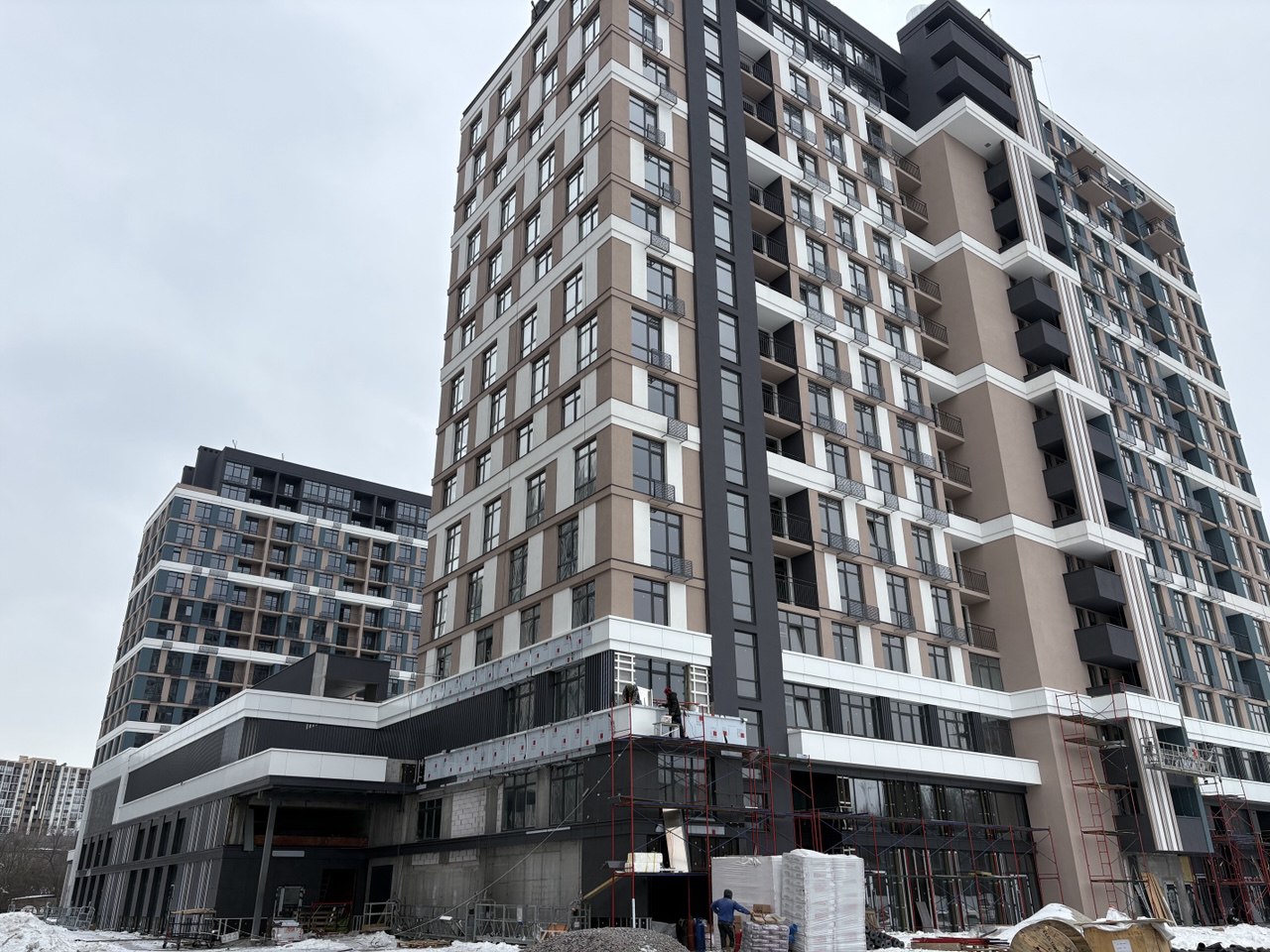

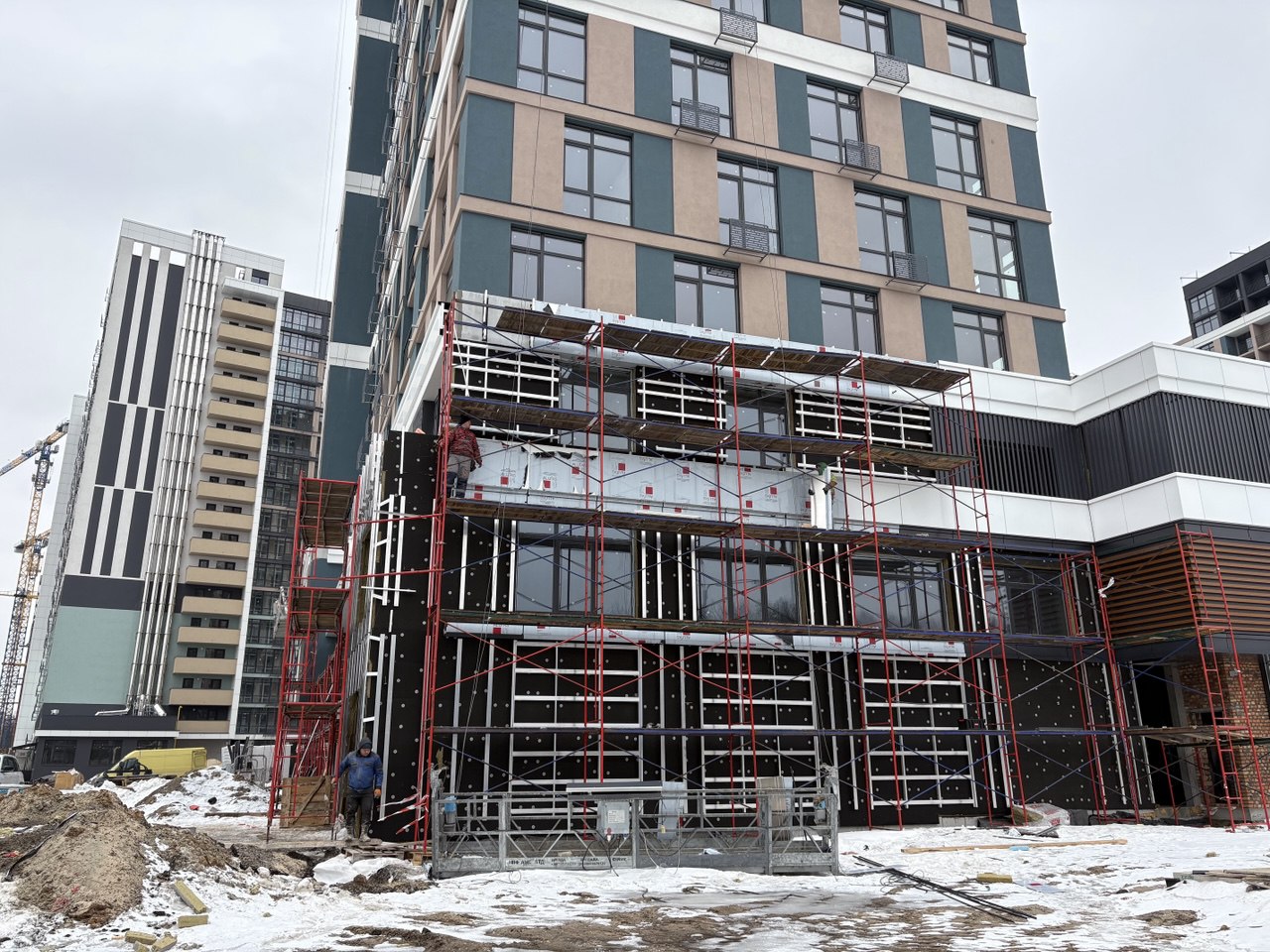

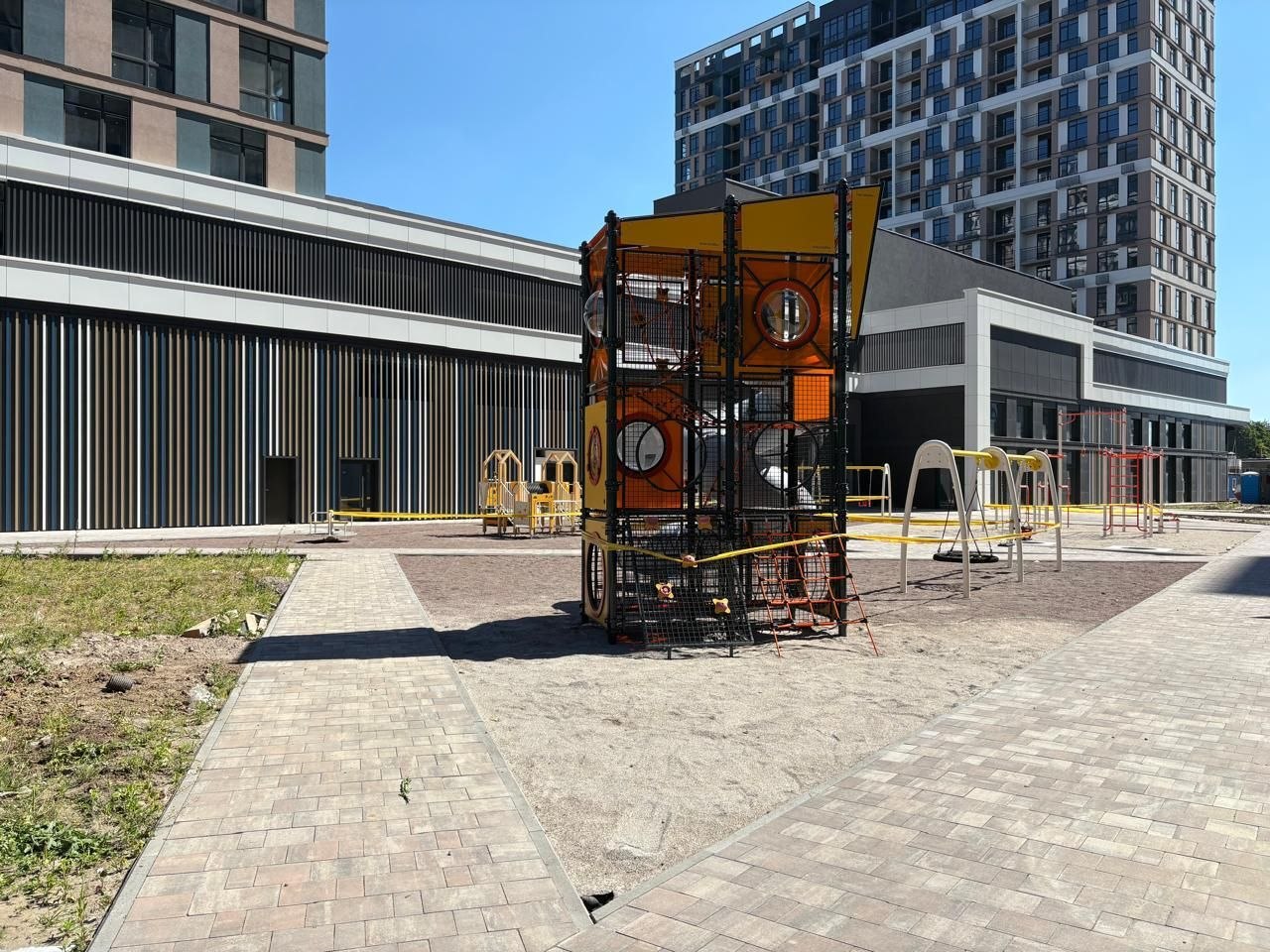

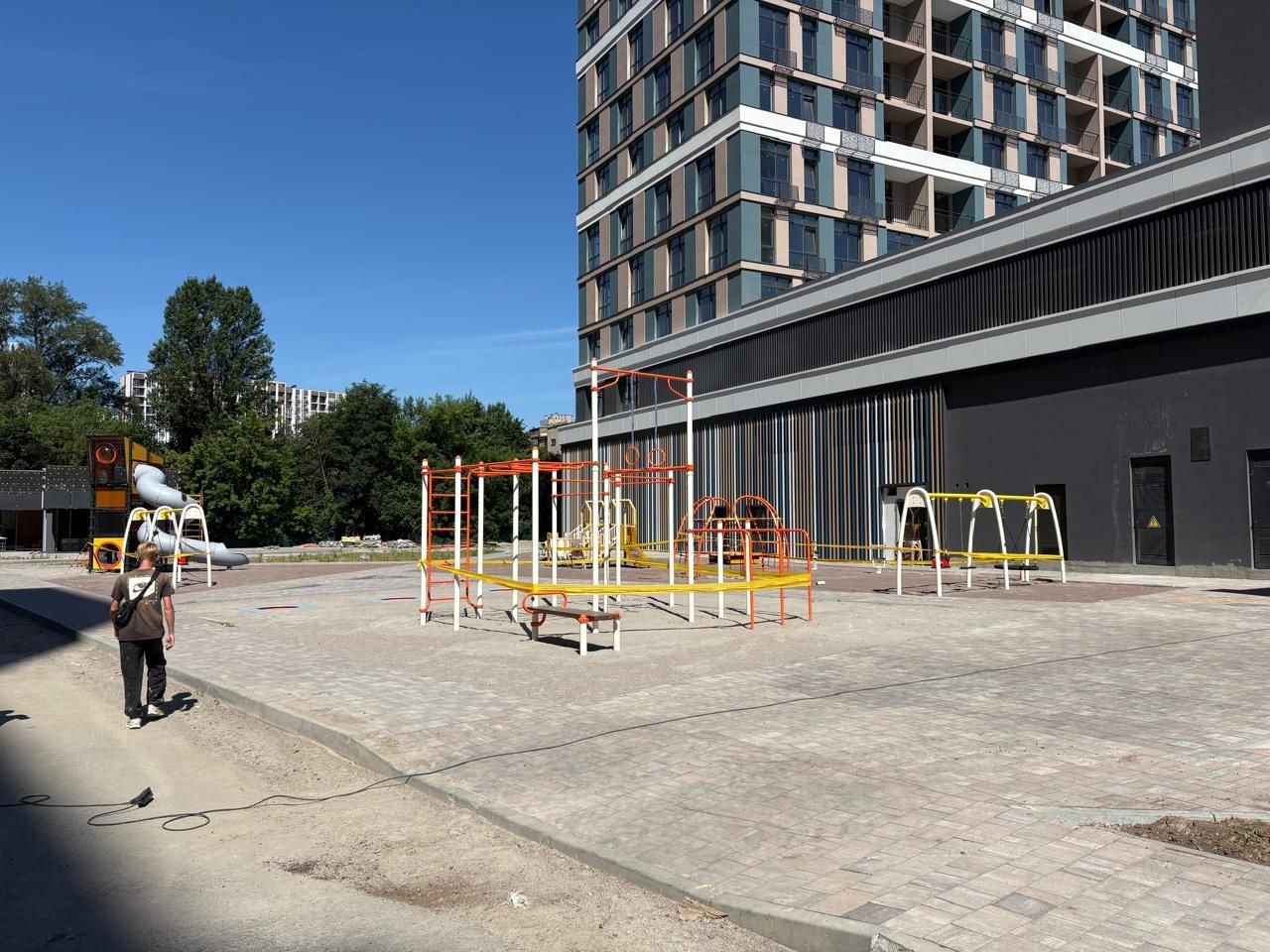

  • BUILDING 7

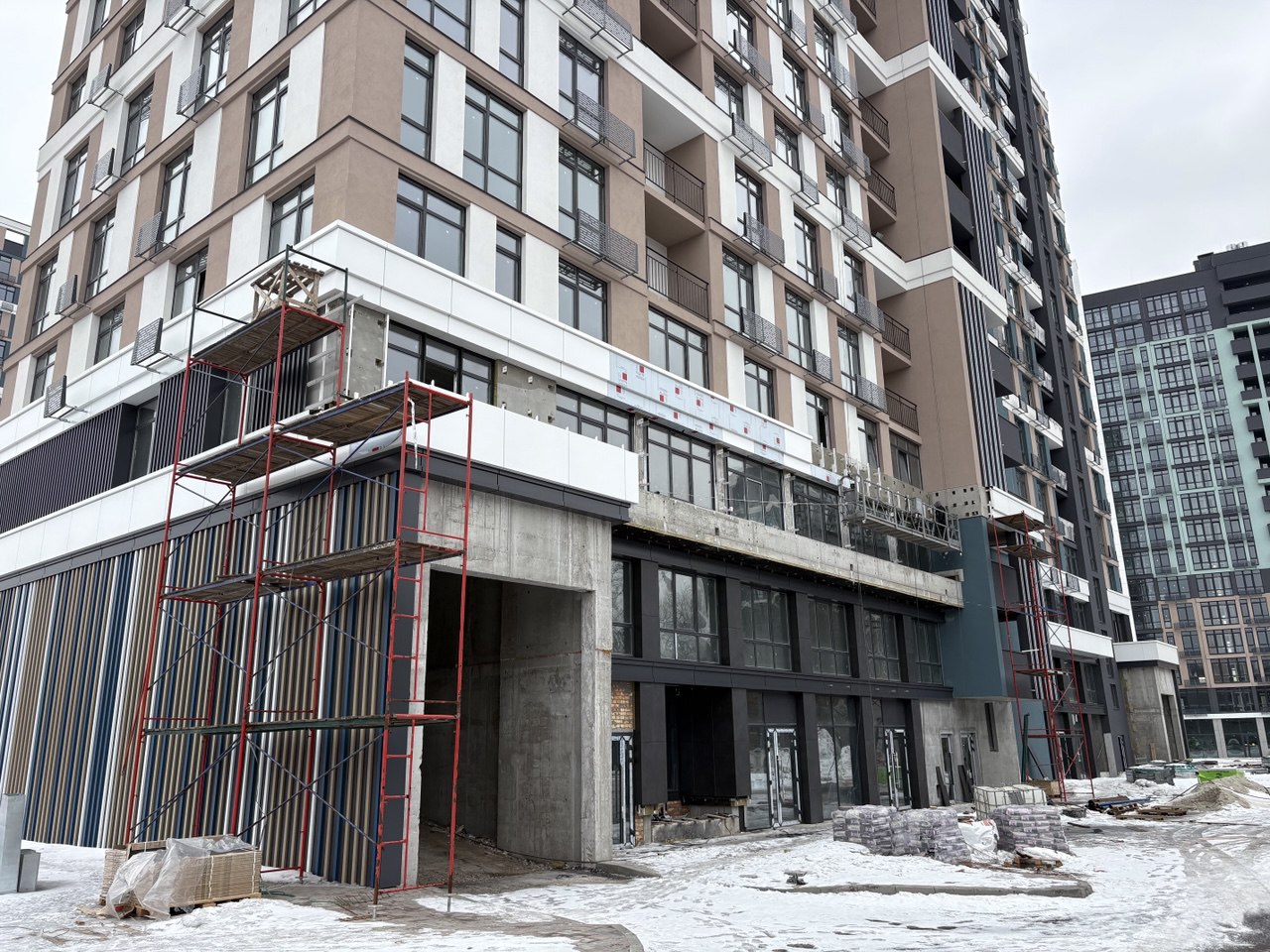

  • Finalizing stylobate façade works; continuing construction of the parking area, commercial premises, and surrounding landscaping.

Take care and donate to the Armed Forces of Ukraine ❤️ Everything will be Ukraine
December 2025

Another step closer to a place where life will soon be in full swing. Construction is moving forward every day — and with each new floor, we come closer to the moment when bright stories, new families, and warm dreams will take shape here.

Here is our latest construction progress update:

  • BUILDING 2

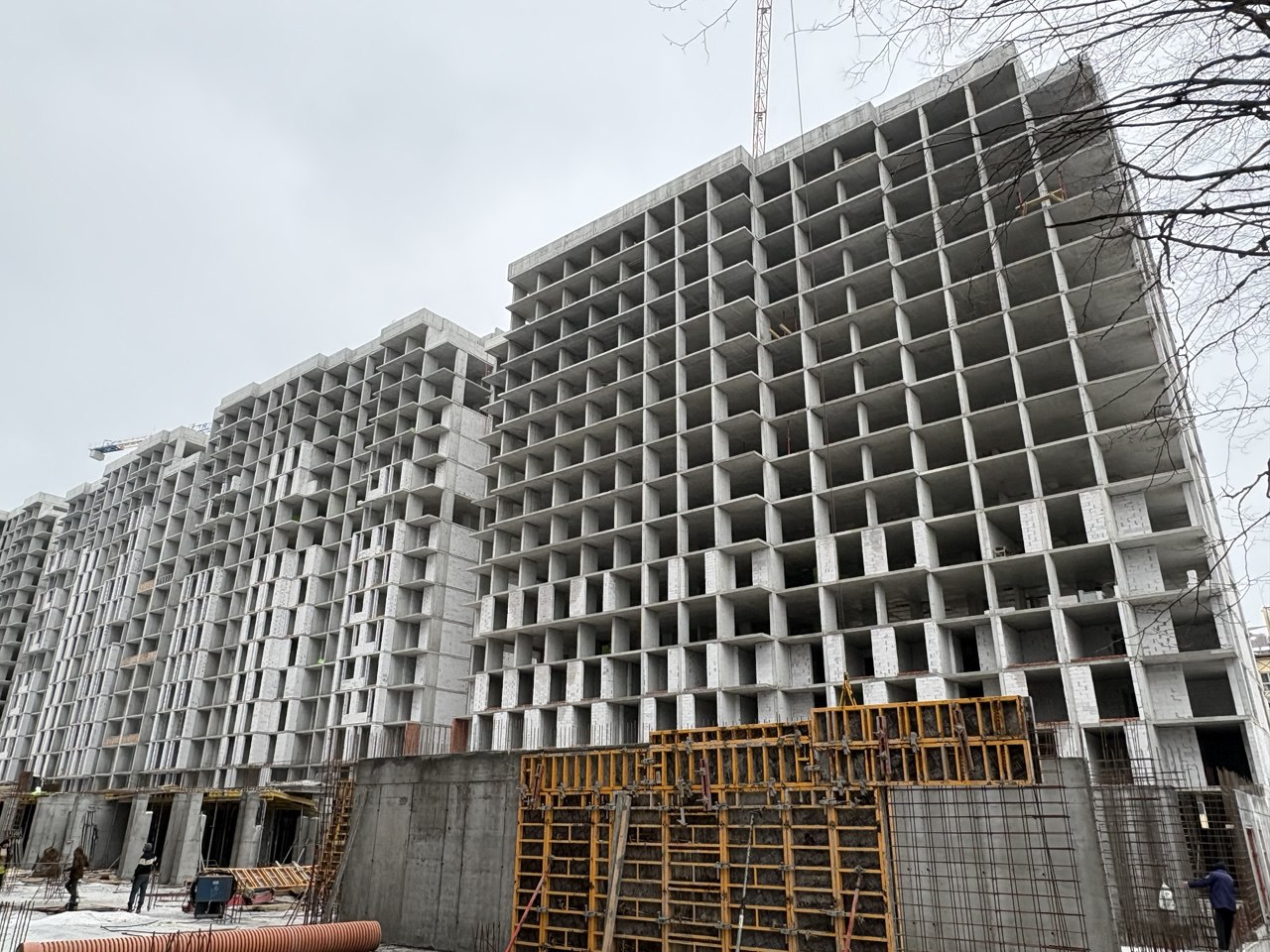

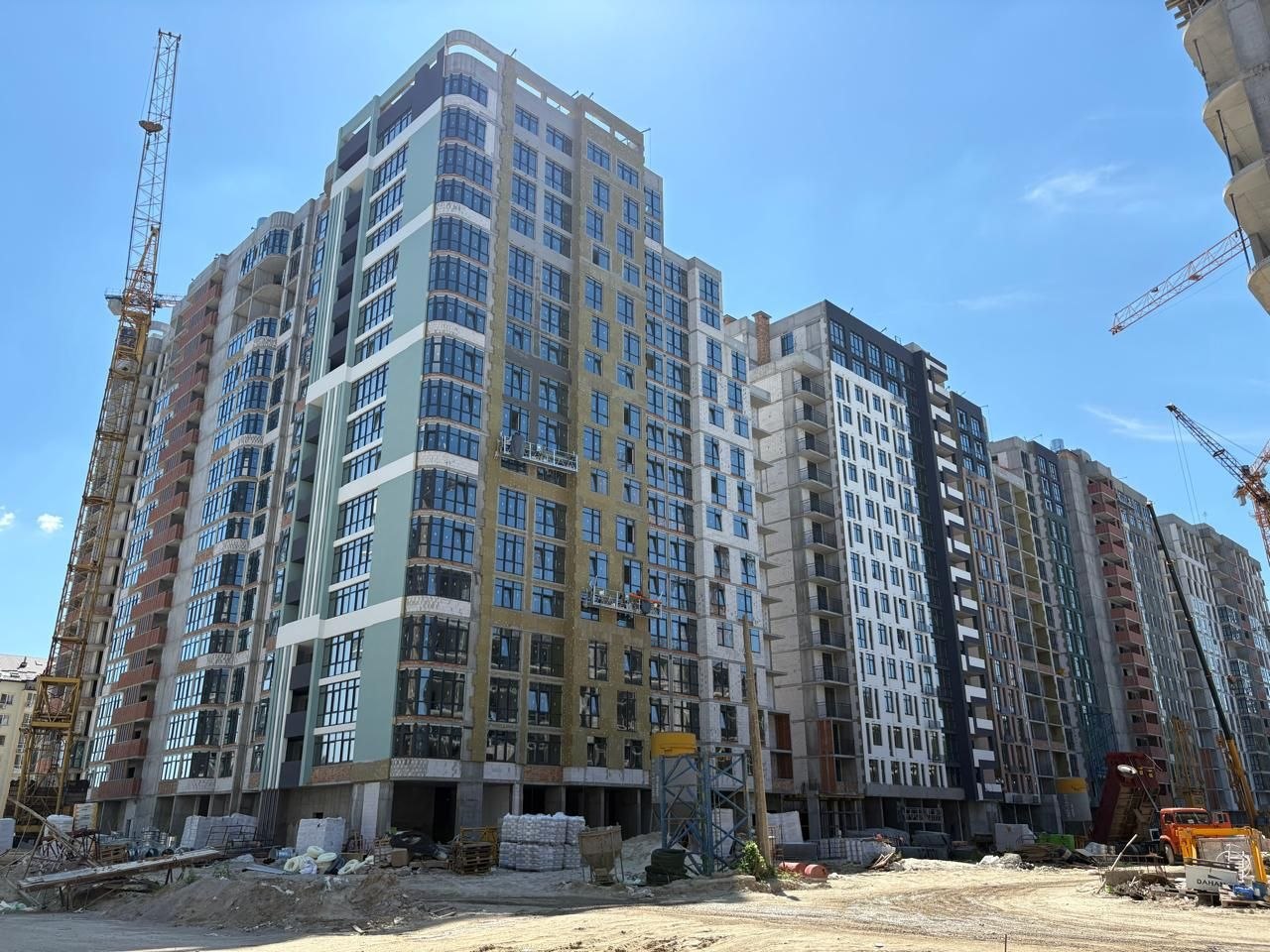

  • SECTION 1 - Glazing and façade works completed; ground floor fit-out is underway.
  • SECTION 2 - Glazing completed on floors 3 and 9–15.
  • SECTION 3 - Glazing completed on floors 2 and 8–16.

  • Transformer substation No. 2 has been constructed.

  • BUILDING 3

  • Completion of monolithic works on the stylobate between Sections 3–7; concreting of vertical structures of the second stylobate level between Sections 2 and 8 completed; foundation works underway for the stylobate between Sections 1 and 9.
  • SECTION 1 - Concreting of vertical structures of the 14th floor.
  • SECTION 2 - Finalizing monolithic works.
  • SECTION 3 - Monolithic works completed; masonry works nearing completion.
  • SECTION 4 - Finalizing monolithic works; masonry works on floors 2–8.
  • SECTION 5Monolithic works completed.
  • SECTION 6 - Finalizing monolithic works.
  • SECTION 7-8 - Monolithic works completed; masonry works on floors 2–8.
  • SECTION 9 - Concreting of vertical structures of the 16th floor.

  • BUILDING 4

  • SECTION 1-3 - Concreting of the grillage slab completed.
  • SECTION 4 - Reinforcement of the basement floor slab.
  • SECTION 5Concreting of the basement floor slab.
  • SECTION 6 - Reinforcement of the basement floor slab.
  • SECTION 7 - Reinforcement and concreting of basement vertical structures.
  • SECTION 8-9 - Concreting of the grillage slab completed.

  • BUILDING 7

  • Stylobate façade works in progress; construction of the parking area, commercial spaces, and surrounding landscaping continues.

Take care and donate to the Armed Forces of Ukraine ❤️ Everything will be Ukraine
New
New
New
New
New
New
New
New
New
New
New
November 2025
New
New
New
New
New
New
New
New
New
New
New
New
September 2025
Put on some warm socks, make some hot cocoa with marshmallows, and let’s share our progress from the construction site:

• BUILDING 1
• We continue to improve the area around the building and on the stylobate, install utilities on the site, and arrange the parking lot.

• BUILDING 2
• SECTION 1 – finishing the first floor.
• SECTION 2 – continuing façade work, glazing the 3rd, 11th, and 14th-15th floors.
• SECTION 3 – continuing façade work – glazing of the 2nd, 13th-16th floors.

• BUILDING 3
• Concreting the second-level vertical stylobate between sections 3-7 and reinforcing the first-level stylobate slab between sections 2-8.
• SECTION 1 – reinforcing and concreting the 9th-floor vertical.
• SECTION 2 – finishing monolithic work.
• SECTION 3 – monolithic work completed, construction of the 2nd floor has begun.
• SECTION 4 – parapet concreting.
• SECTION 5 – reinforcement and concrete pouring of the top floor vertical
• SECTION 6 – concrete pouring of the top floor vertical.
• SECTION 7 – reinforcement of the 16th floor vertical, laying of floors 3-5.
• SECTION 8 – concreting of the 15th floor slab, laying has begun.
• SECTION 9 – reinforcement of the 12th floor vertical.

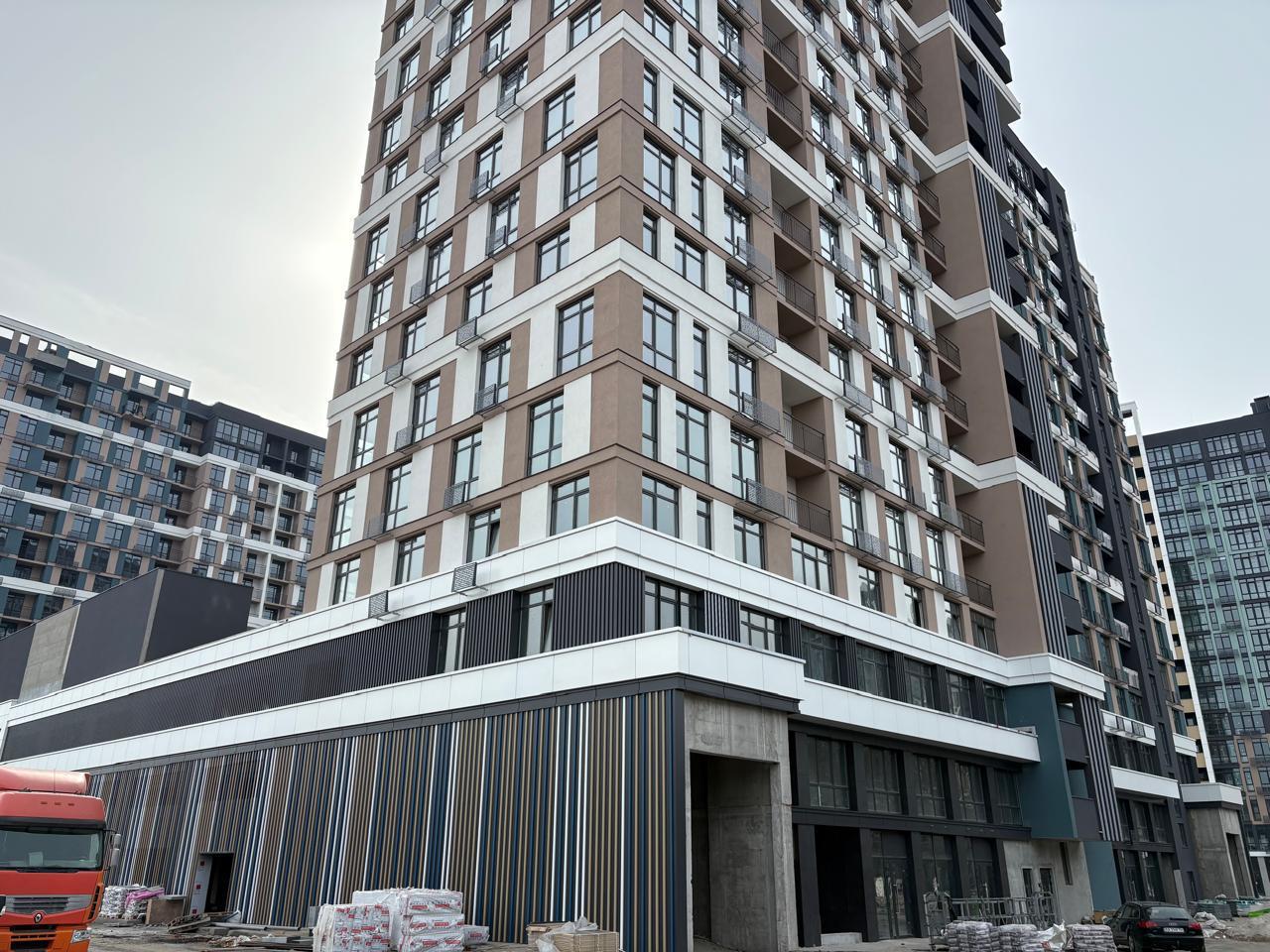

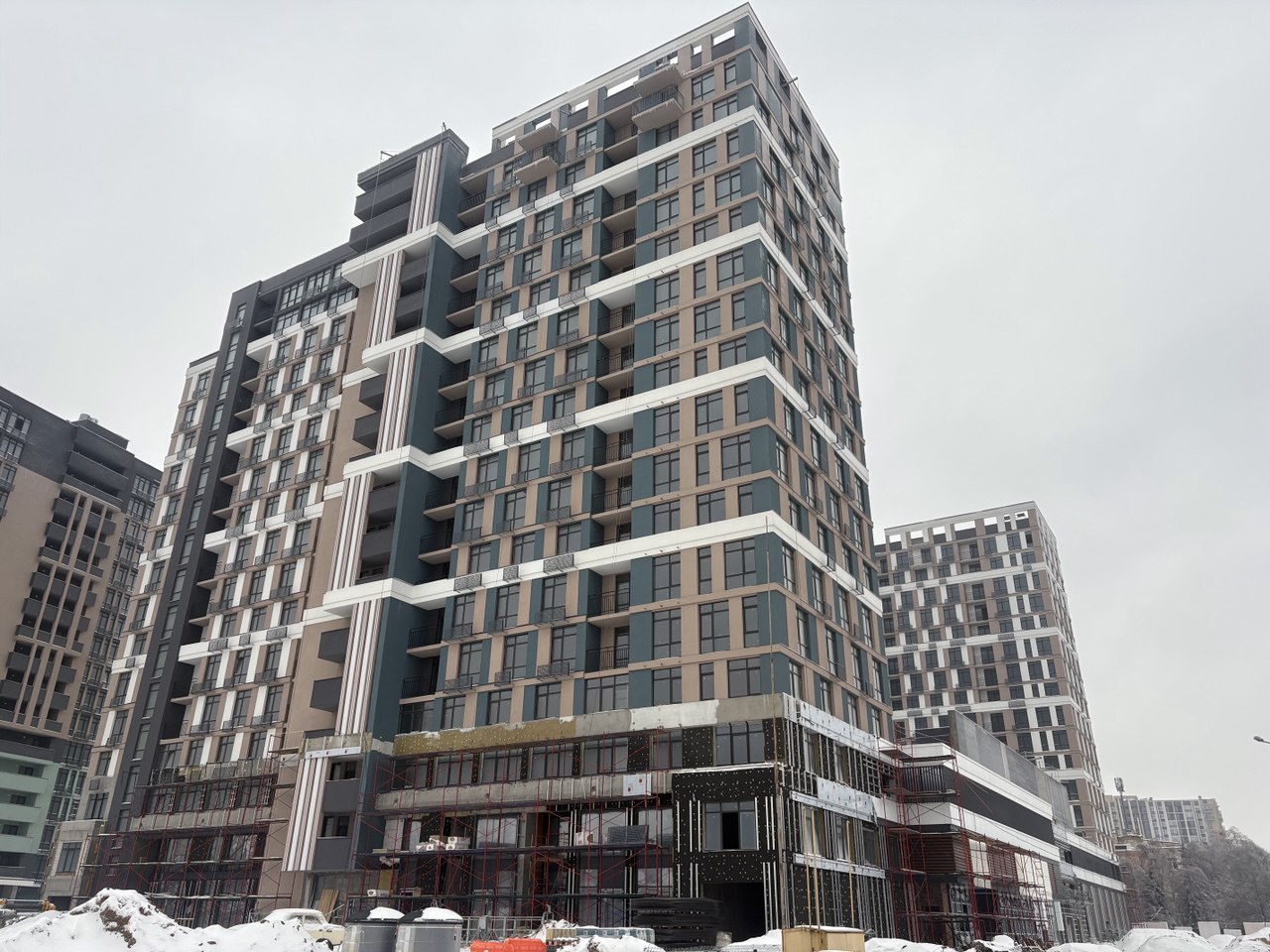

• BUILDING 7

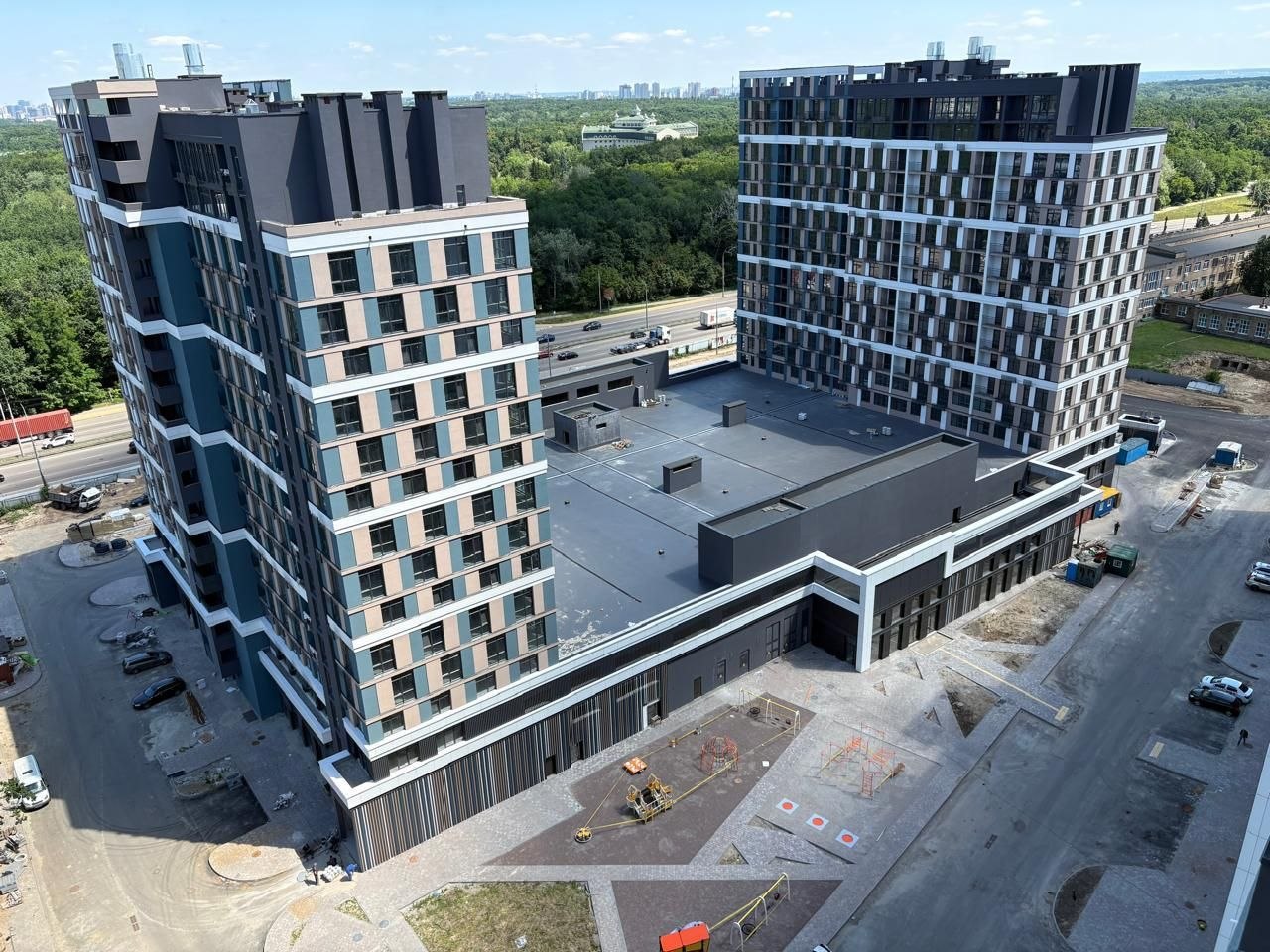

• We are finishing the facades, developing the parking lot, commercial premises, and landscaping around the building.

Take care and donate to the Armed Forces of Ukraine ❤️ Everything will be Ukraine!
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
August 2025

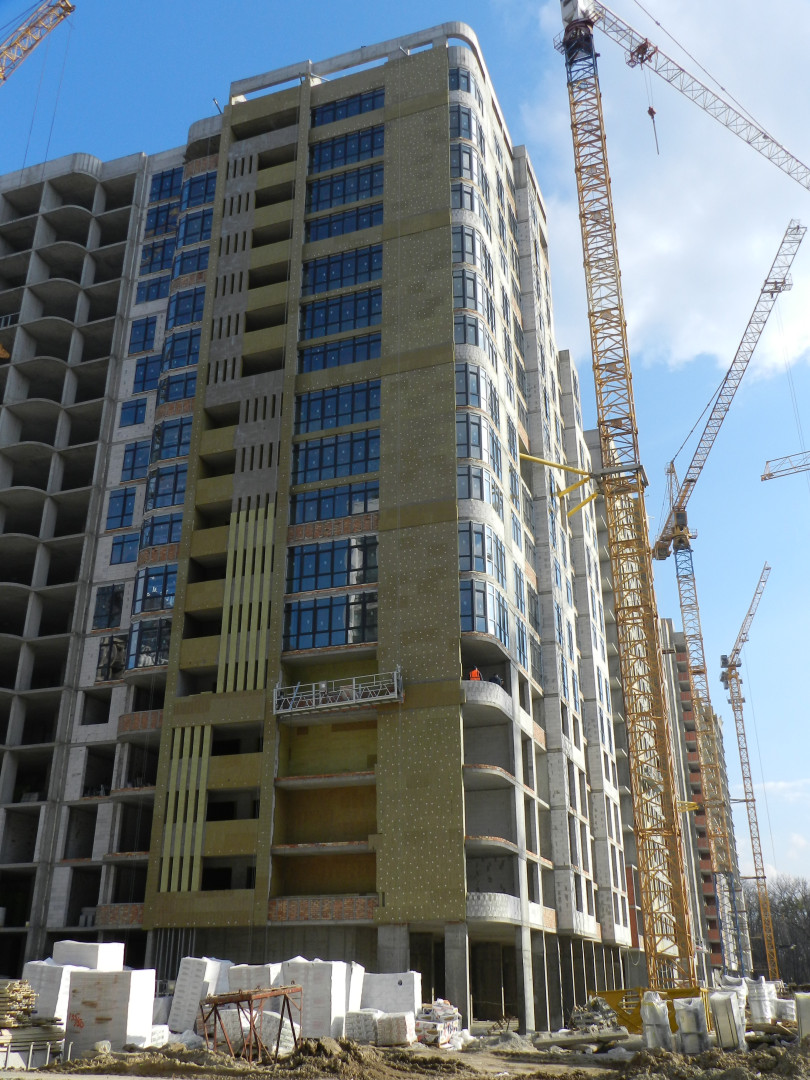

Summer flew by, and tomorrow the first-graders will be going to school for the first time. Meanwhile, we visited the construction site:

• BUILDING 1
• We're landscaping around the building and on the stylobate, continuing to install utilities on the site, and finished the monolithic work on the transformer substation.

• BUILDING 2
• SECTION 1 – façade work completed, moving on to the first floor.
• SECTION 2 – façade work continuing, window glazing started.
• SECTION 3 – façade work continuing – insulating, plastering, and painting started, windows on the upper floors glazed.

• BUILDING 3

• Concreting the stylobate floor slab between sections 3-7.
• SECTION 1 – concreting the 5th floor slab.
• SECTION 2 – finishing the monolithic work.
• SECTION 3 – monolithic work completed.
• SECTION 4 – parapet reinforcement.
• SECTION 5 – 14th floor vertical concrete pour.
• SECTION 6 – 14th floor vertical concrete pour.
• SECTION 7 – 13th floor vertical reinforcement, masonry work has begun.
• SECTION 8 – 13th floor vertical reinforcement.
• SECTION 9 – 11th floor slab reinforcement.

• BUILDING 7
• We are finishing façade work in the residential sections, and are developing parking and commercial spaces.

Take care and donate to the Armed Forces of Ukraine ❤️ Everything will be Ukraine!
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
July 2025
July seemed to be hot and productive. We're constantly busy and are happy to share fresh photos from the construction site – see how your future home is growing daily:
• BUILDING 1
• We continue to install utilities on the site and landscaping the stylobate, equip the lobbies, and work on the facade of the commercial spaces on the first floor.

• BUILDING 2

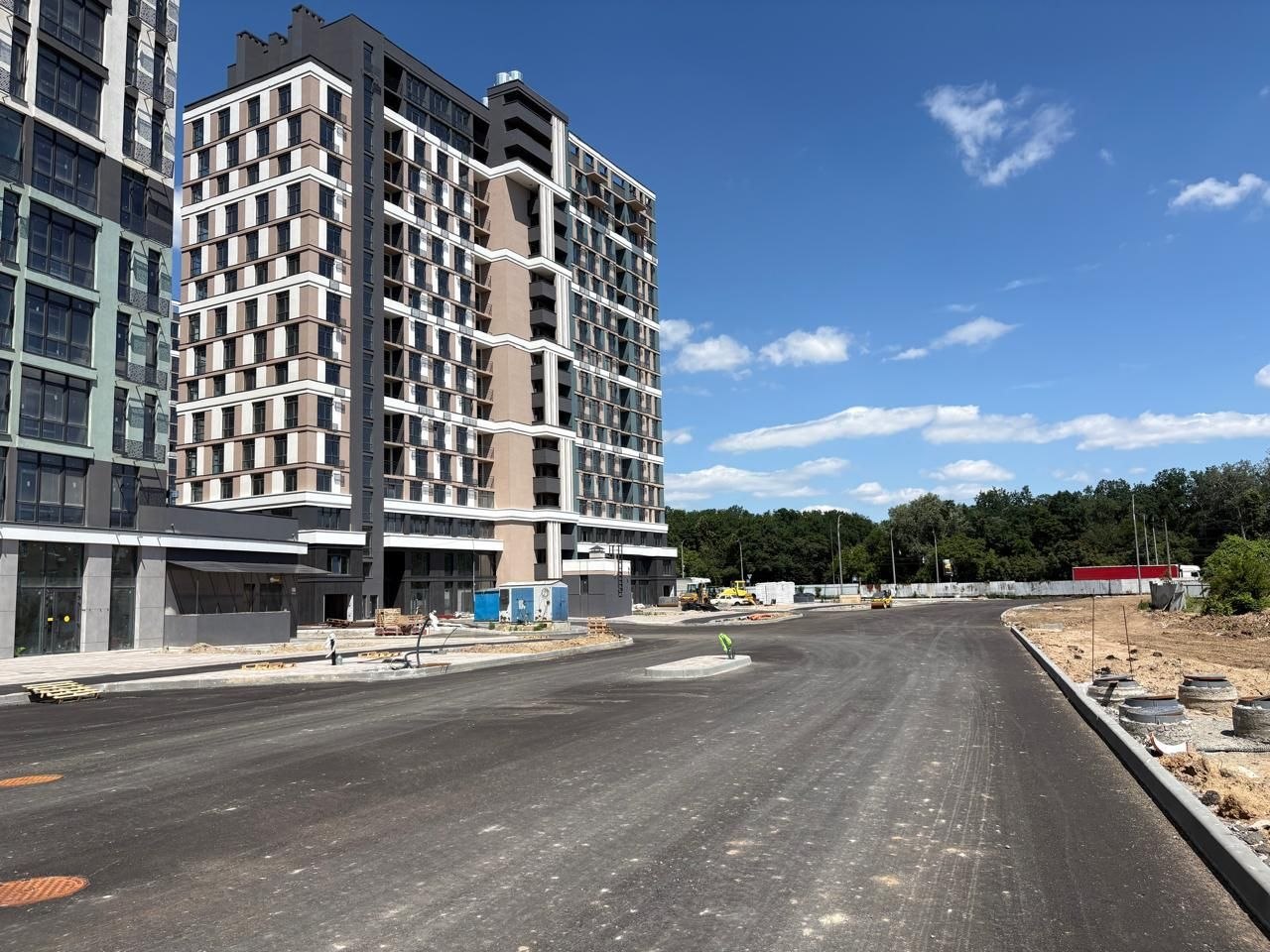

• SECTION 1 – We've finished painting the facade, are installing the baskets for the outdoor air conditioner units, and are continuing interior work.

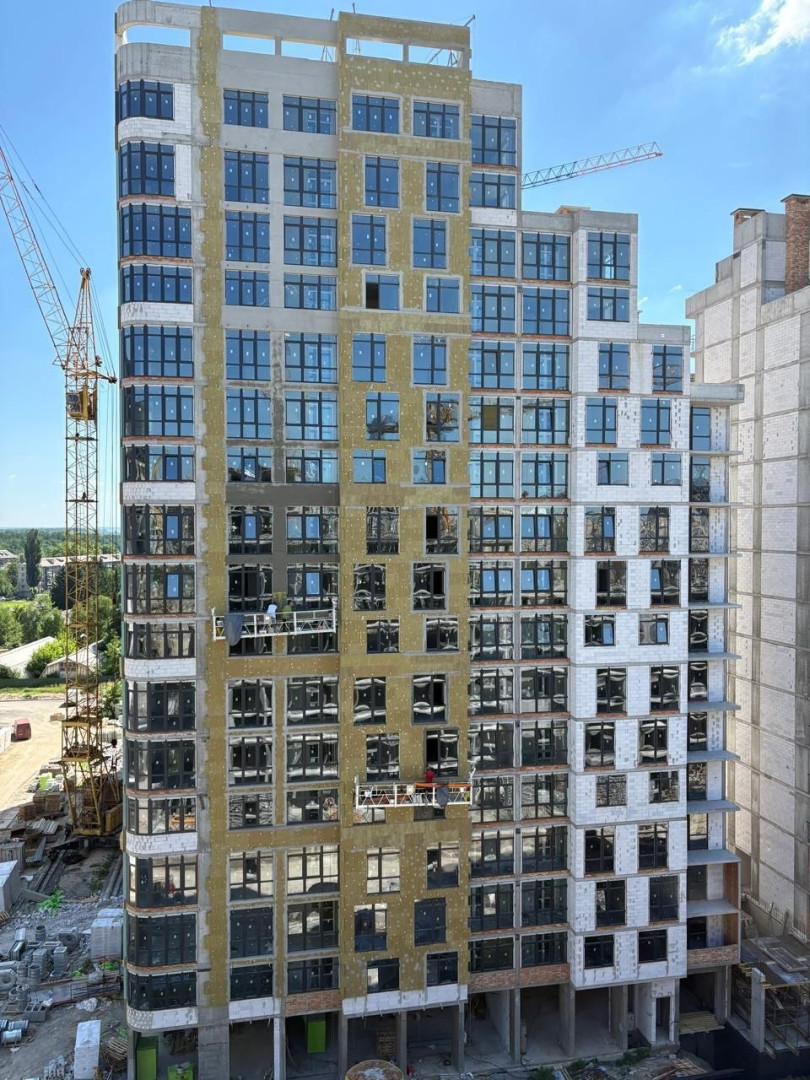

• SECTION 2 – We're finishing insulating and plastering the facades, preparing for painting.
• SECTION 3 – We've completed the masonry work and are insulating the facade.

• BUILDING 3
• SECTION 1 – Reinforcing the 2nd floor slab.
• SECTION 2 – Concreting the 16th floor vertical.
• SECTION 3 – concreting the 16th floor vertical.
• SECTION 4 – reinforcing the 15th floor vertical.
• SECTION 5 – concreting the 10th floor vertical.
• SECTION 6 – reinforcing the 10th floor slab.
• SECTION 7 – concreting the 12th floor slab.
• SECTION 8 – concreting the 12th floor slab.
• SECTION 9 – reinforcing and concreting the 6th floor vertical.

• BUILDING 7
• We're finishing painting, installing air conditioner baskets, and continuing interior work.

Take care and donate to the Armed Forces of Ukraine ❤️ Everything will be Ukraine!
New
New
New
New
New
New
New
New
New
New
New
New
New
New
June 2025
Summer is in full swing  – perfect time for big progress! Take a look at the latest photos and see how your future home is taking shape.

BUILDING 1
• We're installing utilities on the site and landscaping the stylobate, furnishing the lobbies, and working on the façade work for the commercial spaces on the ground floor.

BUILDING 2
• SECTION 1 – painting the facade and continuing interior work
• SECTION 2 – insulating the facades
• SECTION 3 – finishing construction work and beginning facade insulation

BUILDING 3
• SECTION 1 – reinforcing the 1st floor floor slab
• SECTION 2 – reinforcing the 12th floor vertical
• SECTION 3 – concreting the 12th floor vertical
• SECTION 4 – reinforcing the floor slab and concreting the 11th floor vertical
• SECTION 5 – reinforcing and concreting the 4th floor vertical
• SECTION 6 – concreting the 4th floor vertical
• SECTION 7 – concreting the 12th floor vertical
• SECTION 8 – concreting the 11th floor floor slab
• SECTION 9 – Reinforcement of the 2nd floor slab

BUILDING 7
• We've finished insulating the façade; we're continuing with painting and interior work.

Take care and donate to the Armed Forces of Ukraine ❤️ Everything will be Ukraine!
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New

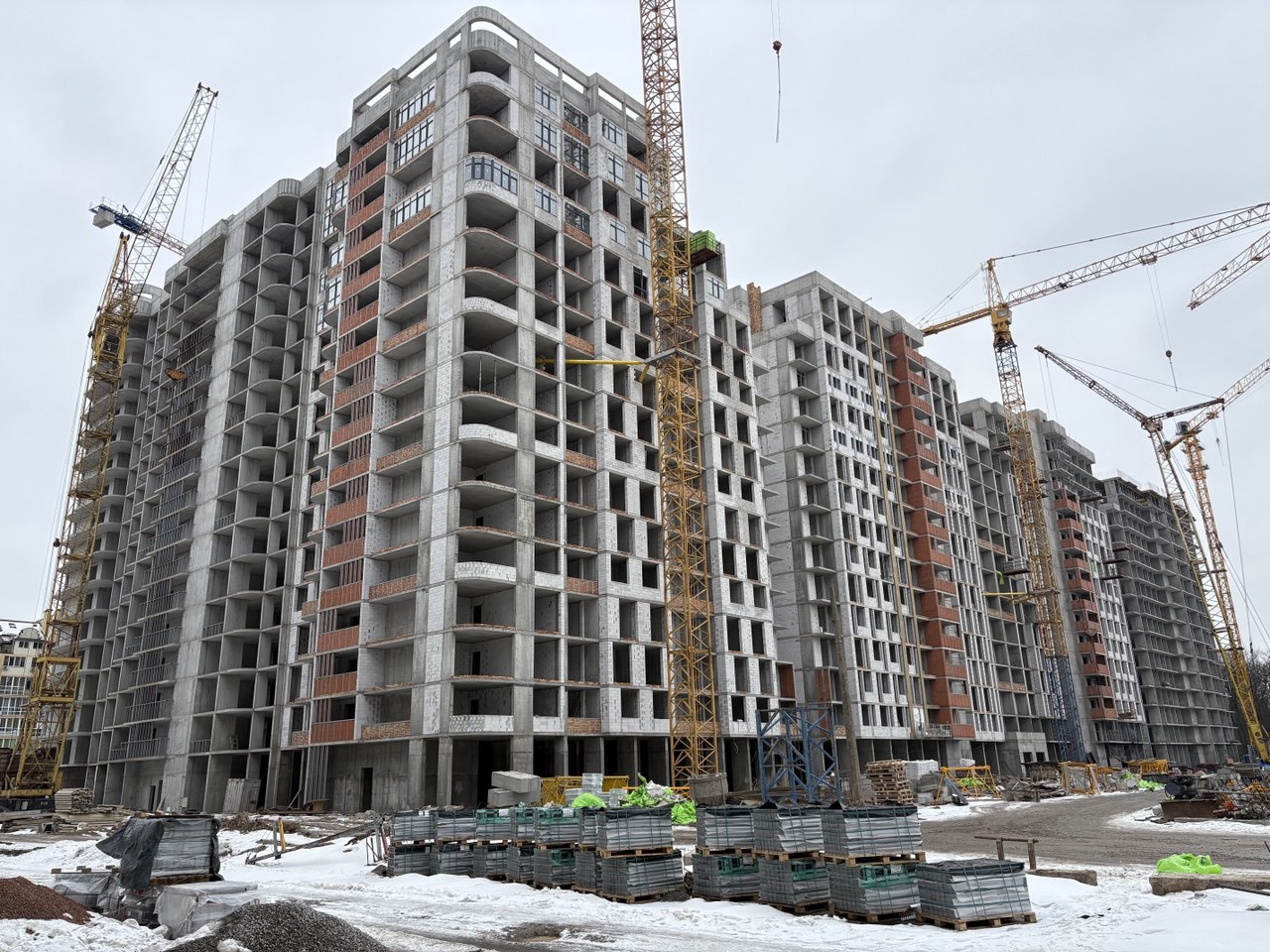

April 2025
Spring is energizing, and we're channeling that energy into construction! New floors, new progress, new photos—watch your future home grow right now:

BUILDING 1
We've completed concrete work on the plinth, are continuing to install utilities on the site and landscaping the plinth, and are working on the façade work for the commercial spaces on the first floor.

BUILDING 2
SECTION 1 – completed glazing and insulation of the facade, preparing to paint
SECTION 2 – completed masonry work, began insulating the facades and glazing the windows
SECTION 3 – continuing masonry work

BUILDING 3

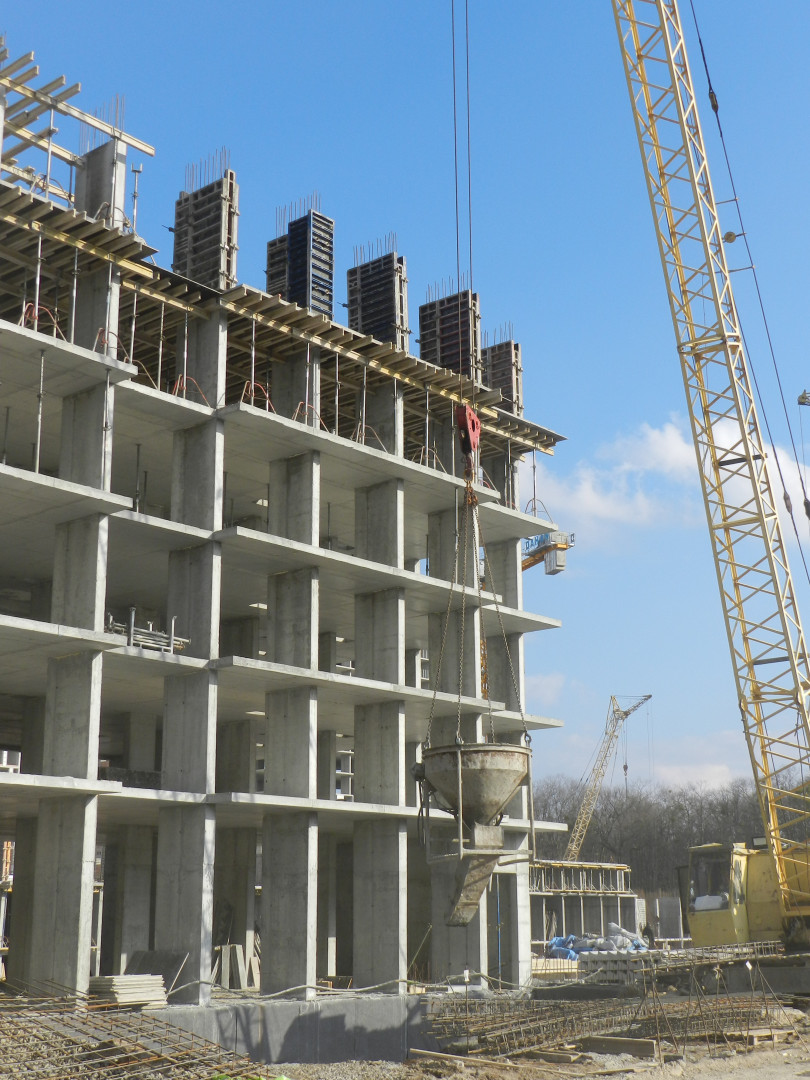

SECTION 1 – reinforcing the basement vertical
SECTION 2 – reinforcing the 8th floor vertical
SECTION 3 – reinforcing the 8th floor slab
SECTION 4 – reinforcing and concreting the 6th floor vertical
SECTION 5 – concreting the basement vertical
SECTION 6 – reinforcing and concreting the 1st floor vertical
SECTION 7 – concreting the 9th floor vertical
SECTION 8 – reinforcing the 9th floor vertical
SECTION 9 – reinforcing and concreting the vertical Basement

BUILDING 7
We've finished glazing the windows, we're finishing insulating the façade, and we've started painting and installing the apartment doors.

Take care and donate to the Armed Forces of Ukraine ❤️ Everything will be Ukraine!
New
New
New
New
New
New
New
New
New
New
New
New
New

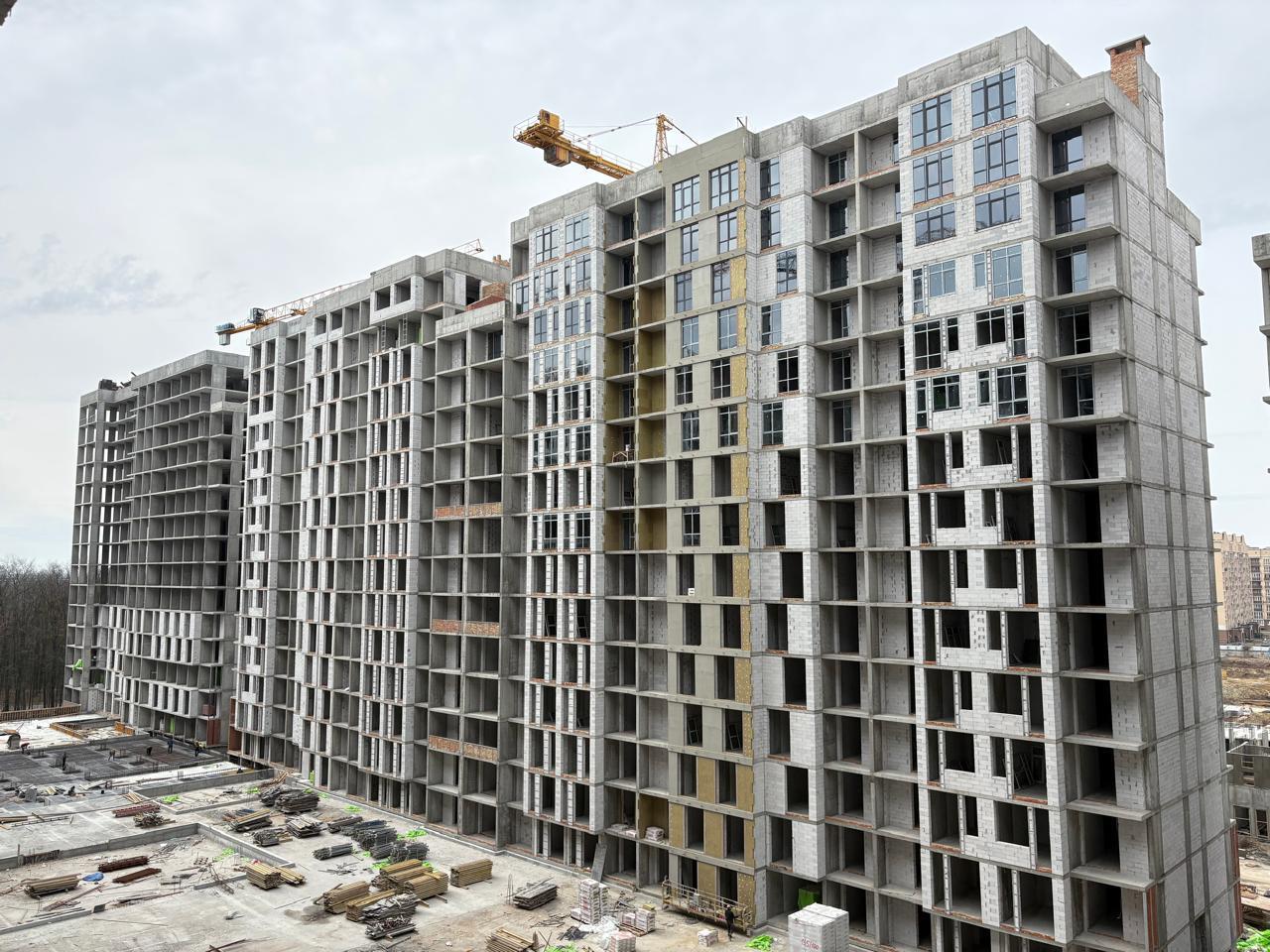

March 2025
Spring has arrived! The first green buds are blooming, animals are basking in the warm rays of the sun and the spring breeze – nature is awakening, and with it, work at the construction site is intensifying:

BUILDING 1
• We're pouring concrete for the stylobate parapet, installing utilities on the site, and continuing landscaping on the stylobate.

BUILDING 2
• SECTION 1 – Masonry work completed, finishing façade insulation, glazing floors 2-5
• SECTION 2 – laying floors 2-9
• SECTION 3 – Monolithic work completed, building floors 2-7

BUILDING 3
• SECTION 1 – Basement vertical reinforcement
• SECTION 2 – 3rd floor floor slab formwork set
• SECTION 3 – 4th floor vertical concreting
• SECTION 4 – 1st floor slab concreting, 2nd floor vertical
• SECTION 5-6 – Basement vertical reinforcement
• SECTION 7 – 4th floor vertical reinforcement
• SECTION 8 – 3rd floor floor slab reinforcement
• SECTION 9 – Reinforcement and concreting Basement vertical

BUILDING 7
• SECTION 1 – We continue façade glazing work, preparing for painting.
• SECTION 2 – Monolithic and stone work completed, we're starting to insulate the façades and finishing the glazing.

Take care and donate to the Armed Forces of Ukraine ❤️ Everything will be Ukraine!
New
New
New
New
New
New
New
New
New
New
December 2024-January 2025
We've worn out our new rubber boots on the construction site and prepared our first photo report on construction in the new year:

BUILDING 1
• We're installing utilities on the site and continuing landscaping on the stylobate

BUILDING 2

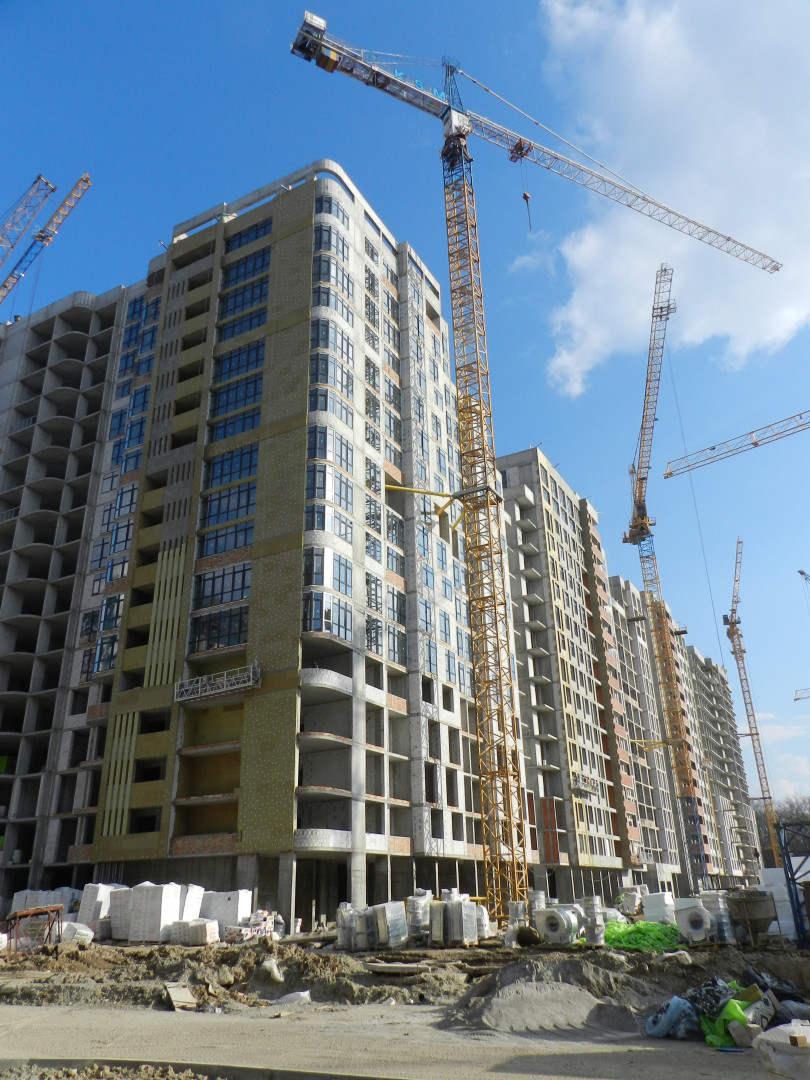

• SECTION 1 - monolithic work completed, continuing construction of floors 2-9
• SECTION 2 - completed monolithic work on the floors, reinforcing the parapet, building floors 2-6
• SECTION 3 - concreting the vertical of the 15th floor, building floors 2-5

BUILDING 3
• SECTION 1 - concreting the grillage slab

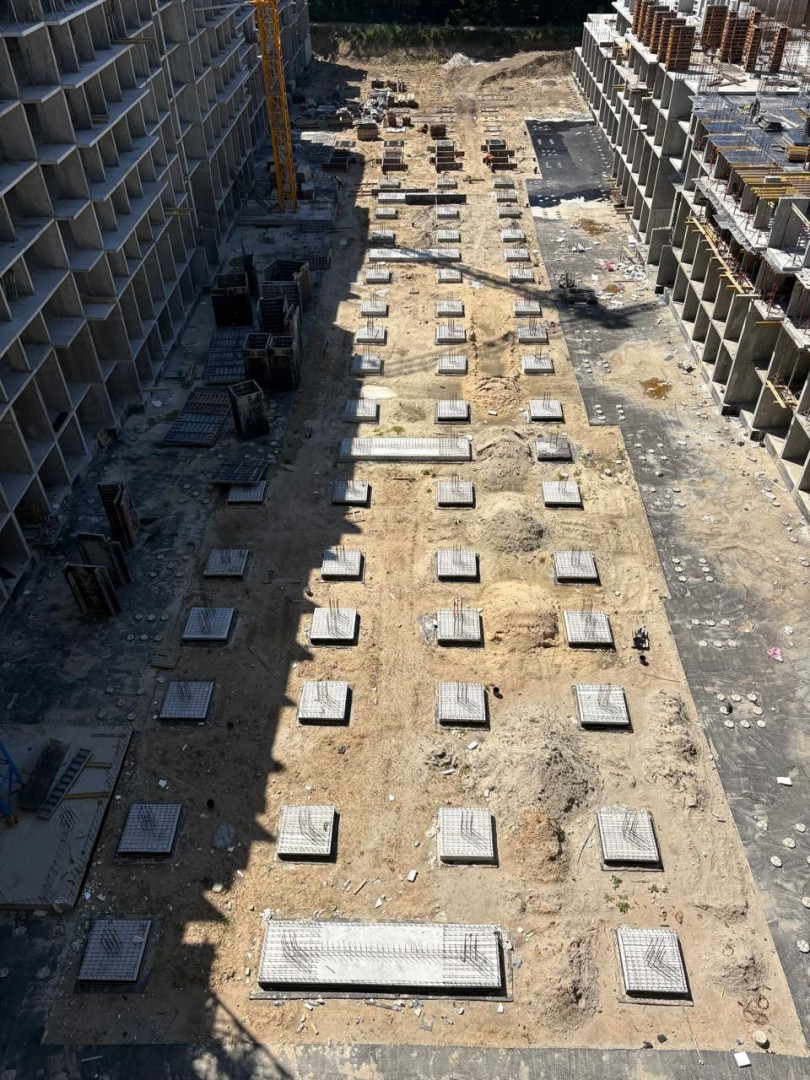

• SECTION 2 - installing formwork for the 1st floor slab
• SECTION 3 - reinforcing the vertical of the 2nd floor
• SECTION 4-6 - reinforcing the vertical of the basement
• SECTION 7 - Concreting the 1st floor slab
• SECTION 8 – Concreting the 1st floor vertical
• SECTION 9 – Concreting the grillage slab

BUILDING 7
• SECTION 1 – Masonry work completed, façade insulation completed, glazing finished, and painting preparations beginning.
• SECTION 2 – Monolithic and masonry work completed, façade insulation beginning

Take care and donate to the Armed Forces of Ukraine ❤️ Everything will be Ukraine!
New
New
New
New
New
New
New
New
New
New
New
New
New
November 2024
BUILDING 1
• We accomplished a lot this fall: we completed glazing and façade work in building 1, and are finishing the entrance areas and living quarters. Elevators and apartment doors have been installed.

We're laying the foundation for comfort: the future courtyard. Landscaping work has been completed on the first of the three courtyards on the stylobate, waterproofing work has been completed on the second, and concrete pouring has been completed on the third, and waterproofing work has begun.

BUILDING 2
• SECTION 1 - monolithic work completed, floors 2-5 under construction
• SECTION 2 - vertical reinforcement of the 14th floor, floors 2-5 under construction
• SECTION 3 - vertical concreting of the 12th floor, floors 2-4 under construction

BUILDING 7
• SECTION 1 - monolithic work completed, finishing the stonework, and facade insulation work has begun.
• SECTION 2 – concreting the vertical section and reinforcing the 16th floor slab, finishing the masonry work

Take care and donate to the Armed Forces of Ukraine ❤️ Everything will be Ukraine!
New
New
New
New
New
New
New
New
New
July 2024
CONSTR. 1, STAGE 1-2

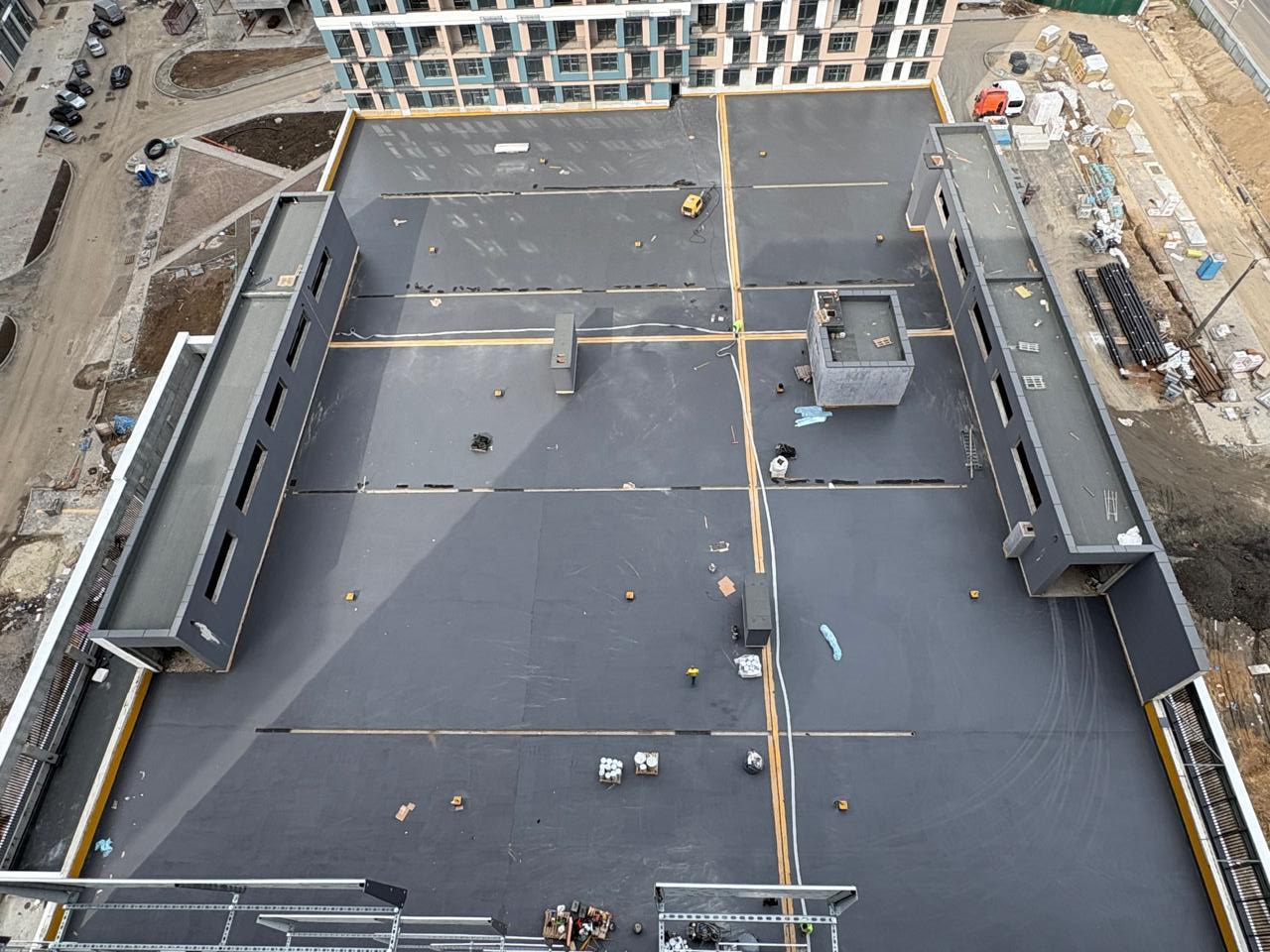

• News from the construction site – the facades are already in the final stages of completion, utilities are being installed, and the stylobate is being completed.

Take care and donate to the Armed Forces of Ukraine ❤️ Everything will be Ukraine!
New
New
New
New
New
New
New
New
New
May 2024

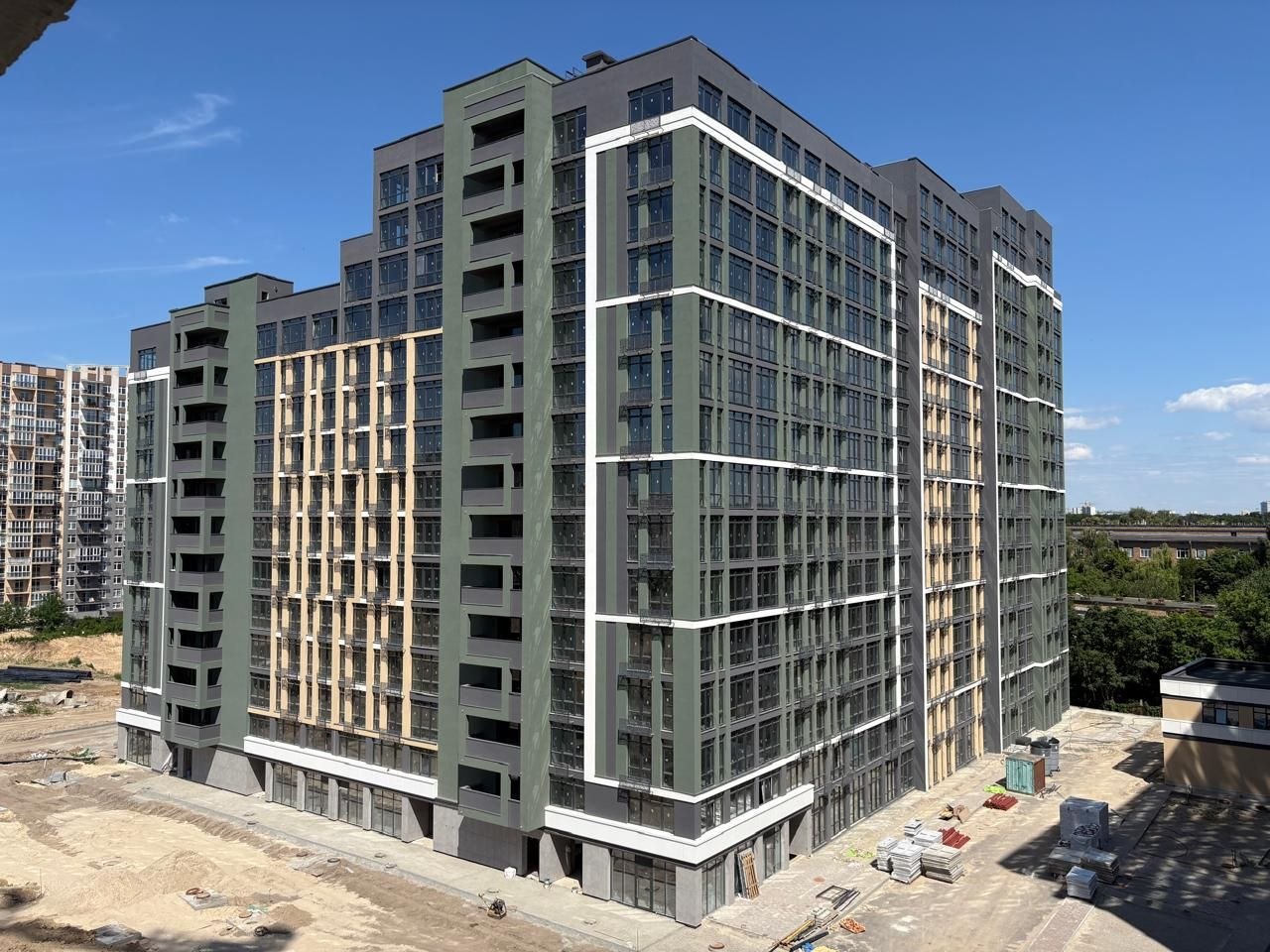

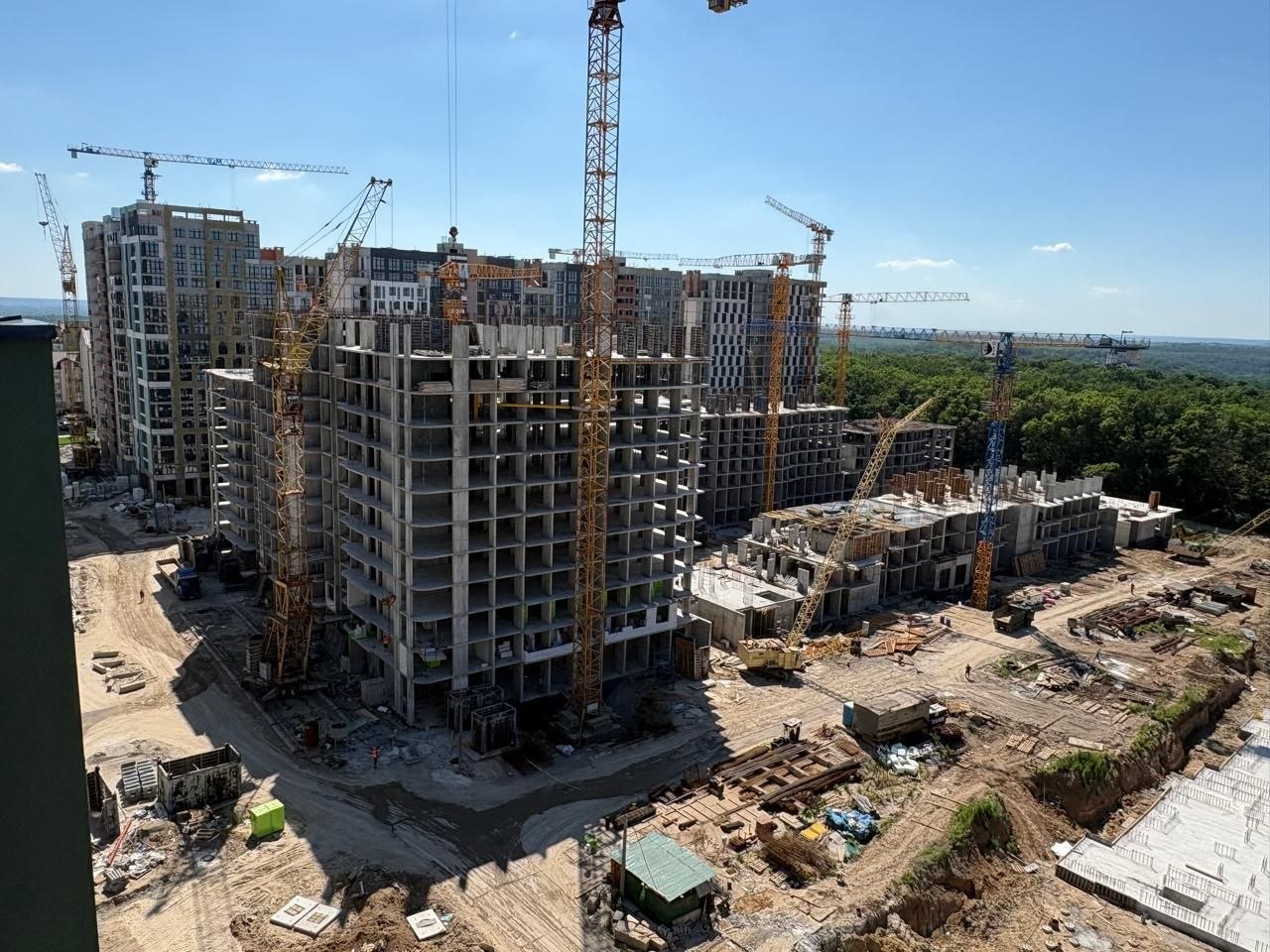

We took a stroll around the construction site and are sharing a fresh photo report:

CONSTR. 1, STAGE 1-2
• BUILDING D, C – monolithic, masonry, and façade work completed, finishing interior work, elevators installed (lined with protective panels on the inside), entrance area finishing continues
• BUILDING B, A – monolithic work completed, masonry and façade work completed, interior work has begun.

Take care and donate to the Armed Forces of Ukraine ❤️ Everything will be Ukraine!
New
New
New
New
New
New
March 2024

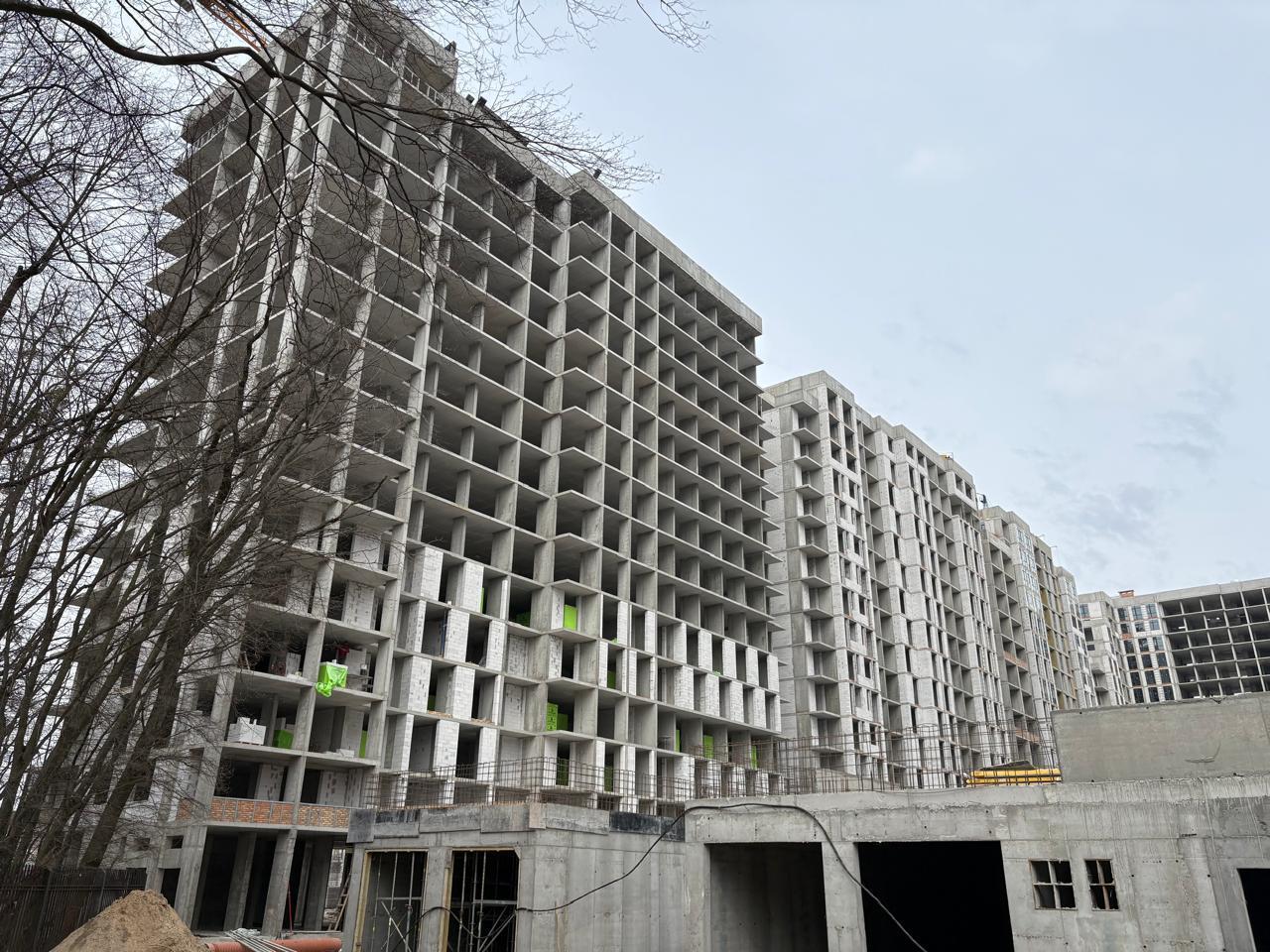

The cold days are over, and we're finishing up construction work on building 1!

CONSTR. 1, STAGE 1-2
• Monolithic work is complete, we're finishing the stone and façade work, continuing interior work, and installing elevators and apartment doors.

Take care and donate to the Armed Forces of Ukraine ❤️ Everything will be Ukraine!
New
New
New
New
New
New
New
New
New
New
January 2024
Monolithic work on Building 1 is almost complete!

CONSTR. 1, STAGE 1-2
• BUILDING D – monolithic, stone, and façade work completed, interior work continuing, apartment doors installed
• BUILDING C – monolithic and stone work completed, façade work finishing
• BUILDING B – monolithic work completed, stone work finishing, façade work continuing
• BUILDING A – monolithic work finishing, construction beginning

Take care and donate to the Armed Forces of Ukraine ❤️ Everything will be Ukraine!
New
New
New
New
New
New
New
November 2023
Winter is already here, but that's not stopping our builders. We've completed the monolithic work on the stylobate between Buildings D and C and have begun building a fire access ramp, and we're already pouring concrete on the stylobate between Buildings C and B!

CONSTR. 1, STAGE 1-2
• SECTION 15-6 - monolithic work completed, finishing masonry, closing windows, painting and installing curtain walls, continuing interior work
• SECTION 5 - reinforcing the 17th floor vertical
• SECTION 4 - reinforcing the 12th floor vertical
• SECTION 3 - concreting the 13th floor vertical
• SECTION 2 - finishing concreting the parapet
• SECTION 1 - monolithic work completed

Take care and donate to the Armed Forces of Ukraine ❤️ Everything will be Ukraine!
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
October 2023
Just look at our progress at the construction site. We're almost finished in buildings D and C, and have even begun monolithic work on the stylobate between them! We've prepared a fresh photo report for you:

CONSTR. 1, STAGE 1
• SECTION 15-8 – monolithic work completed, finishing window glazing, painting, and installing curtain walls, continuing interior work
• SECTION 7, 6 – roof parapet concreting, masonry work
• SECTION 5 – 11th floor vertical concreting
• SECTION 4 – 6th floor vertical concreting
• SECTION 3 – 7th floor vertical concreting
• SECTION 2, 1 – 15th floor slab concreting

Take care, dress warmly, and donate to the Armed Forces of Ukraine! ❤️ Everything will be Ukraine!
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
August 2023
We've started painting building 1! We visited the construction site and prepared a fresh photo report for you.

CONSTR. 1, STAGE 1
• SECTION 15-10 – monolithic work completed, continuing masonry and façade work, window glazing, and painting.
• SECTION 9 – finishing concreting the roof parapet, masonry work.
• SECTION 8 – reinforcement and concreting of the 14th floor vertical
• SECTION 7.6 – concreting of the 9th floor slab and reinforcement of the 10th floor vertical
• SECTION 5 – reinforcement and concreting of the 4th floor slab
• SECTION 4 – formwork for the 1st floor slab
• SECTION 3 – concreting of the 1st floor slab
• SECTION 2.1 – reinforcement and concreting of the 10th floor vertical

Take care and donate to the Armed Forces of Ukraine! ❤️ Everything will be Ukraine!
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
June 2023

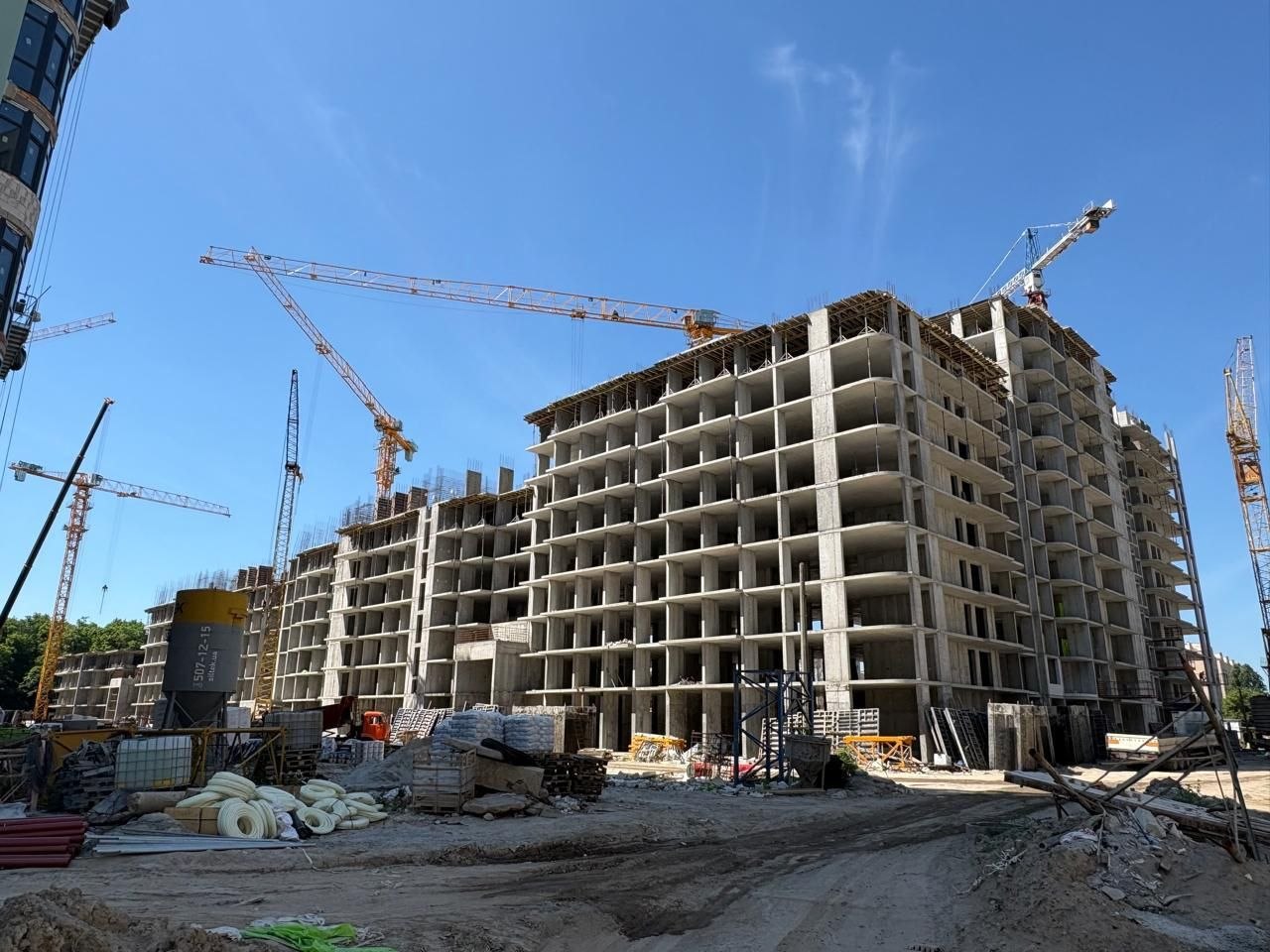

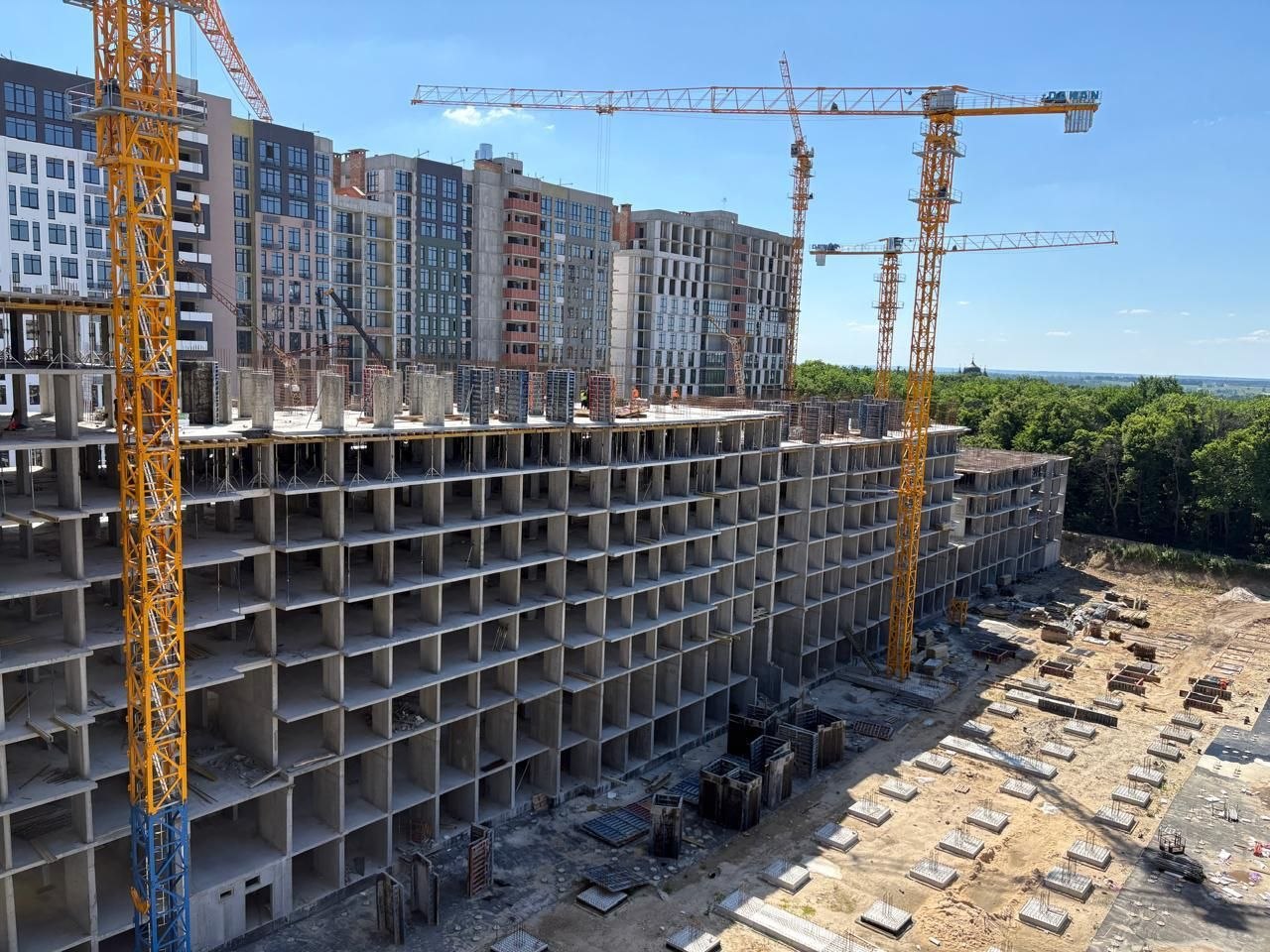

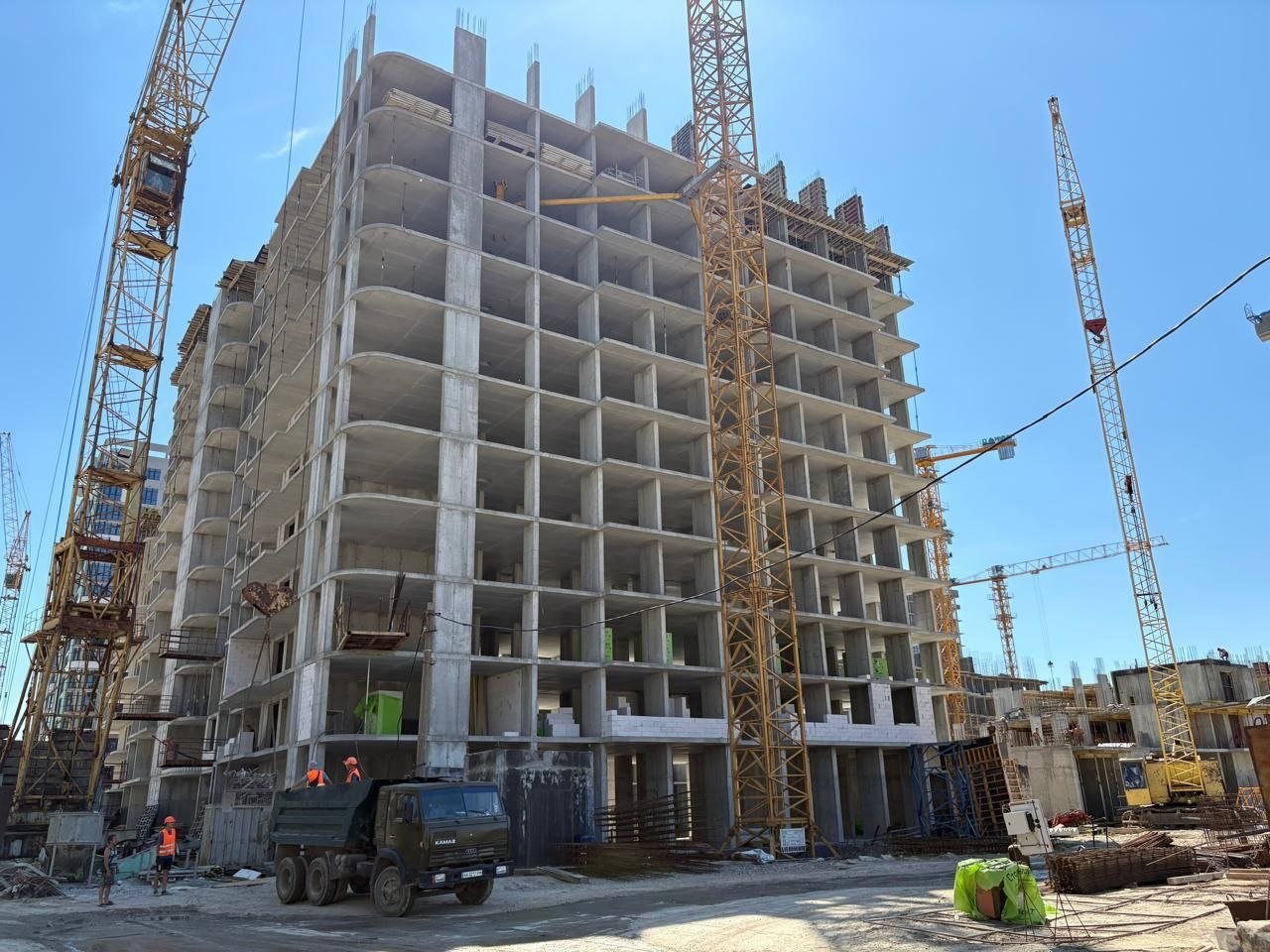

Summer has begun, the sun is warming and helping our builders move faster! In the meantime, we're sharing our progress from the construction site:

CONSTR. 1, STAGE 1

• SECTION 15, 14 - completing masonry work, continuing mineral wool insulation and priming, and beginning to install loggia railings.

• SECTION 13, 12 - reinforcing and concreting the roof parapet, stone work

• SECTION 11, 10 - completed the monolith and are finishing the stone work!

• SECTION 9 – Reinforcement of the 13th floor vertical

• SECTION 8 – Concreting of the 7th floor vertical

• SECTION 7.6 – Concreting of the 2nd floor slab and the 3rd floor vertical

• SECTION 5 – Concreting of the basement vertical

• SECTION 4 – Reinforcement and concreting of the grillage slab

• SECTION 3 – foundation slab concreting completed, basement vertical reinforcement begun

• SECTION 2.1 – reinforcement and concreting of the vertical and 2nd floor slab

Take care and donate to the Ukrainian Armed Forces! ️ Everything will be Ukraine!

New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
New
March 2023
We're sharing some fresh photos from the construction site! We didn't sit idle this winter and even managed to insulate the first sections (so our little house wouldn't be cold). We continue to work and believe in Victory!

CONSTR. 1, STAGE 1
SECTION 15, 14 – masonry work is nearing completion. We're moving on to mineral wool insulation and priming.
SECTION 13 – reinforcement and concreting of the 8th floor vertical
SECTION 12 – concreting of the 7th floor vertical
SECTION 11, 10 – reinforcement and concreting of the 10th floor vertical. Masonry work on floors 2-9
SECTION 9 – concreting the 2nd floor slab
SECTION 8 – basement vertical reinforcement
SECTION 7, 6 – 1st floor completed, preparation for 2nd floor vertical reinforcement

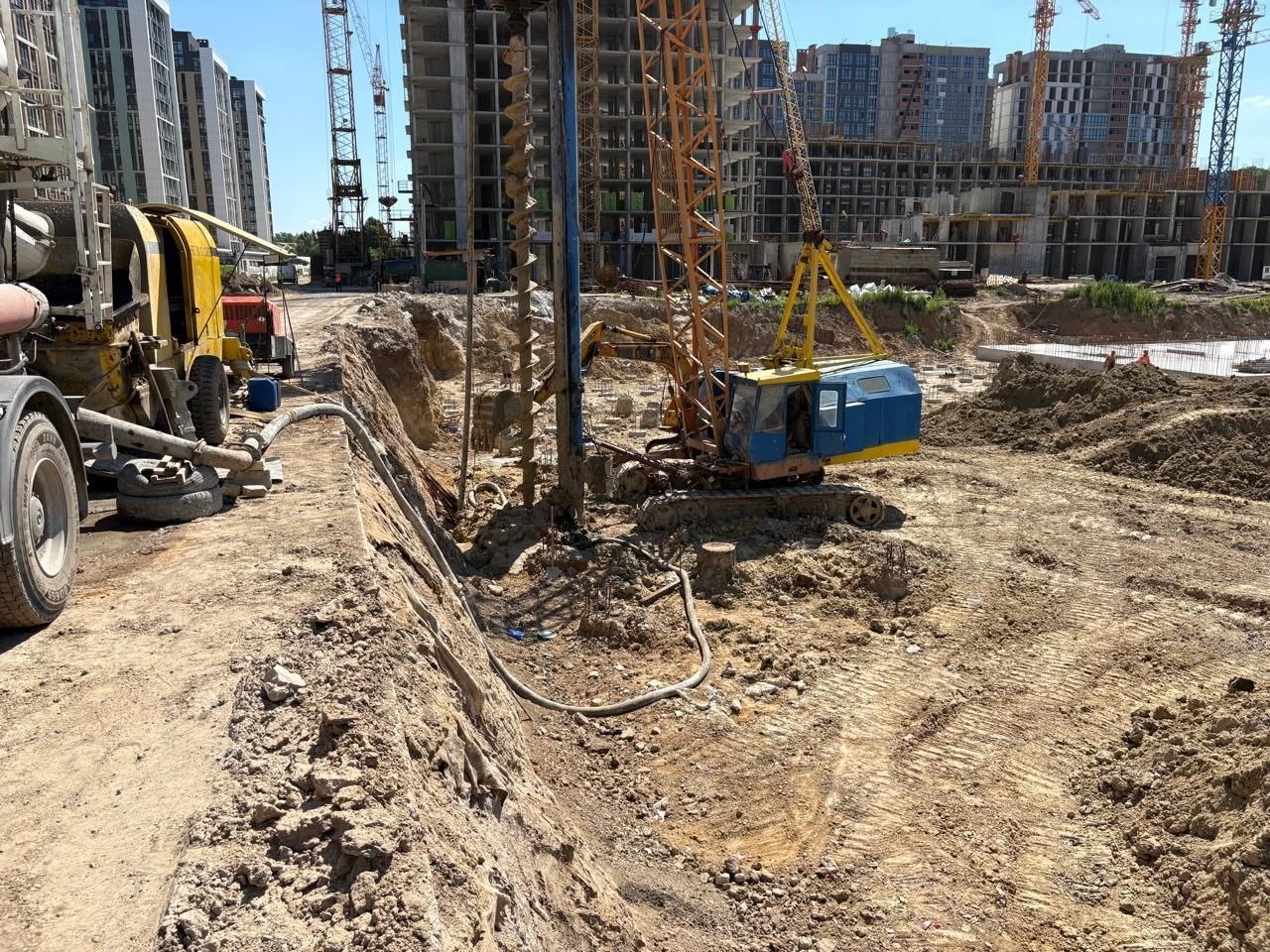

SECTION 5, 4, 3 – pile field installation completed, preparation for grillage slab reinforcement
SECTION 2, 1 – 1st floor completed

Take care and trust the Ukrainian Armed Forces! ❤️ Everything will be Ukraine!
New
New
New
New
New
New
New
New
New
New
New
New
November 2022
Masonry work has begun in Building C! Winter is coming, so it's time to make some tea, wrap yourself in a blanket, and check out our November construction site photo report:

CONSTR. 1, STAGE 1
SECTION 15, 14 – masonry work on all floors!
SECTION 13 – Reinforcement and concreting of the 5th floor vertical
SECTION 12 – Preparation for formwork for the 2nd floor slab
SECTION 11, 10 – Start of masonry work on floors 2-5
SECTION 9 – Preparation for concreting the grillage slab
SECTION 8 – Preparation for reinforcing the basement vertical
SECTION 7, 6 – 1st floor completed, preparation for reinforcing the 2nd floor vertical
SECTION 5, 4, 3 – Pile field installation completed, preparation for grillage slab reinforcement
SECTION 2 – Concreting of the 1st floor slab completed
SECTION 1 – Reinforcement and concreting of the 1st floor slab

Take care and trust the Ukrainian Armed Forces! ❤️ Everything will be Ukraine!
New
New
New
New
New
New
New
New
New
New
New
New
New
October 2022
It's already October, so we're making the most of the warmer weather to complete masonry and monolithic work. In the meantime, we're sharing with you the first autumn photo report from the construction site:

CONSTR. 1, STAGE 1
SECTIONS 15, 14 – parapet concreting complete! Stone work has begun
SECTION 13 – Concreting the 3rd floor slab
SECTION 12 – Concreting the 1st floor vertical
SECTION 11, 10 – Concreting the 10th floor slab
SECTION 9 – Preparing for the grillage slab concreting
SECTION 8 – Preparing for the basement vertical reinforcement
SECTION 7, 6 – 1st floor completed, preparing for the 2nd floor vertical reinforcement
SECTION 5, 4, 3 – Pile field installation completed, preparing for the grillage slab reinforcement
SECTION 2 – Basement vertical concreting completed
SECTION 1 – Basement floor slab concreting completed

Put on your hat and believe in the Armed Forces of Ukraine! ❤️ Everything will be Ukraine!
New
New
New
New
New
New
New
New
New
New

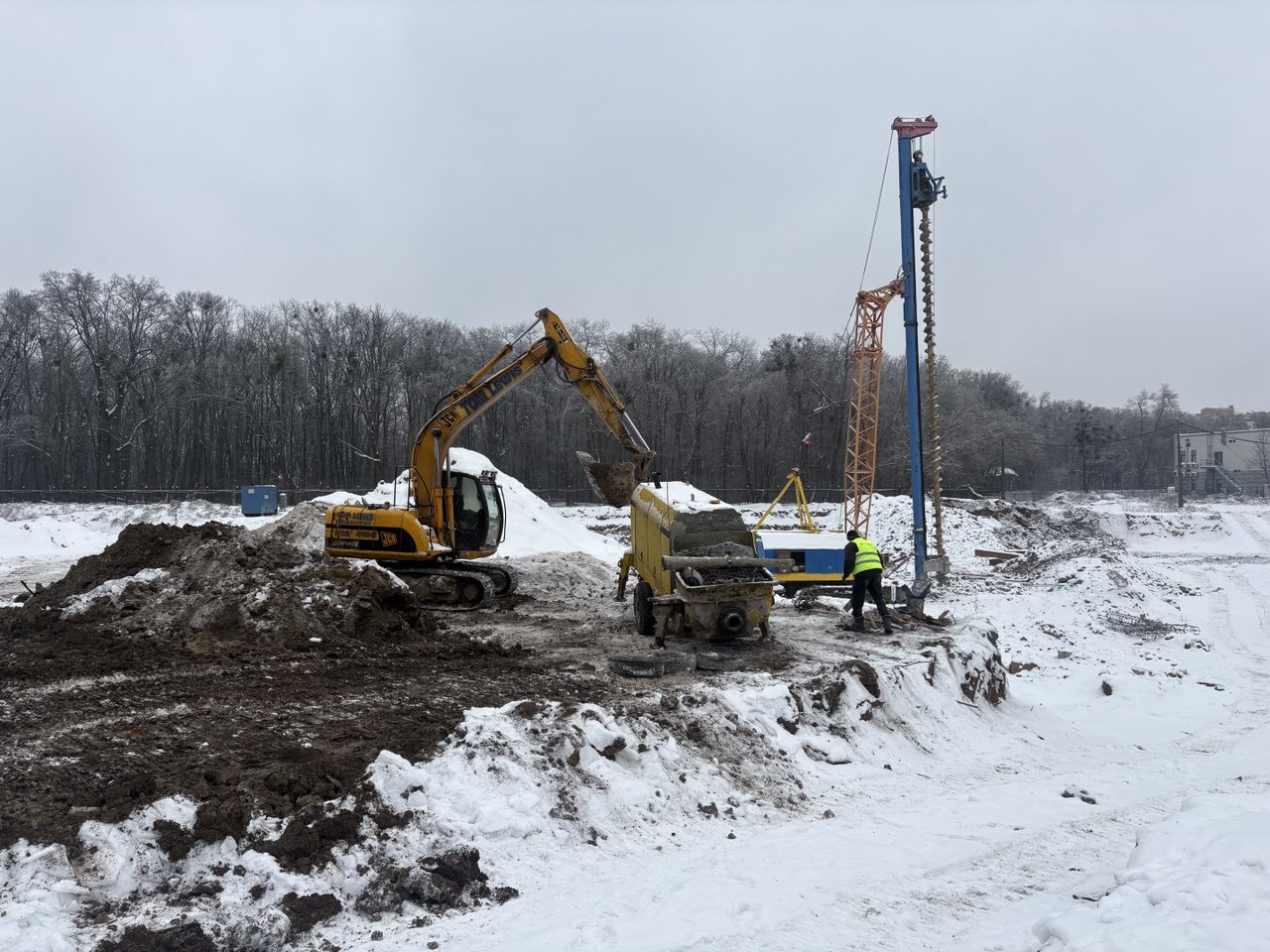

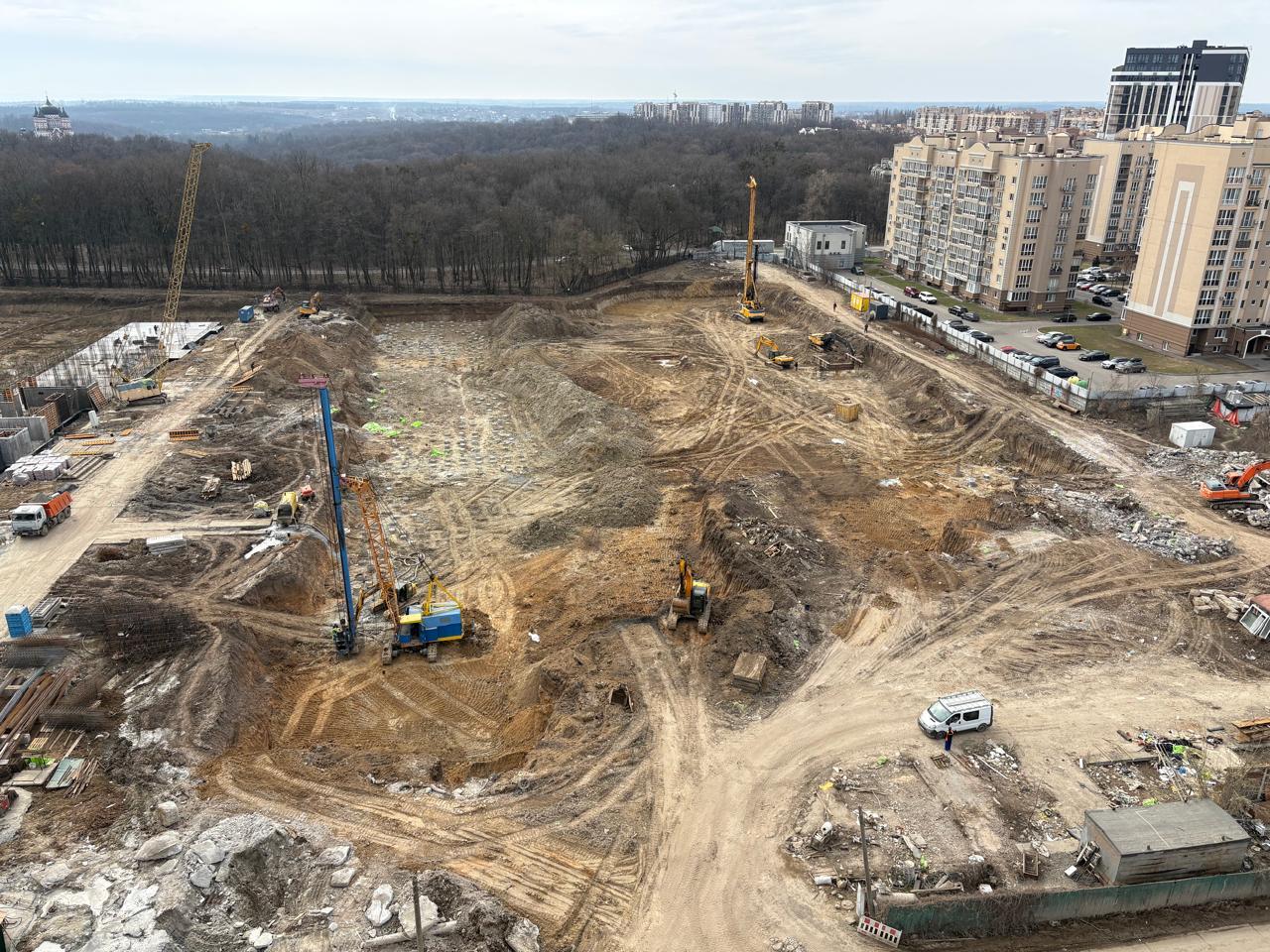

July 2022

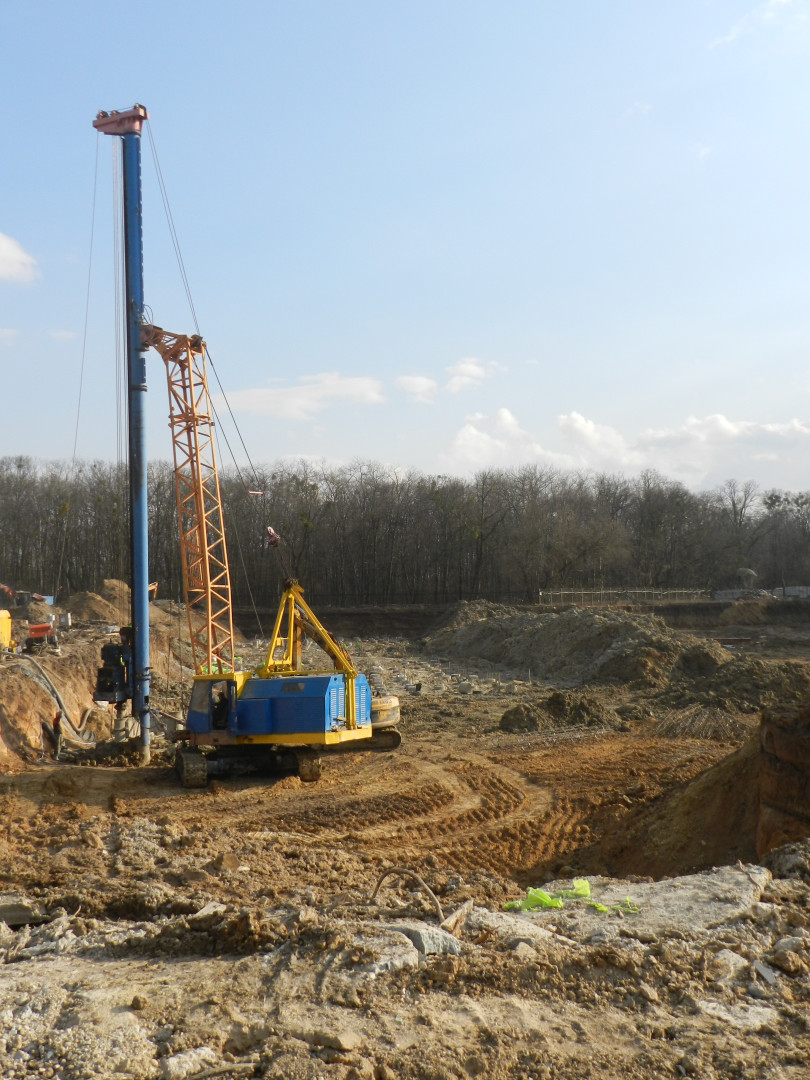

We resumed work at our construction site in July, and it's time to share some fresh details with you:

CONSTR. 1, STAGE 1
SECTION 15 – Completion of parapet concreting
SECTION 14 – Parapet concreting
SECTION 13 – Formwork installation and basement vertical concreting
SECTION 12 – Foundation completed, preparing for basement vertical reinforcement
SECTION 11 – 10th floor vertical concreting
SECTION 10 – 10th floor slab reinforcement
SECTION 9 – Grillage slab reinforcement
SECTION 8 – Foundation completed, preparing for basement vertical reinforcement

Take care of yourself and your families, and believe in the Armed Forces of Ukraine!
❤️ Everything will be Ukraine!
New
New
New
New
New
New
New
New
New
New
New

January 2022
Check out the first photos from the construction site in the new year!

CONSTR. 1, STAGE 1
SECTION 15 – 13th floor vertical concreting completed
SECTION 14 – 13th floor vertical concreting completed
SECTION 13 – grillage slab reinforcement
SECTION 12 – pile field installation completed
SECTION 11 – 6th floor slab concreting
SECTION 10 – 7th floor vertical concreting
SECTION 9 – pile field installation
SECTION 8 – grillage slab concreting, preparation for basement vertical reinforcement
SECTIONS 1-2, 6-7 – foundation completed, preparation for monolithic work

DECEMBER 2021
The last days before New Year's have arrived: all the presents have been wrapped, the tangerines have been peeled, and the mayonnaise for the Olivier salad has been purchased. Let's take stock of the year together and admire how quickly our building 1 is being built:

CONSTR. 1, STAGE 1
SECTION 15 – 13th floor vertical concrete pour
SECTION 14 – 13th floor vertical reinforcement, formwork installation for concreting
SECTION 13 – pile field installation completed, concrete preparation
SECTION 12 – pile field completion
SECTION 11 – 6th floor floor slab reinforcement and concreting
SECTION 10 – 6th floor slab concreting
SECTION 9 – pile field installation
SECTION 8 – grillage slab reinforcement
SECTIONS 1-2, 6-7 – foundation completed, preparation for monolithic work
New
New
New
New
New
New
New
New
November 2021
November crept up unnoticed, bringing with it rain and a refreshing breeze. whispering in your ear: "Winter is coming..."

CONSTR. 1, STAGE 1

• SECTION 15 – concreting the 9th floor vertical
• SECTION 14 – concreting the 10th floor vertical is complete, we are beginning to install the floor slab formwork
• SECTION 13 – installation of the pile field
• SECTION 11 – reinforcement of the 4th floor vertical
• SECTION 10 – concreting the 4th floor vertical
New
New
New
New
New
October 2021
We invite you to view a photo report from the construction site for October 2021:

CONSTR. 1, STAGE 1
• SECTION 15 – concreting the 5th floor vertical and reinforcing the floor slab
• SECTION 14 – concreting the 5th floor vertical
• SECTION 11 – concreting the 1st floor vertical
• SECTION 10 – concreting the 1st floor vertical and reinforcing the floor slab floors, preparation for concreting the core
New
New
New
New
New
New
New
New
New
New
New
New
Feedback
Leave your phone number, our manager will contact you
Send
Thank you for your request!
Wait for a call
Please wait, data is being processed.
Переверніть Ваш пристрій
в горизонтальне положення

The site uses cookies and personal data collection services to provide you with maximum convenience and improve the quality of service. ​By continuing to use our website, you consent to the use of data.Read more about the rules for the use of cookies and the Terms of personal data processing

Ok
